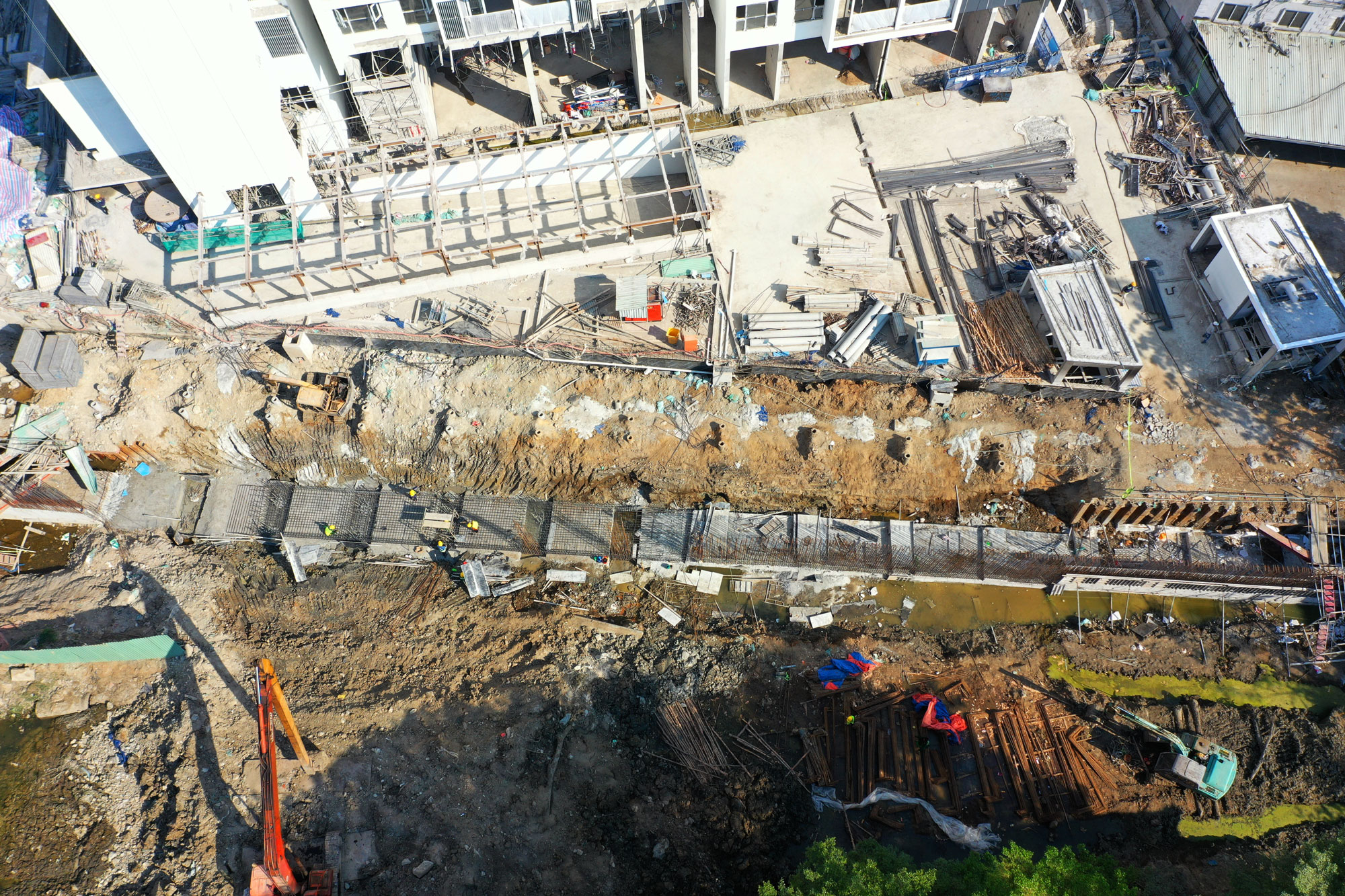

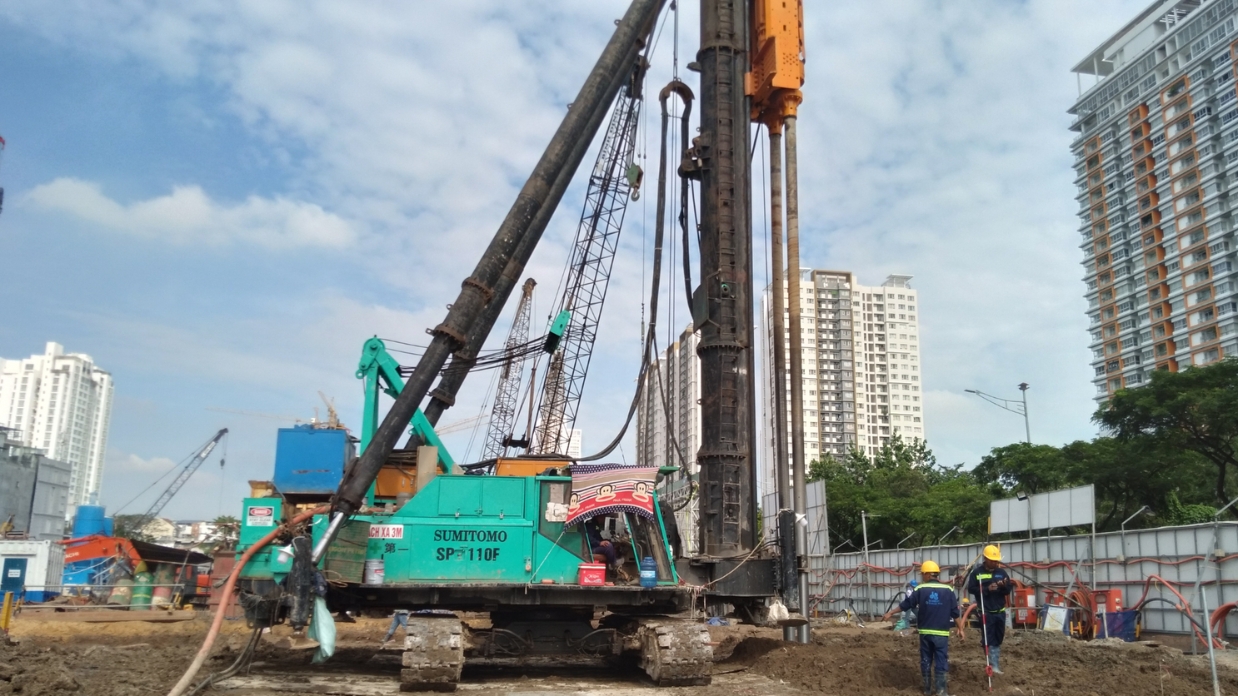

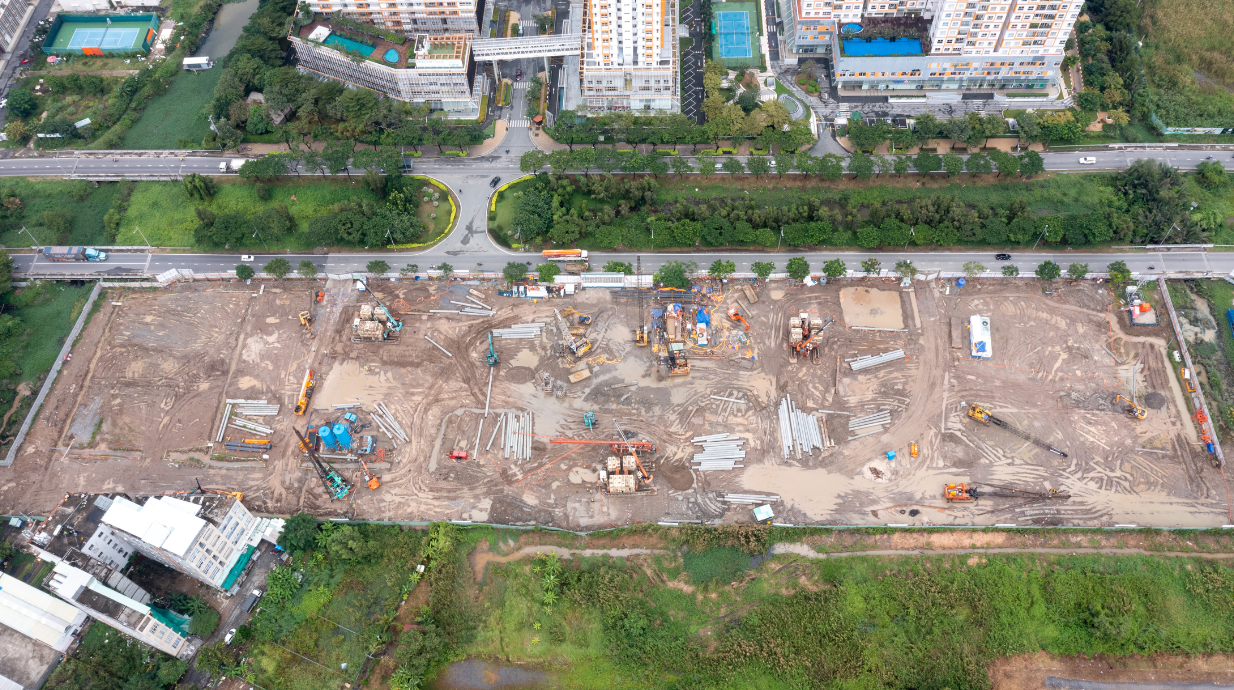

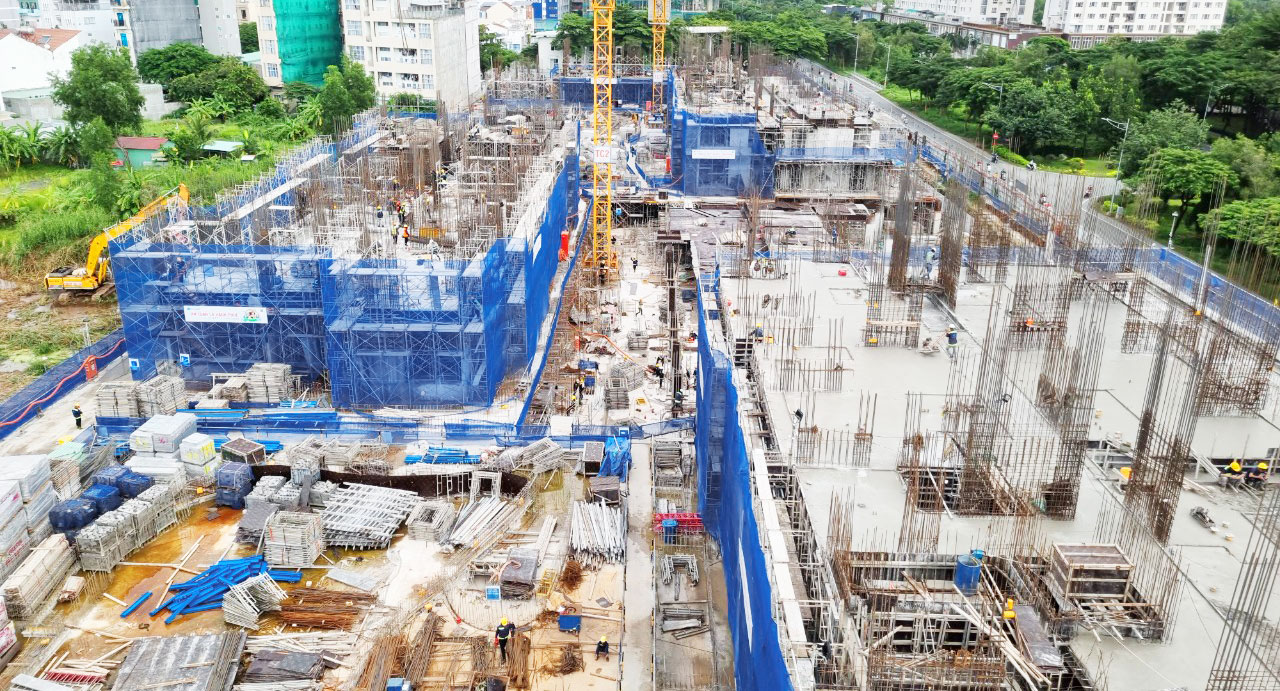

CDM test pile works for method of basement excavation

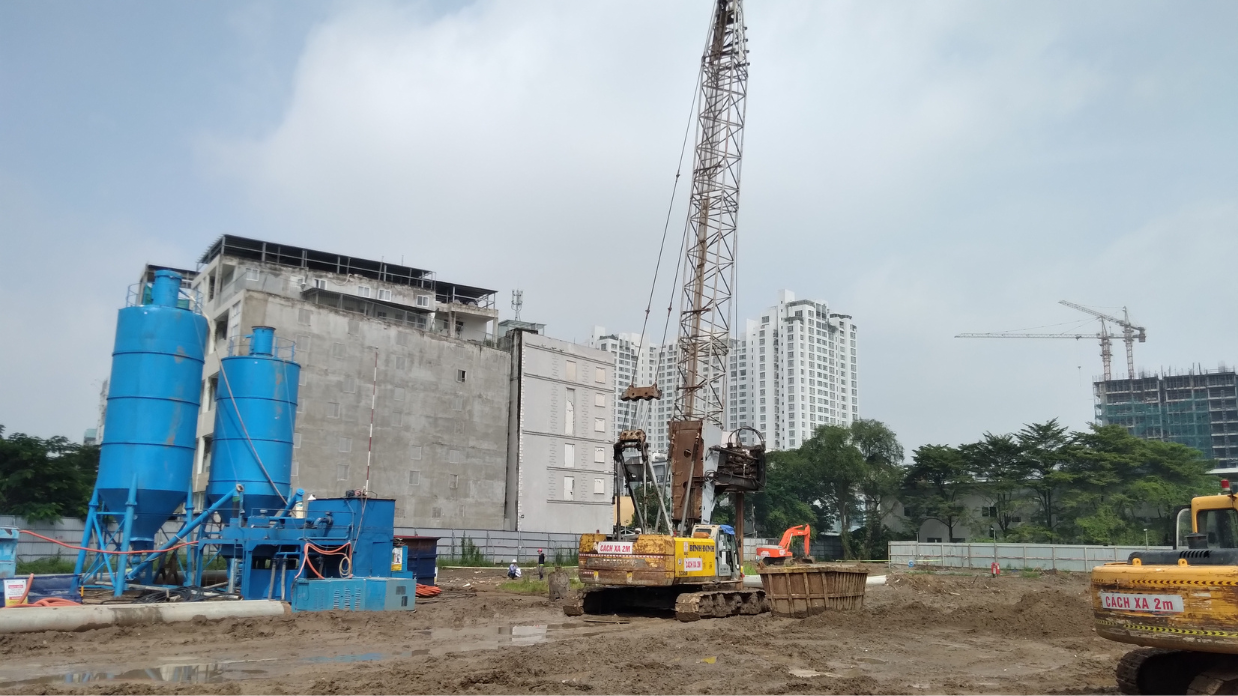

Piling works for crane foundation

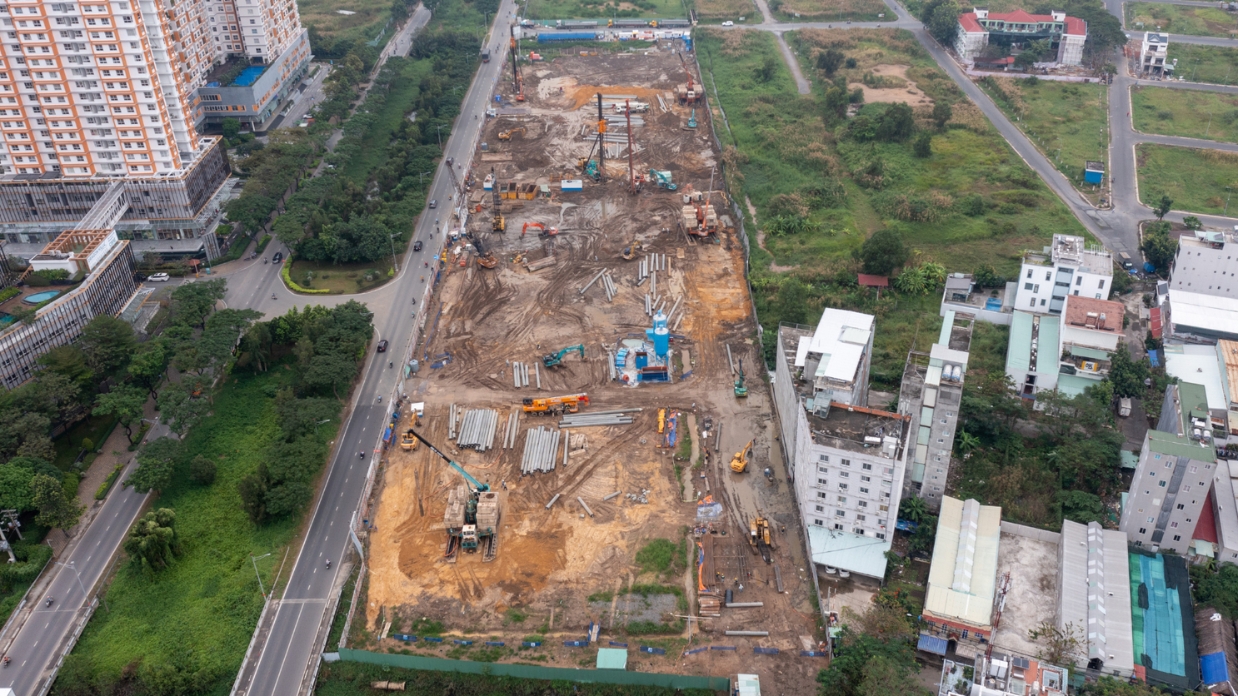

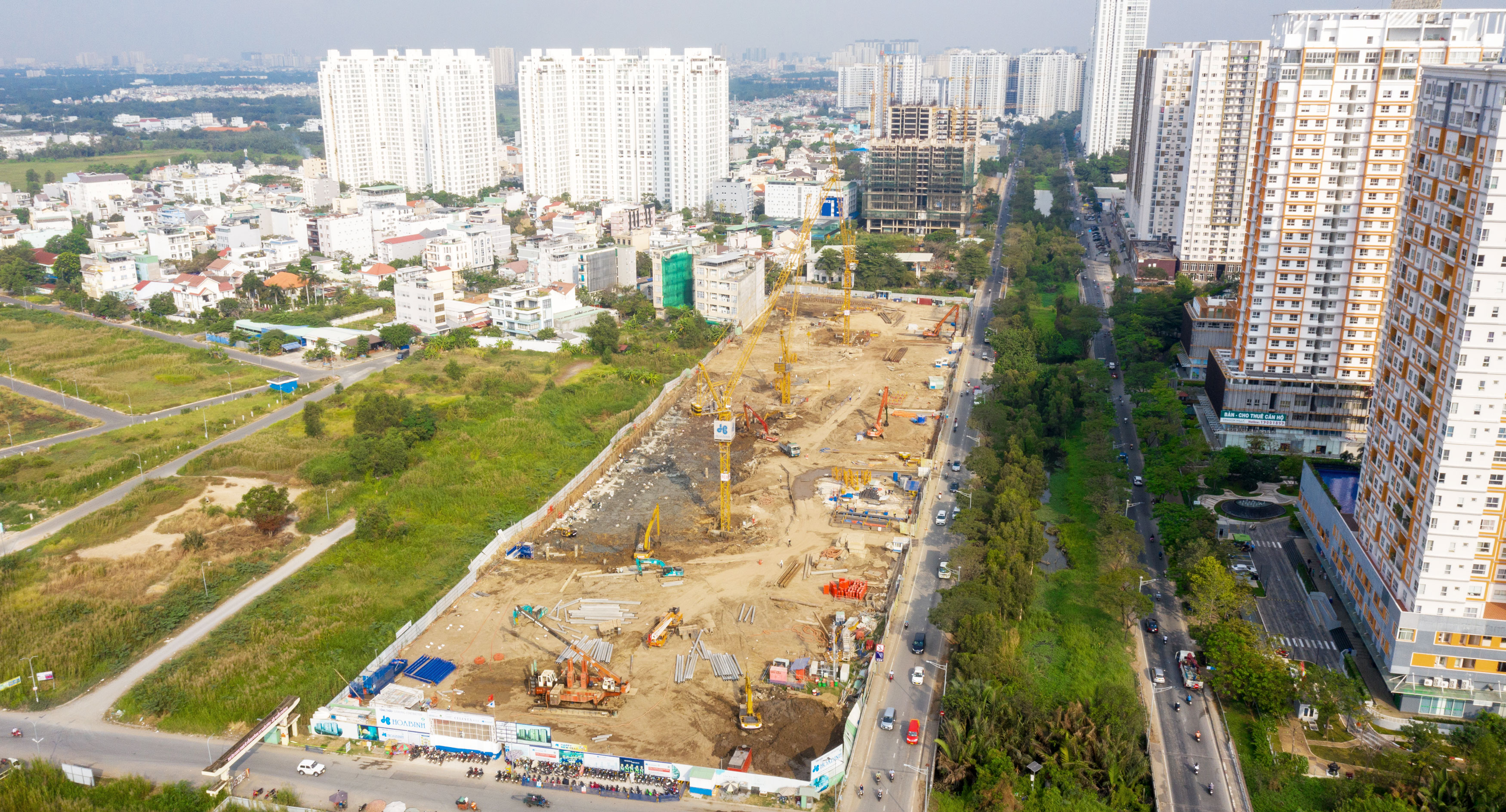

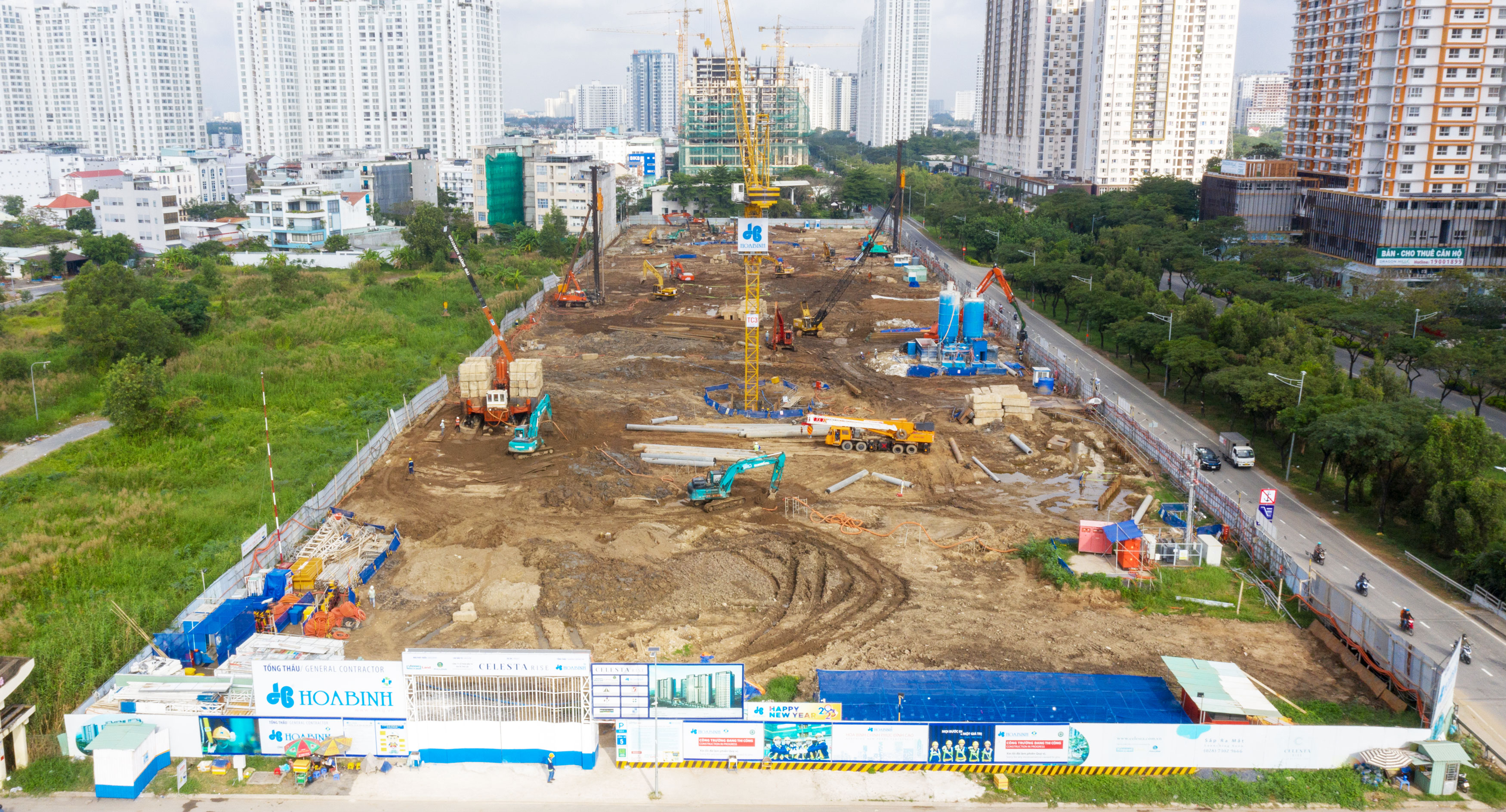

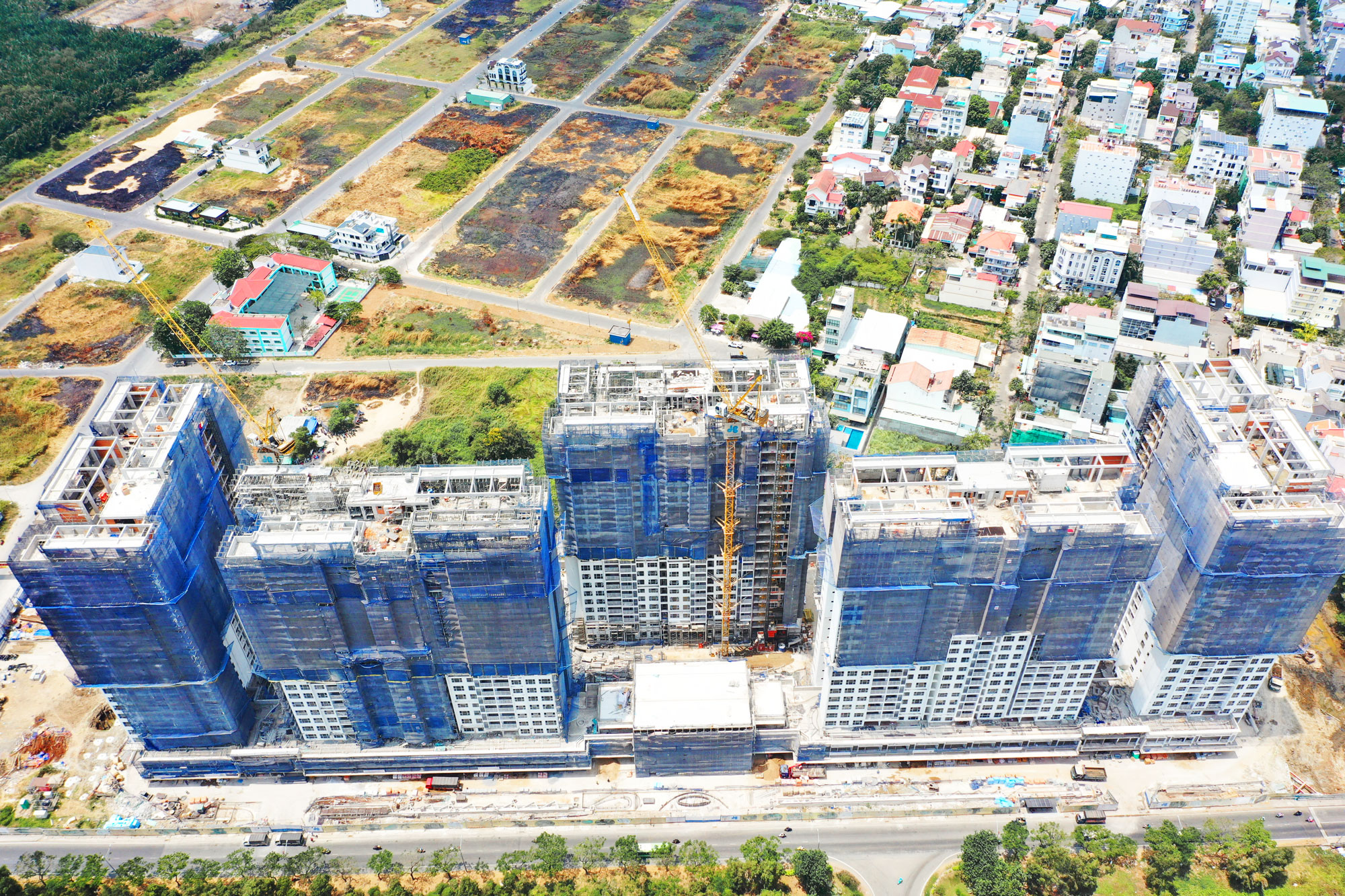

Construction site overview

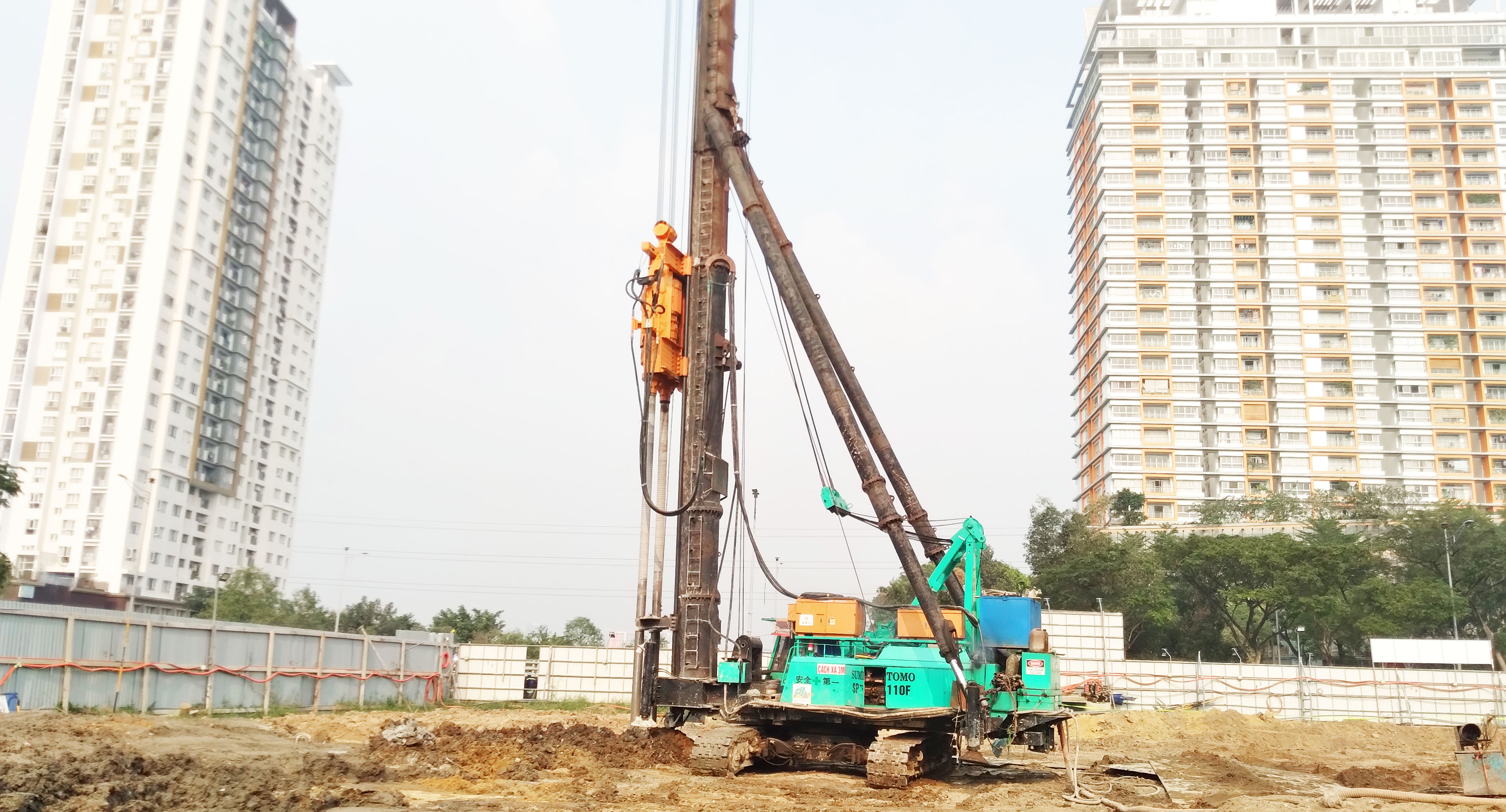

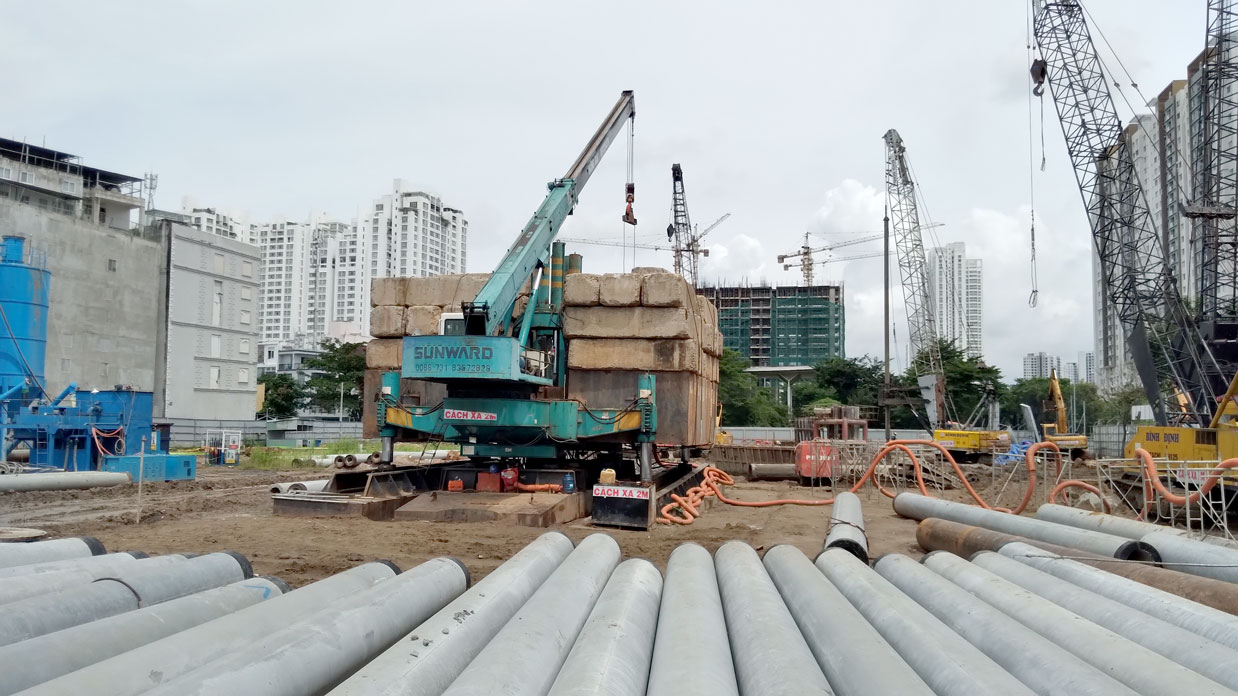

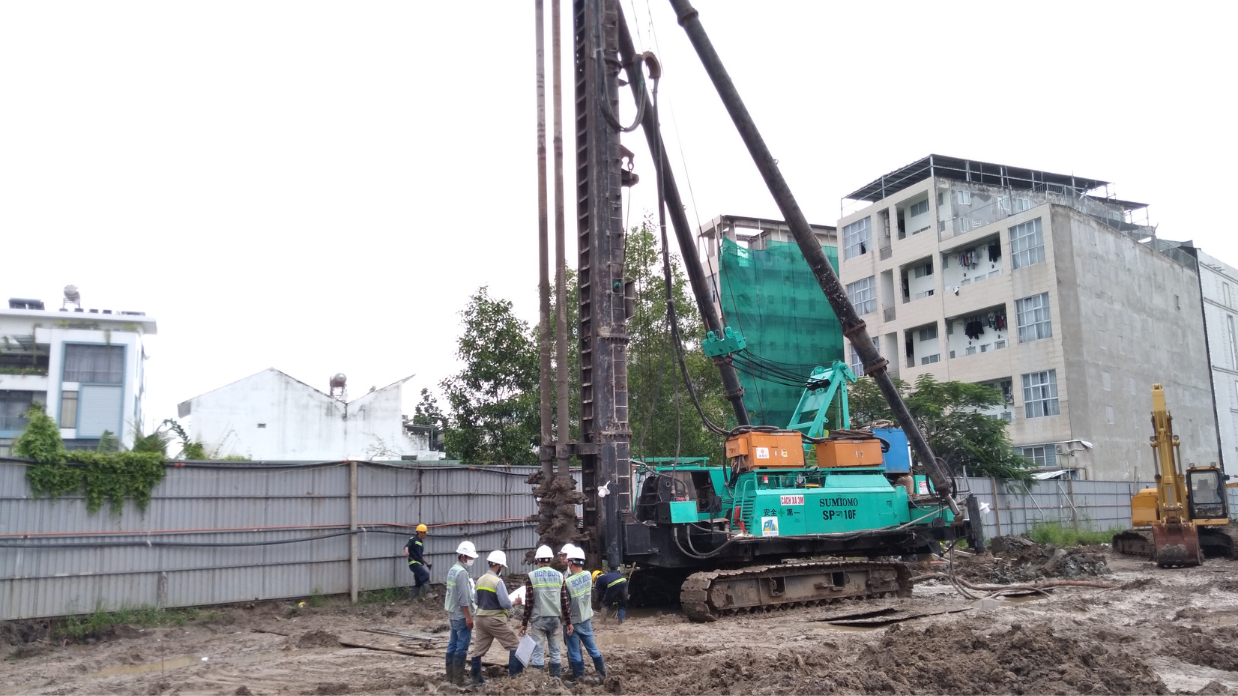

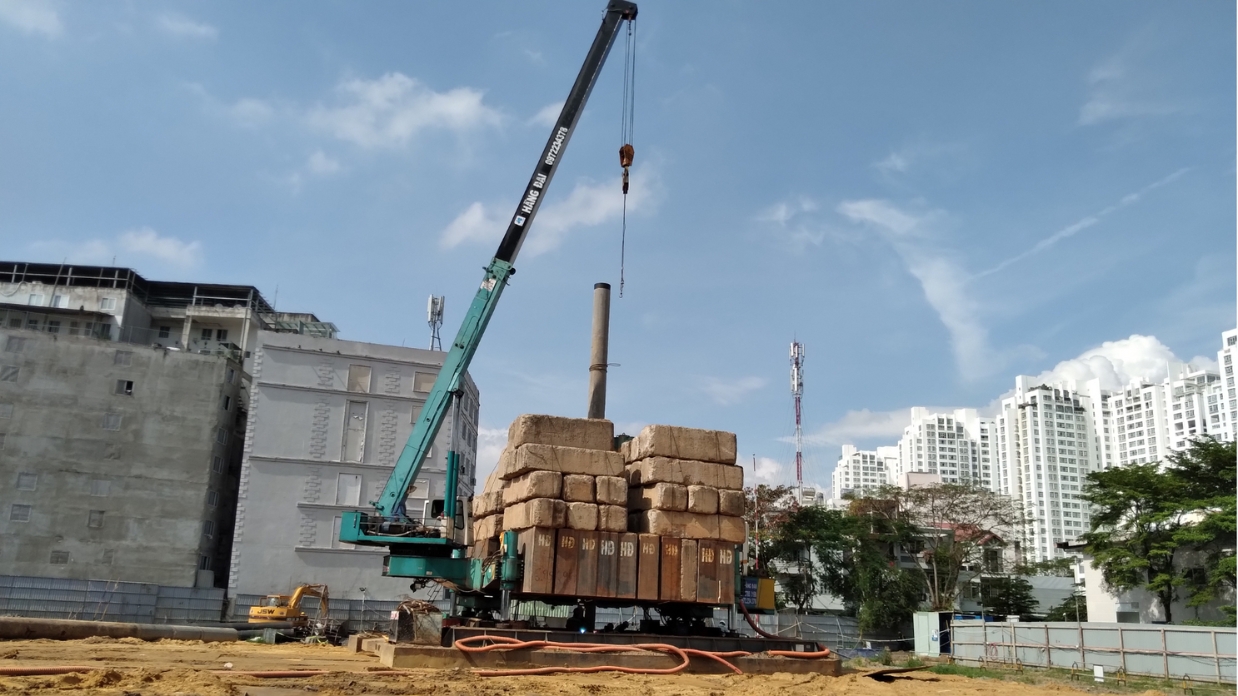

CDM piling works for method of basement excavation
Project construction site

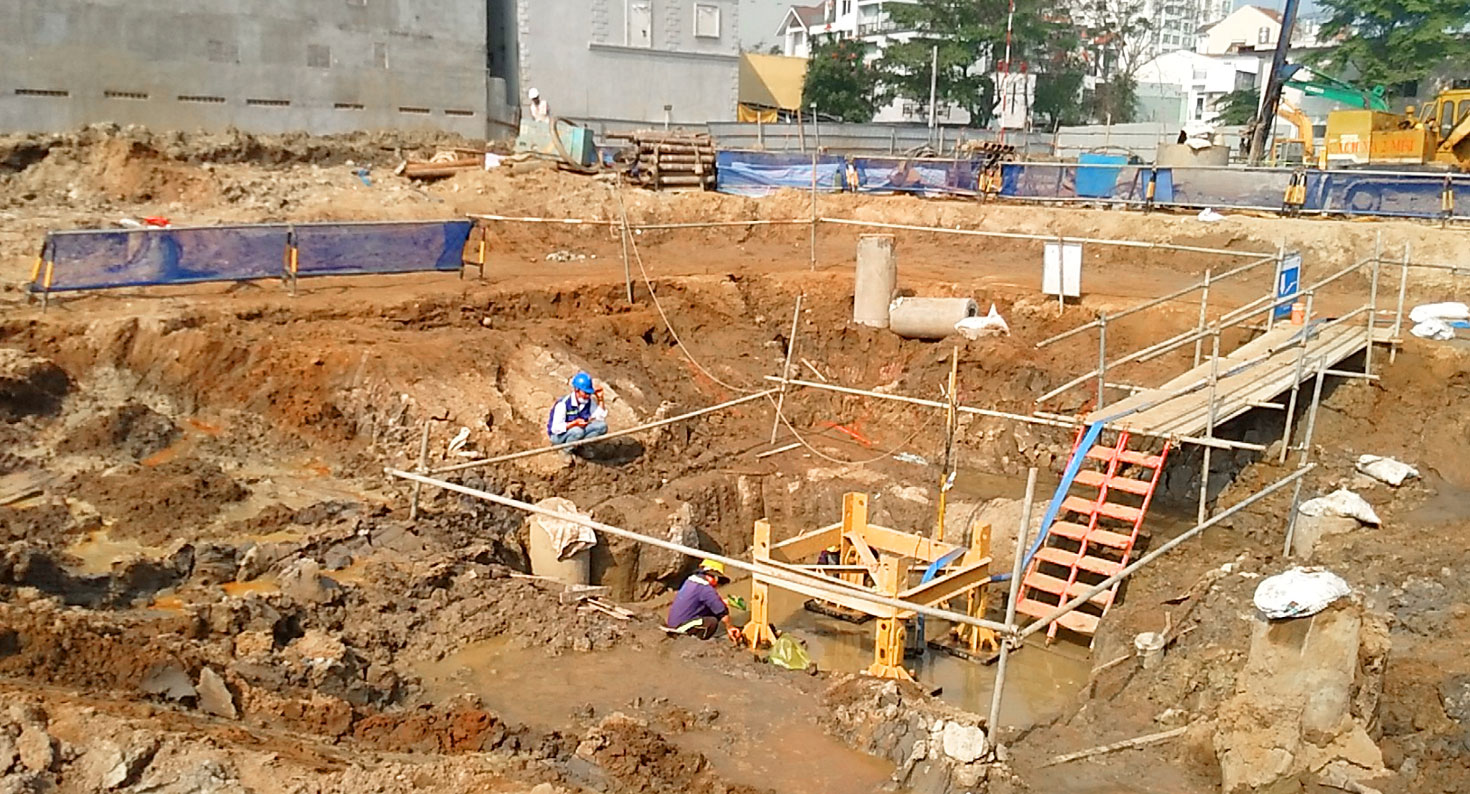

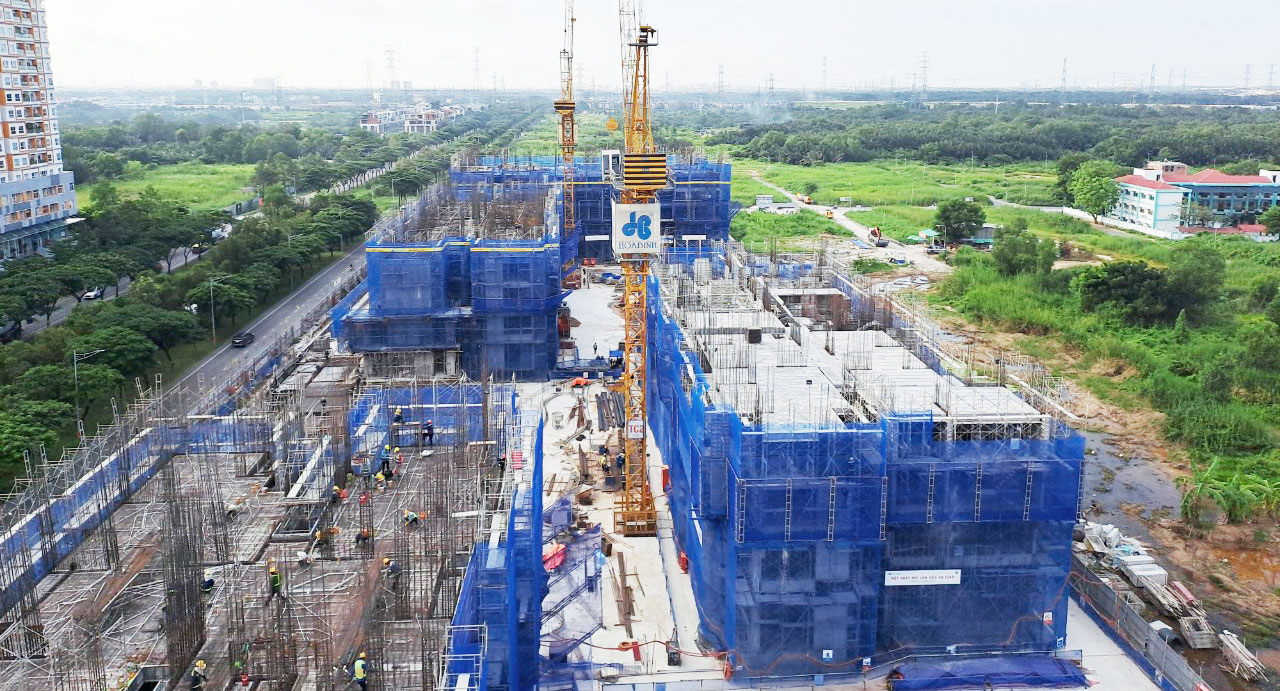

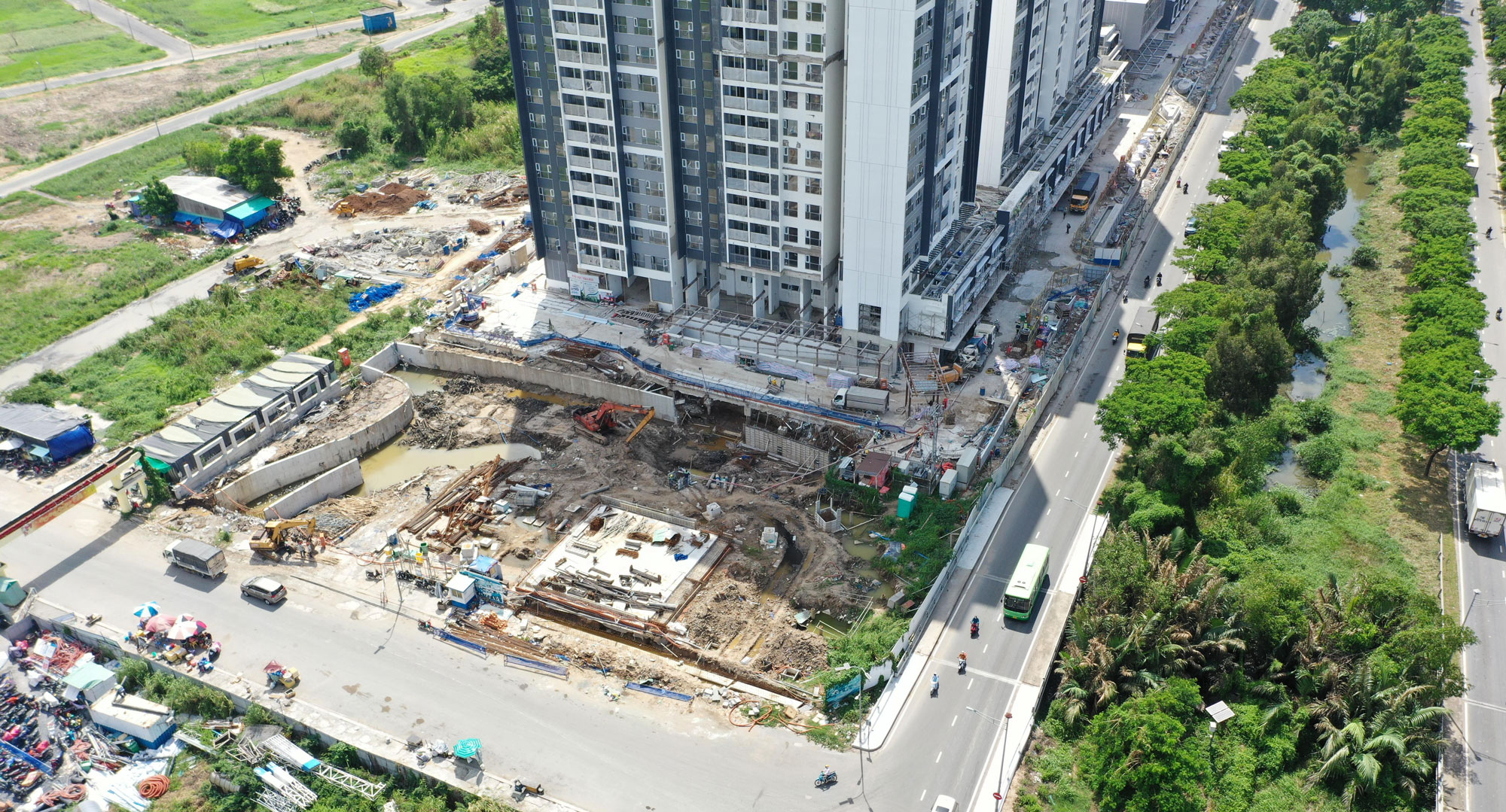

CDM work for basement excavation

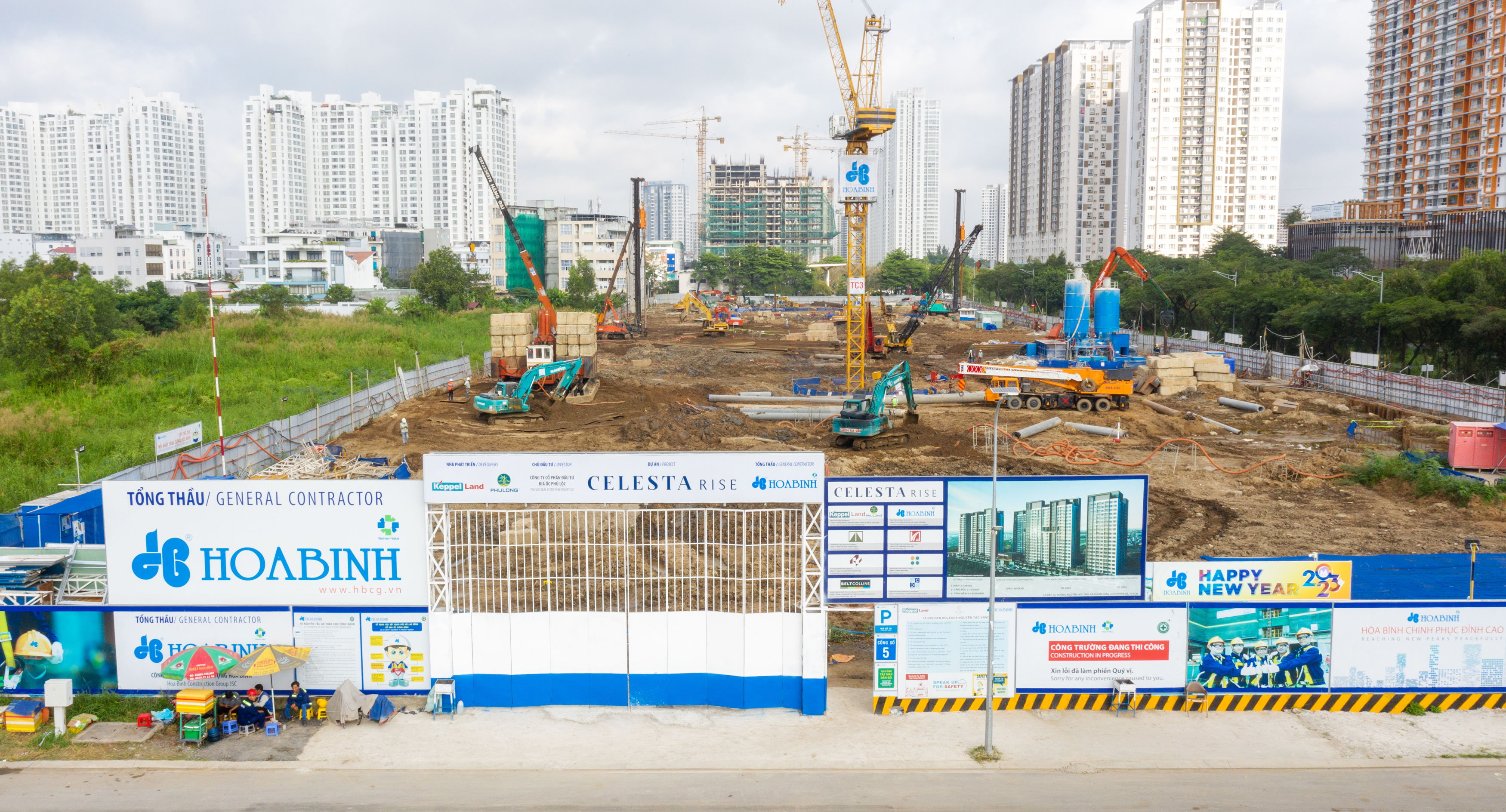

Overall construction site

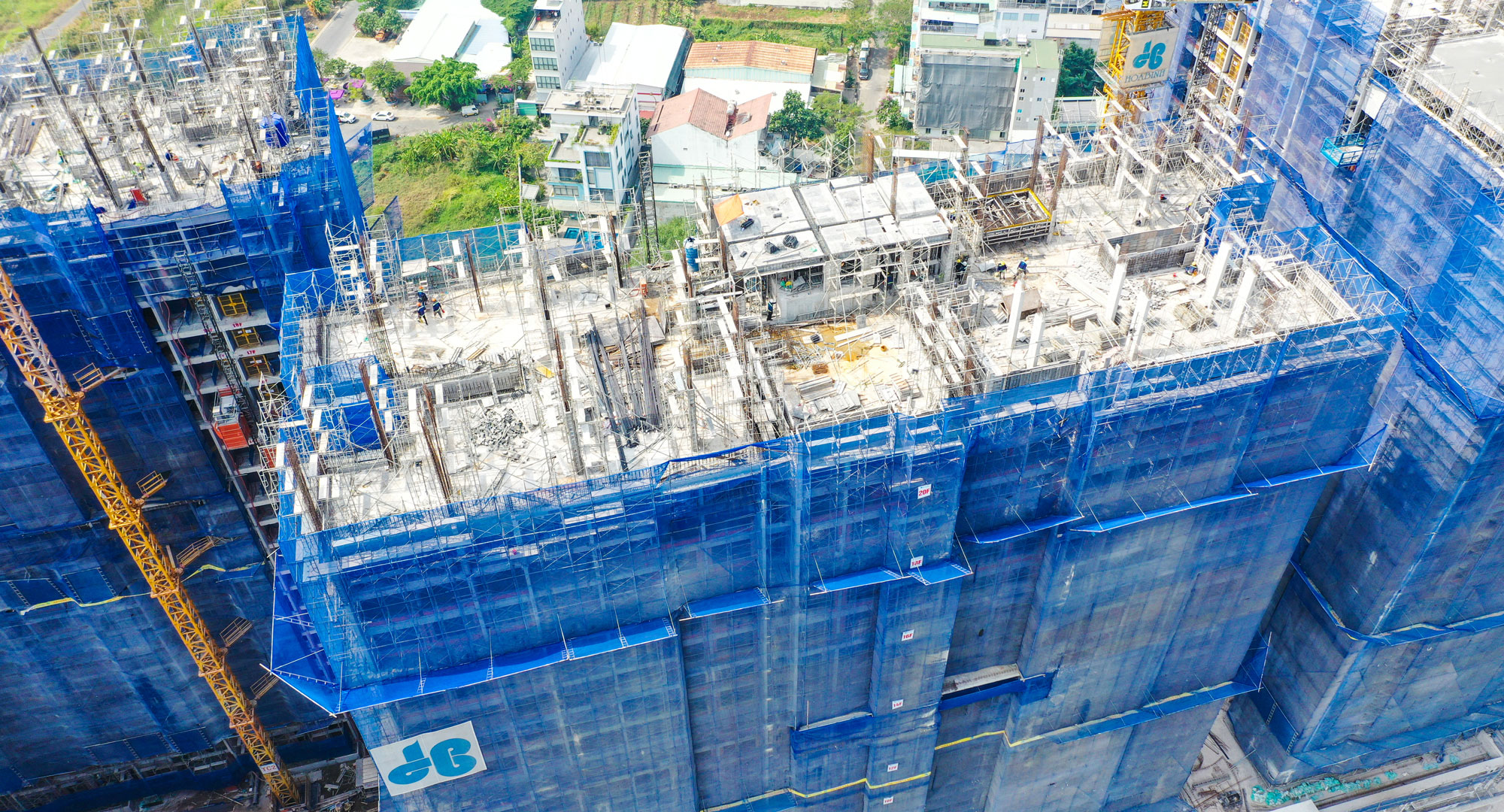

CDM work for basement excavation of Tower 1 is in progress

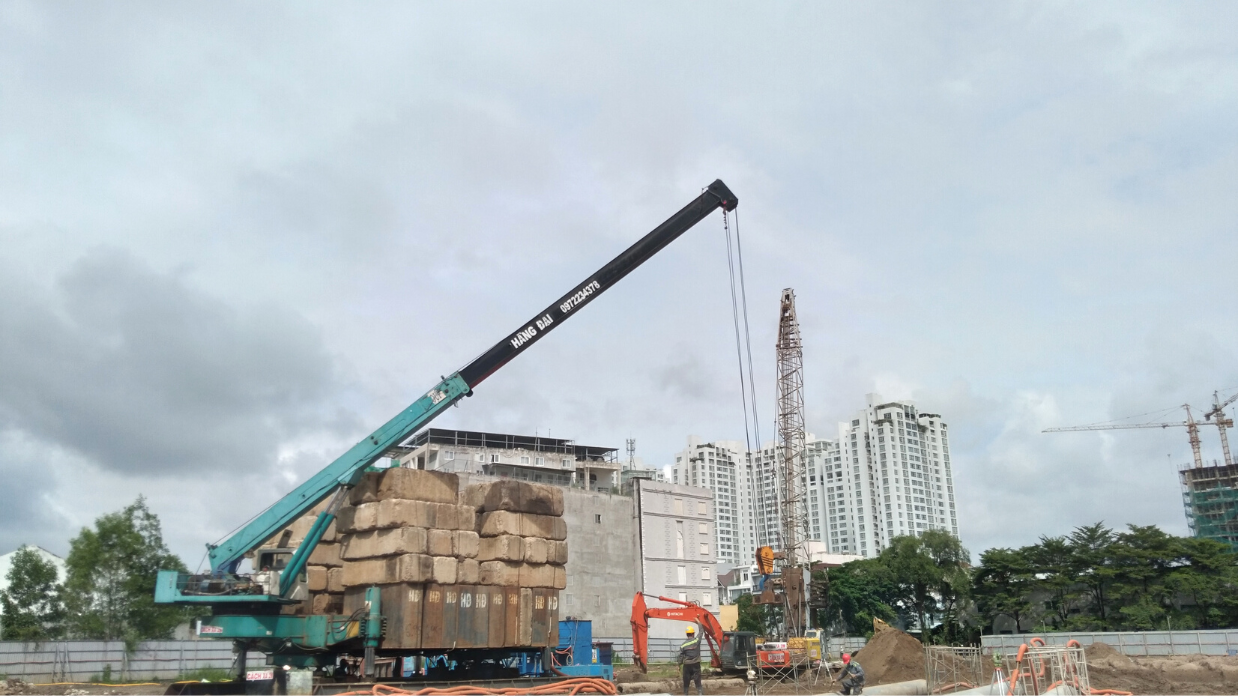

Excavation work for crane's foundation of Tower 2 is in progress

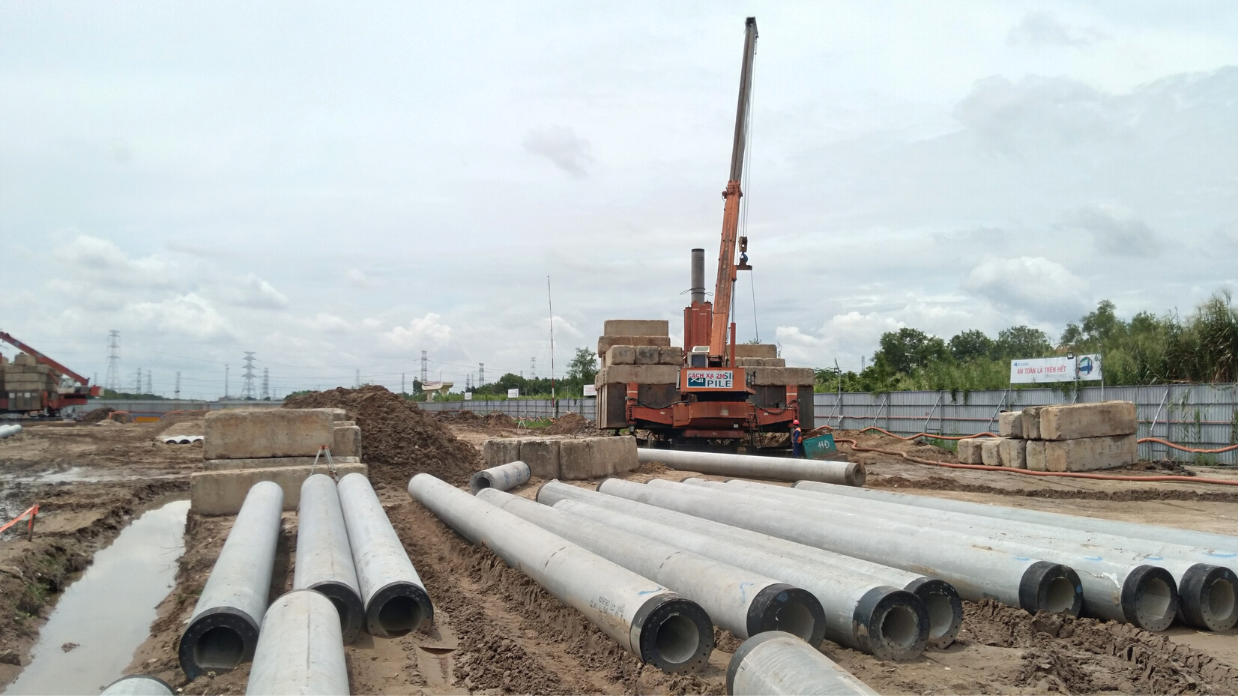

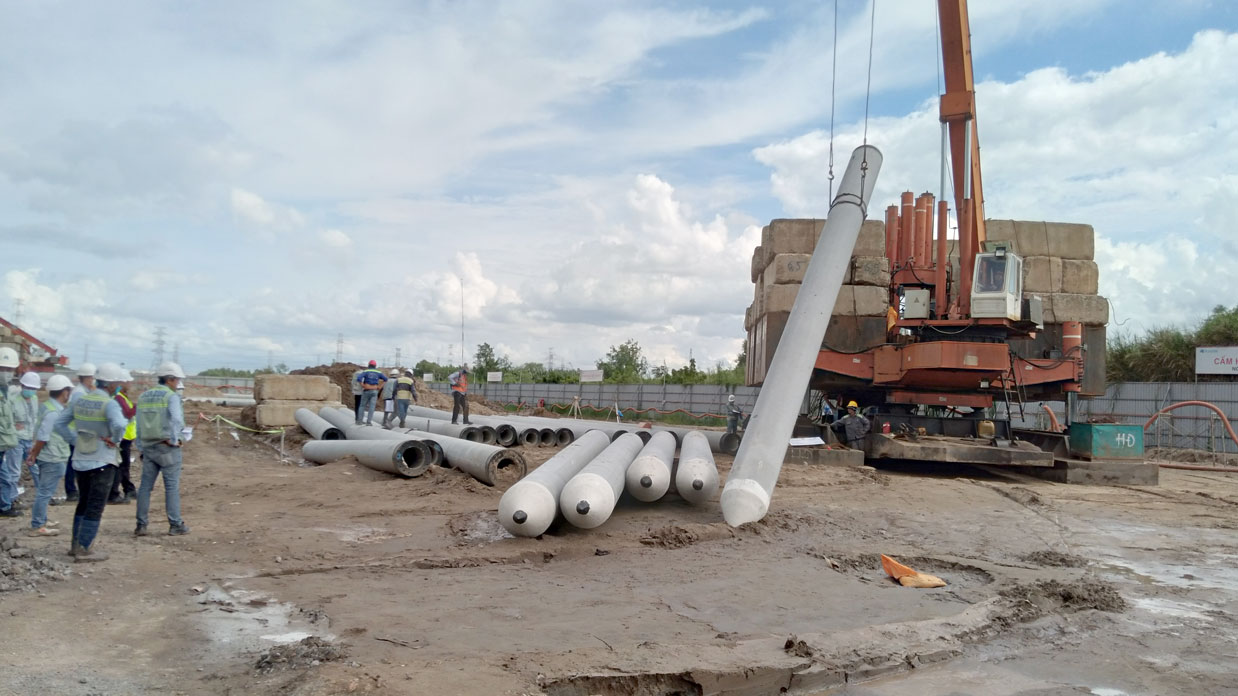

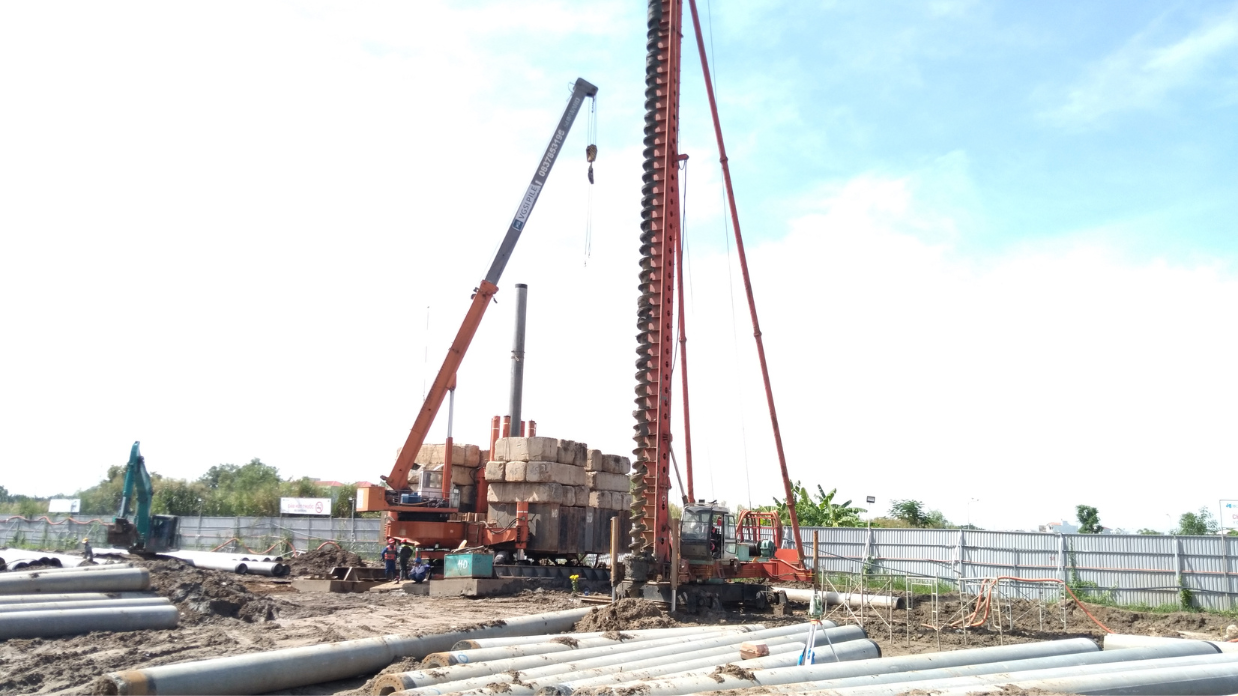

Steel sheet pile driving for excavation of Tower 3 is in progress

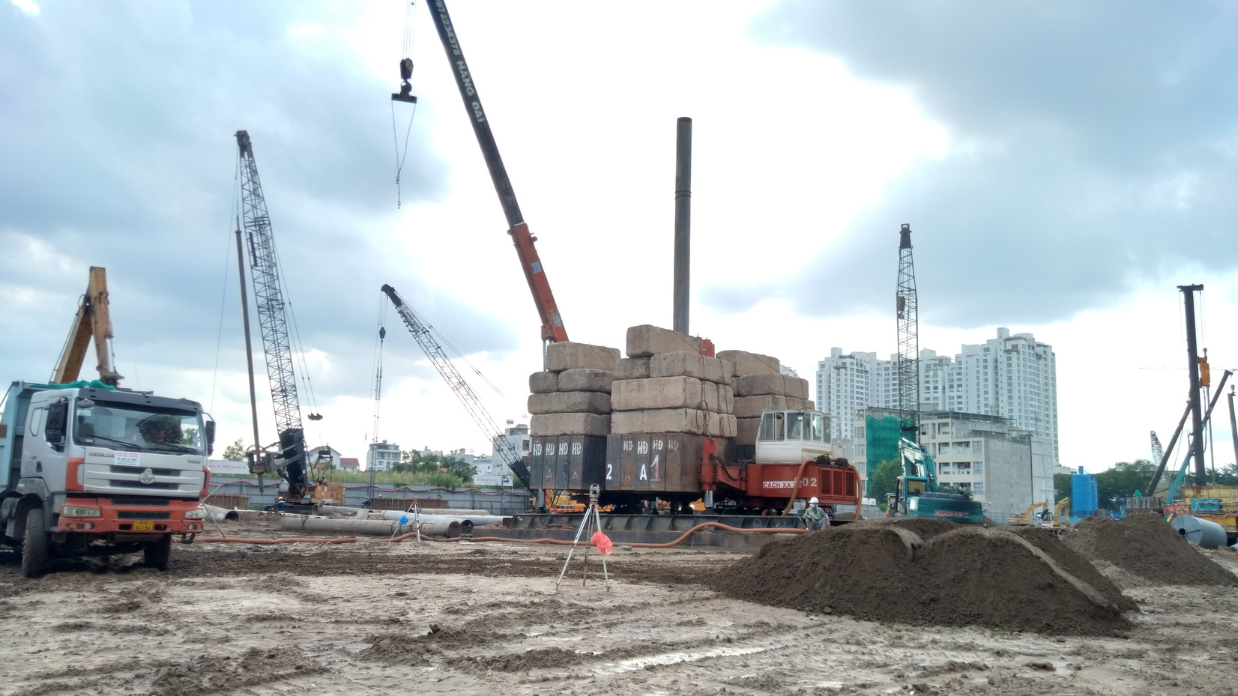

Tower crane erection of Tower 4 is in progress

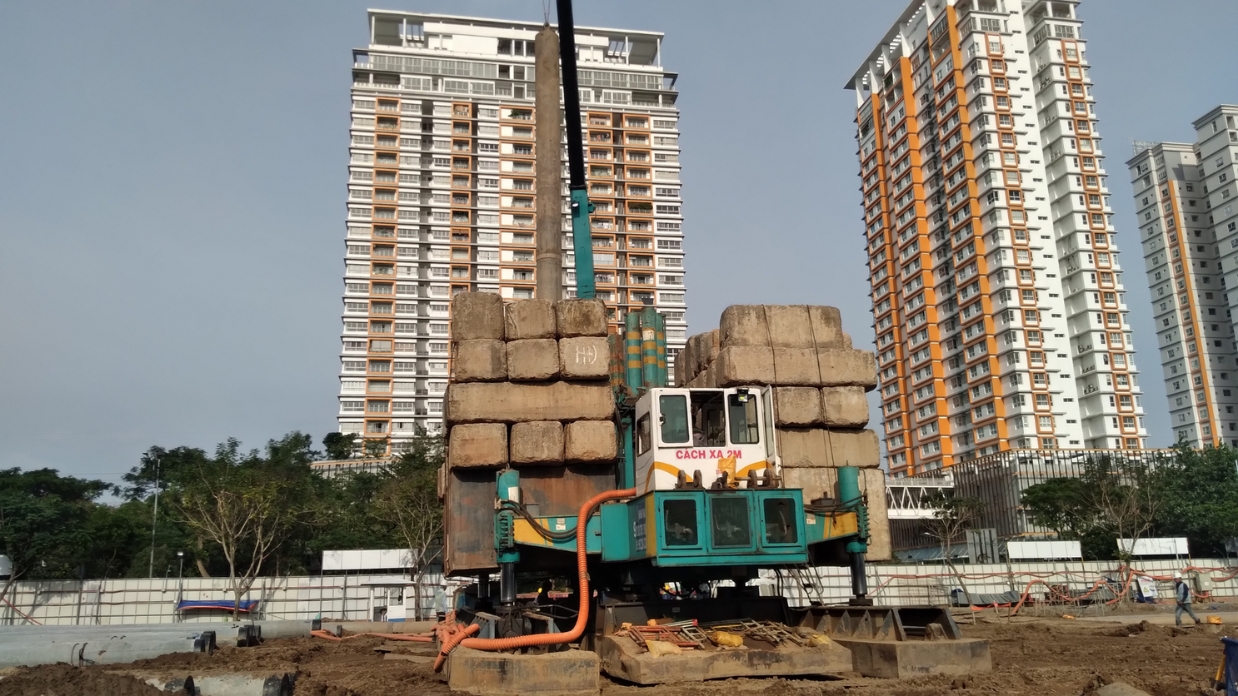

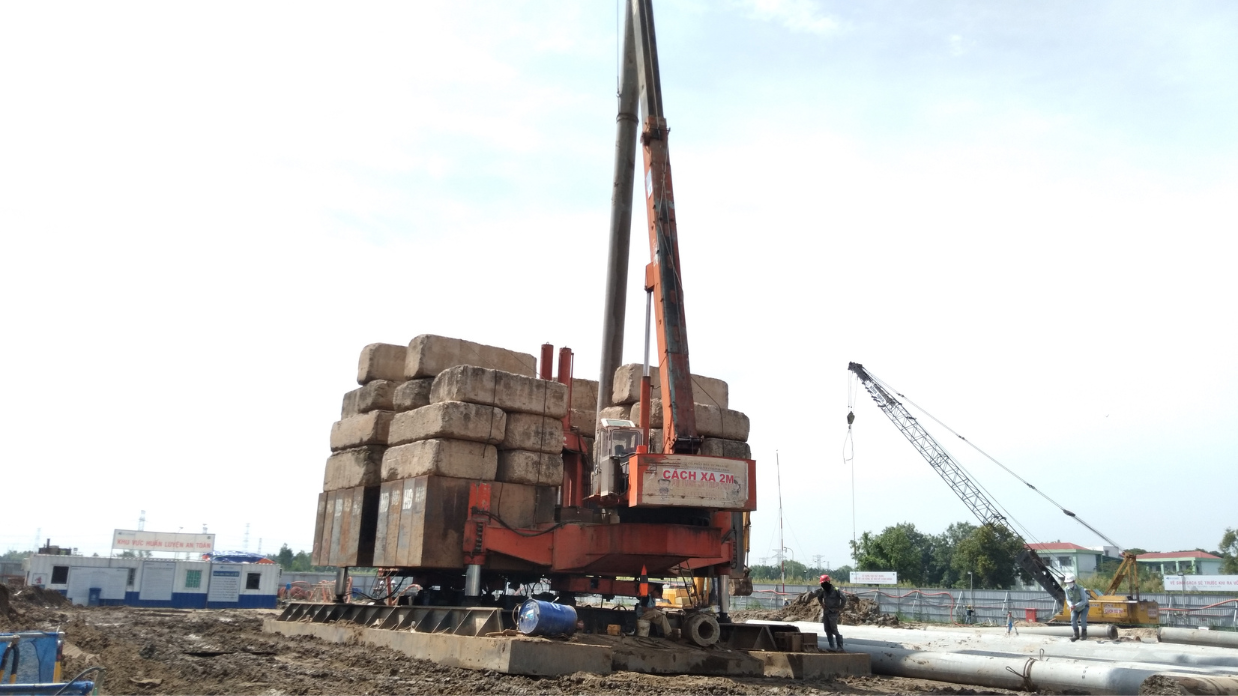

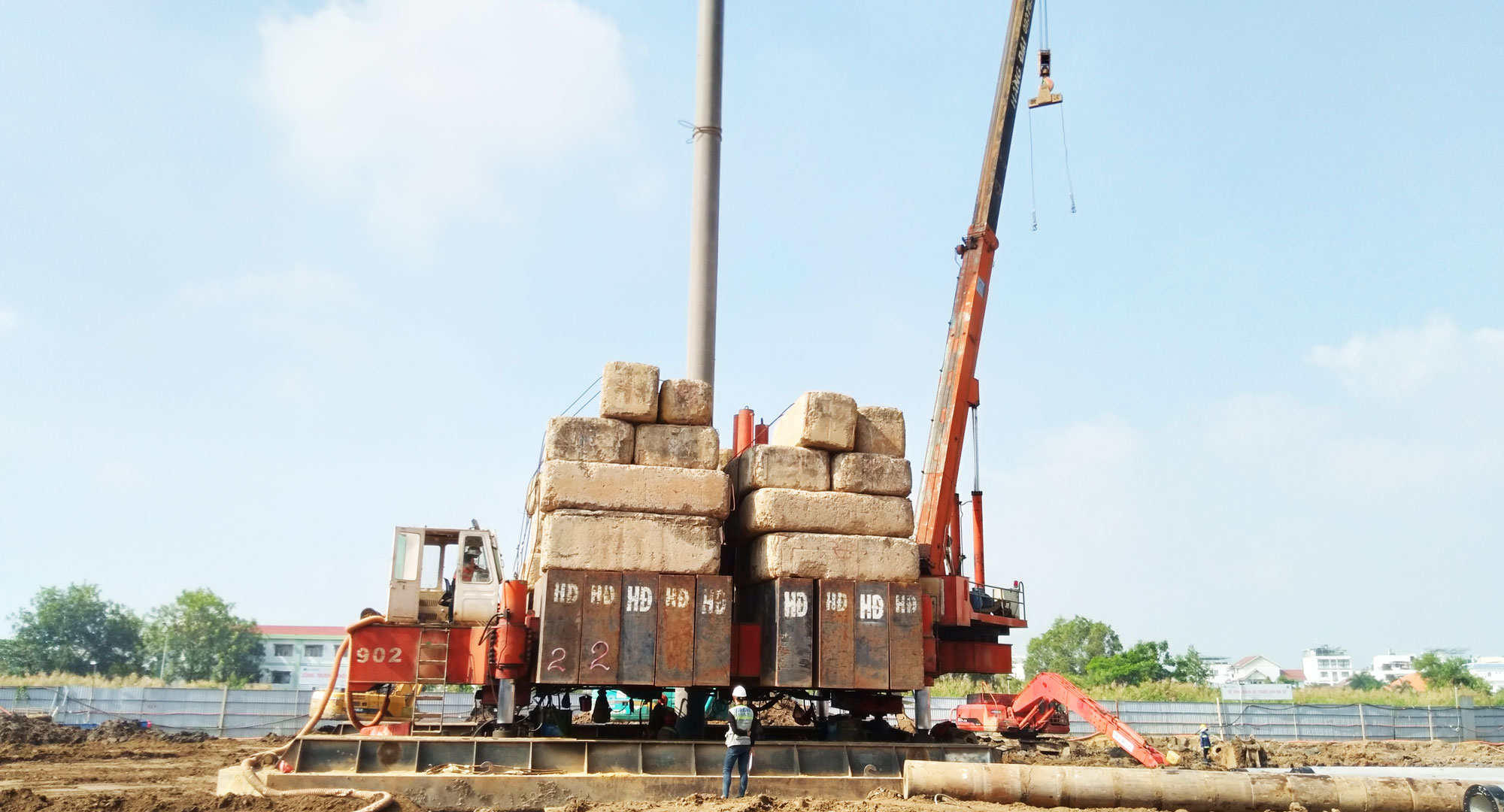

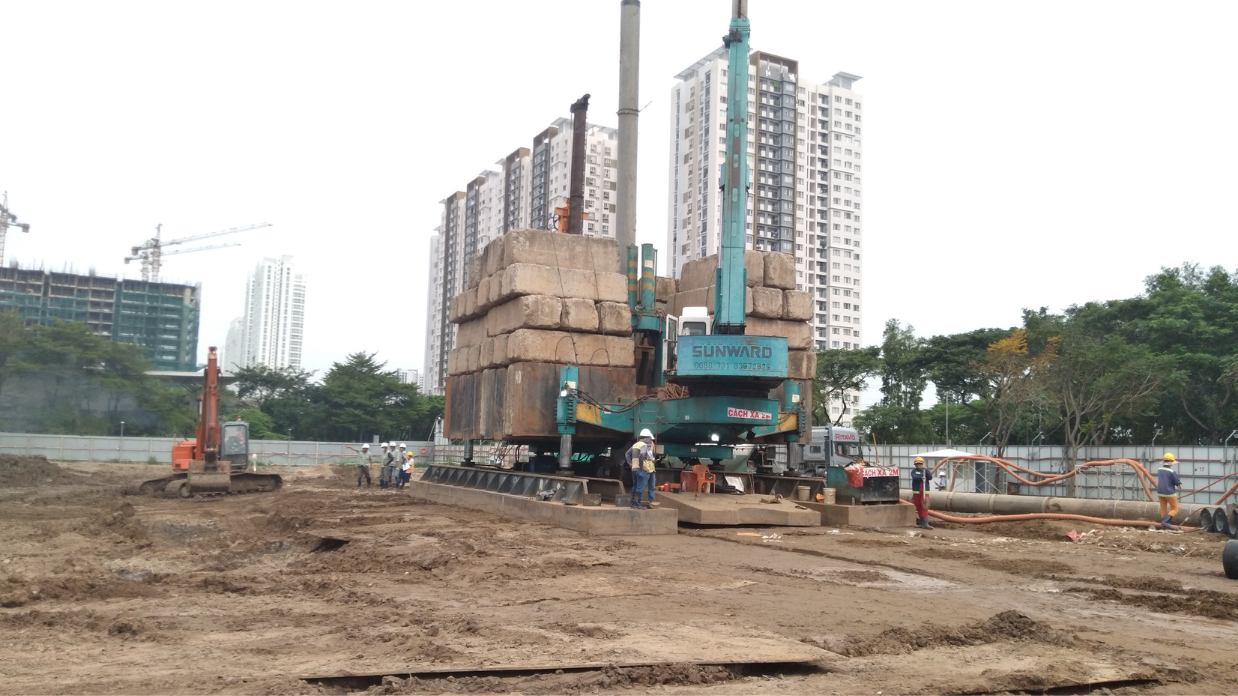

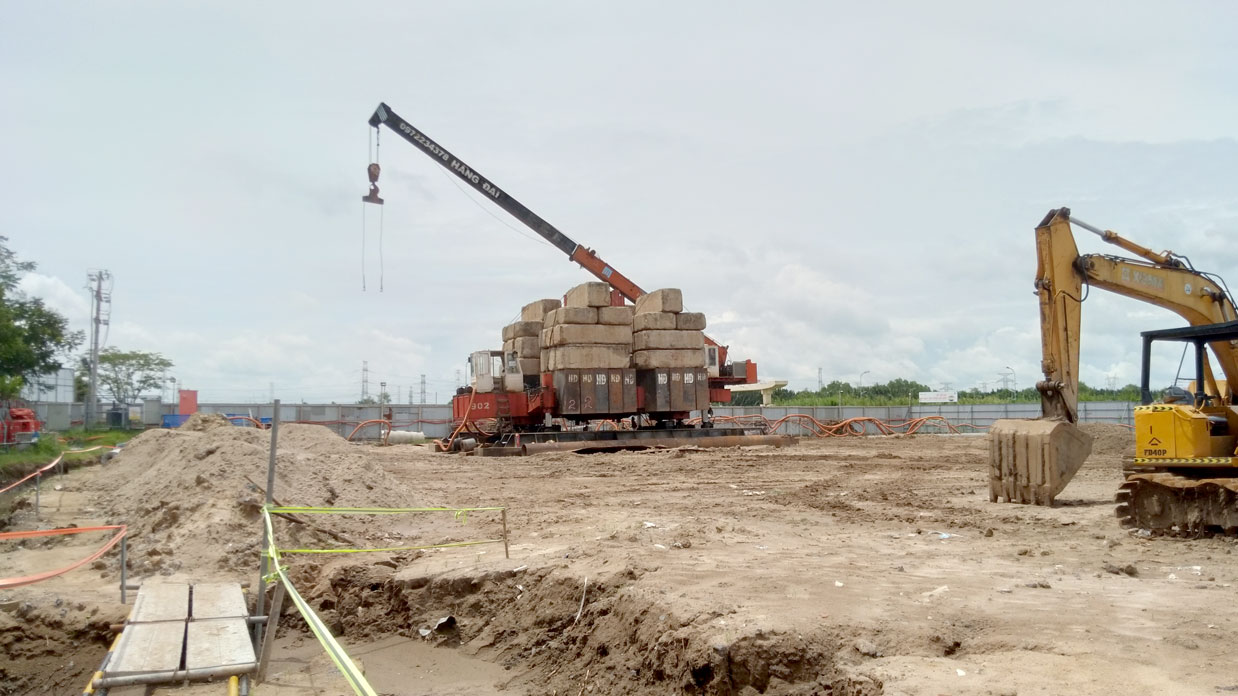

Piling works of Tower 5 is in progress

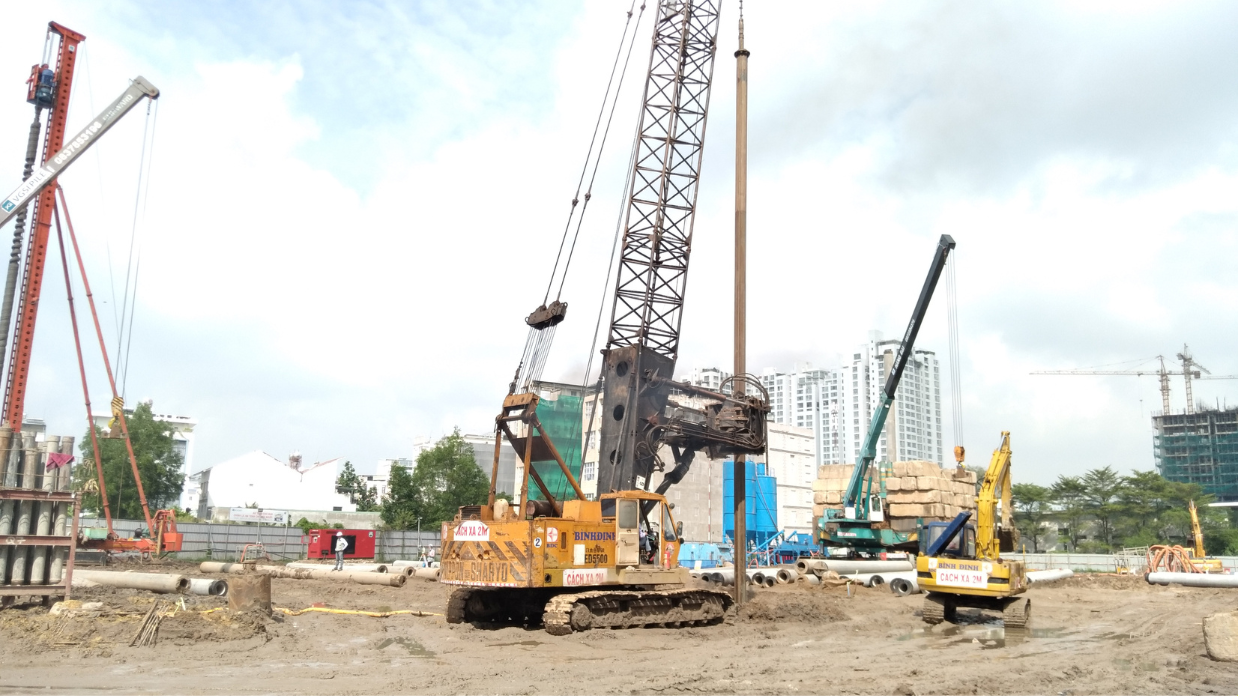

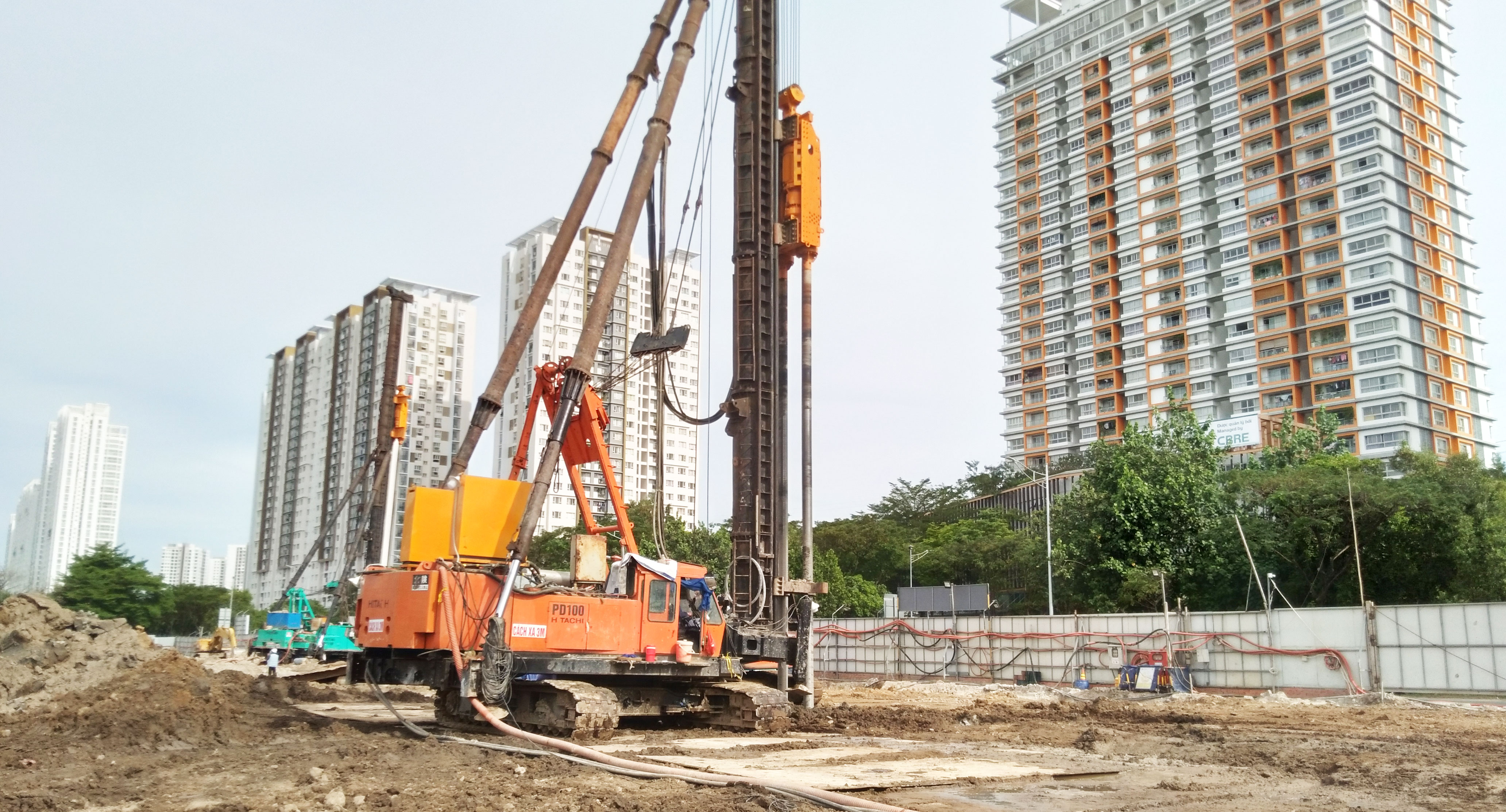

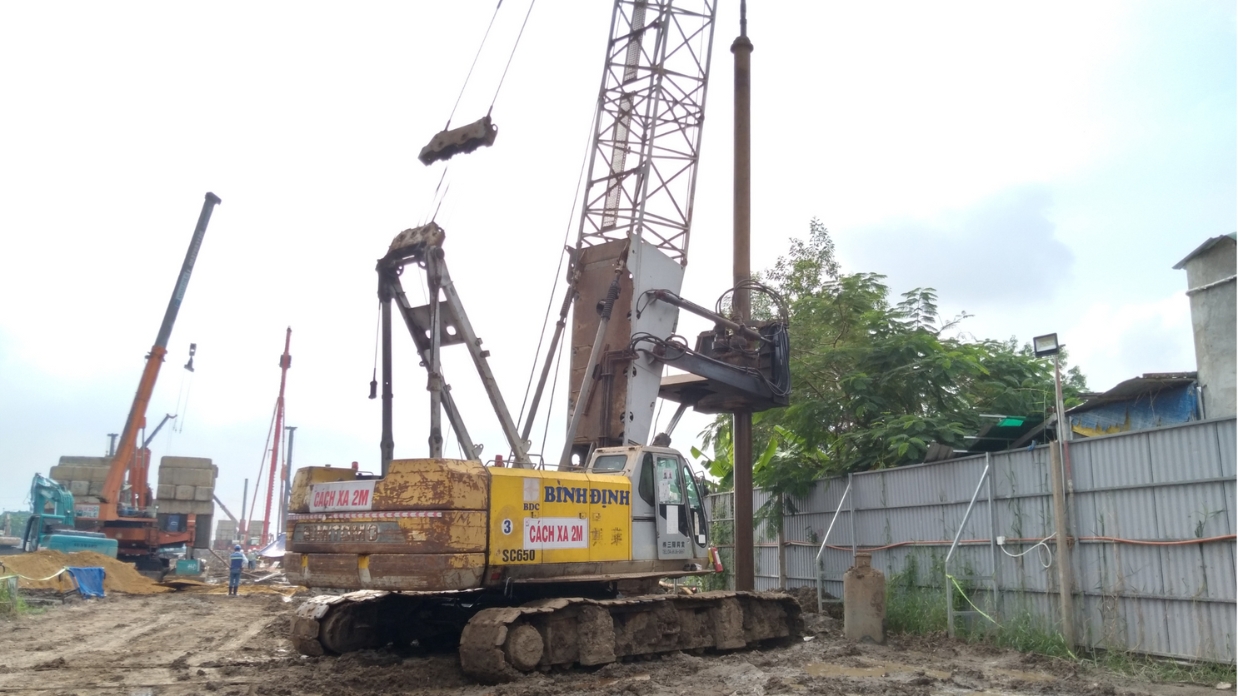

CDM work for basement excavation of the Podium is in progress

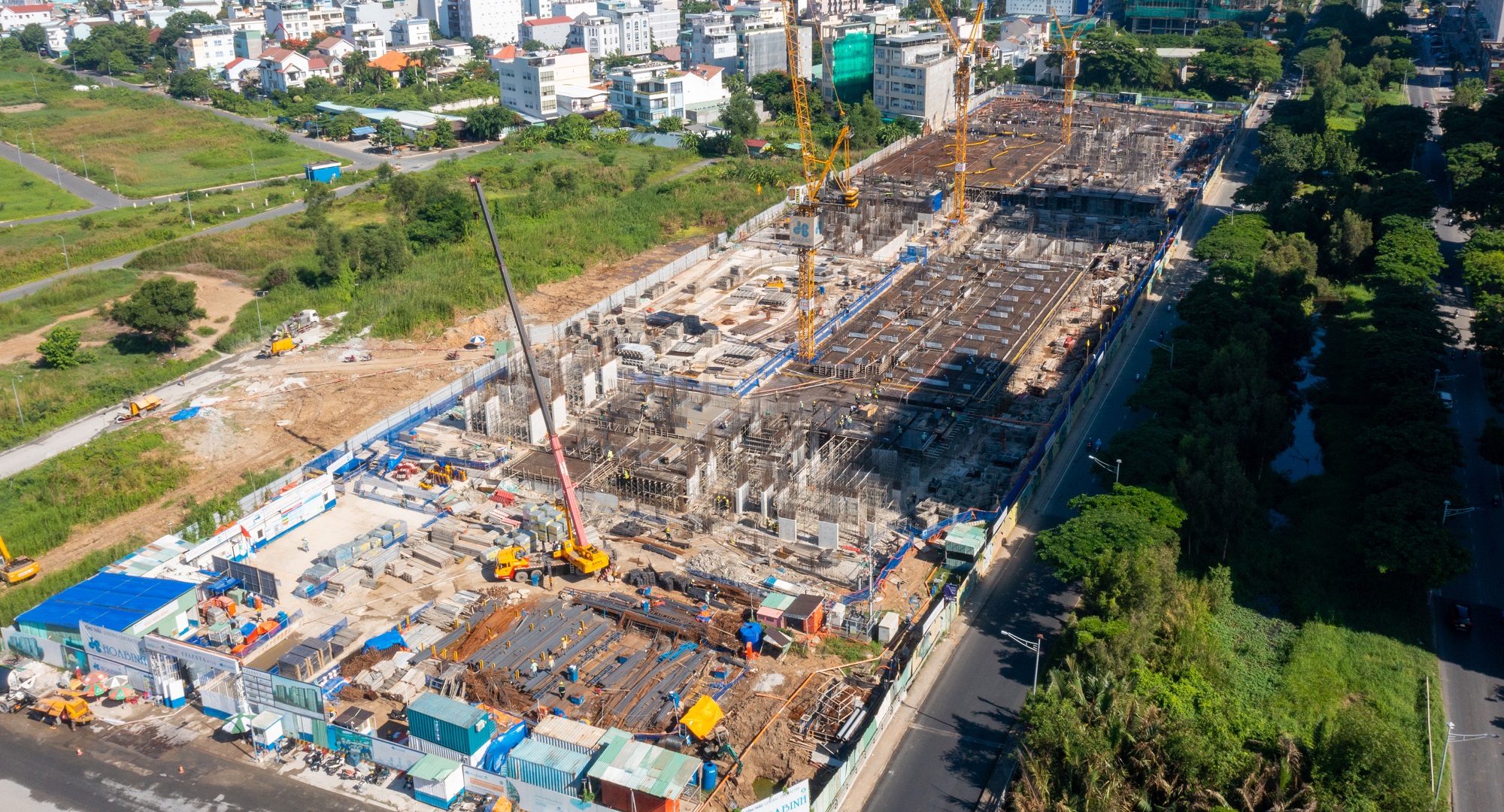

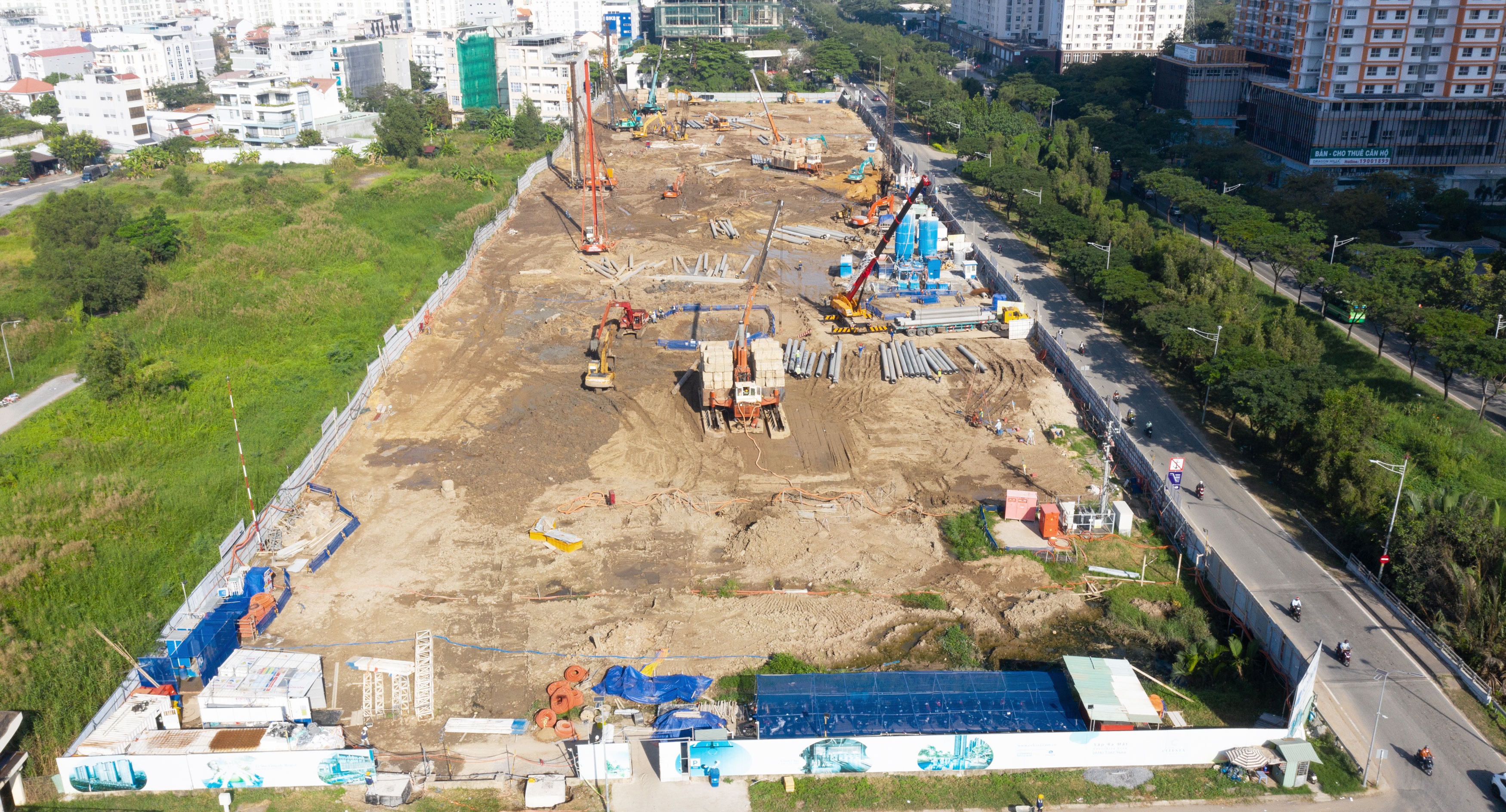

Overall construction site
Construction site from Dong Tay street
Preparation for basement and buildings’ foundation excavation has completed

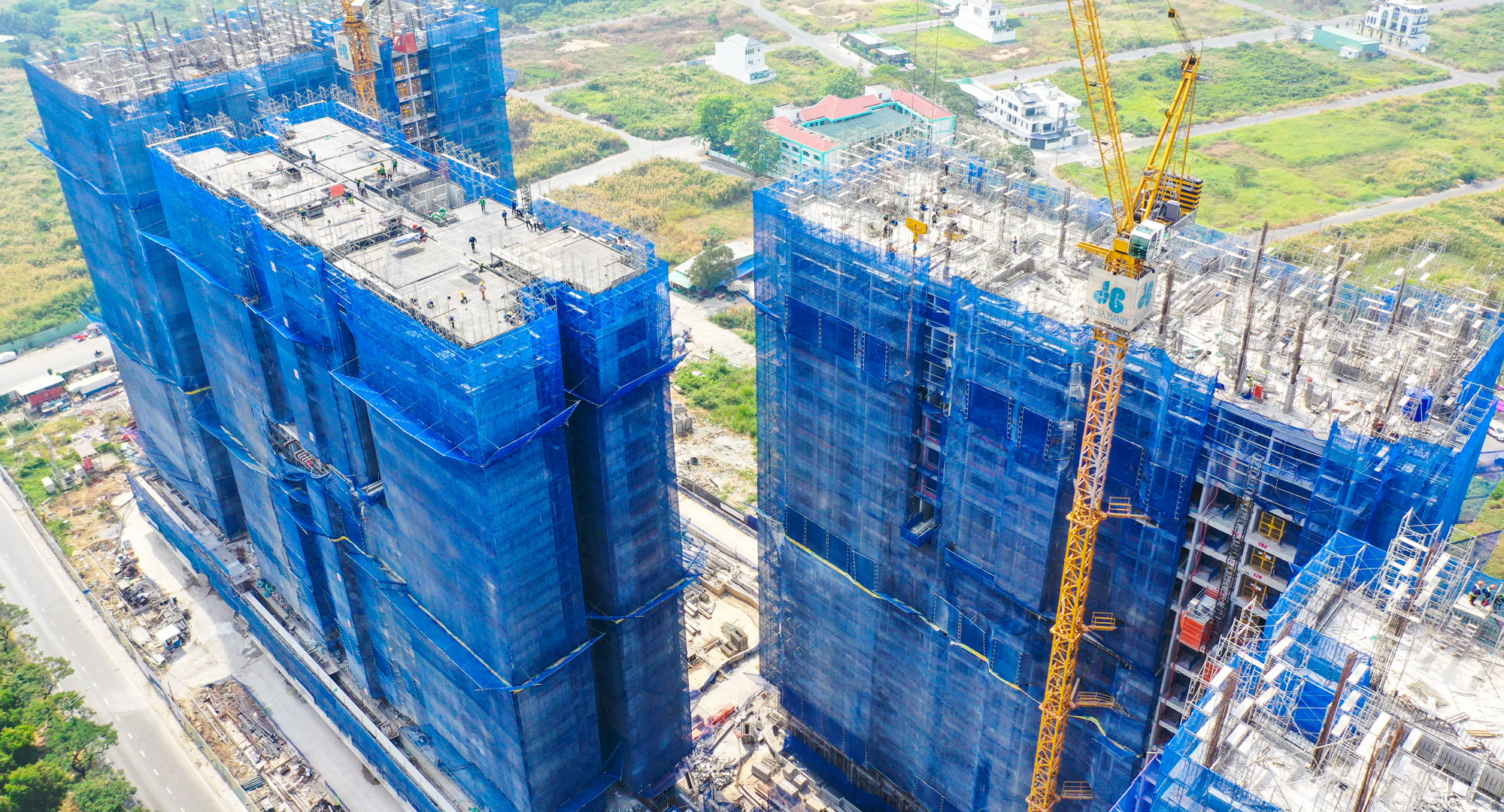

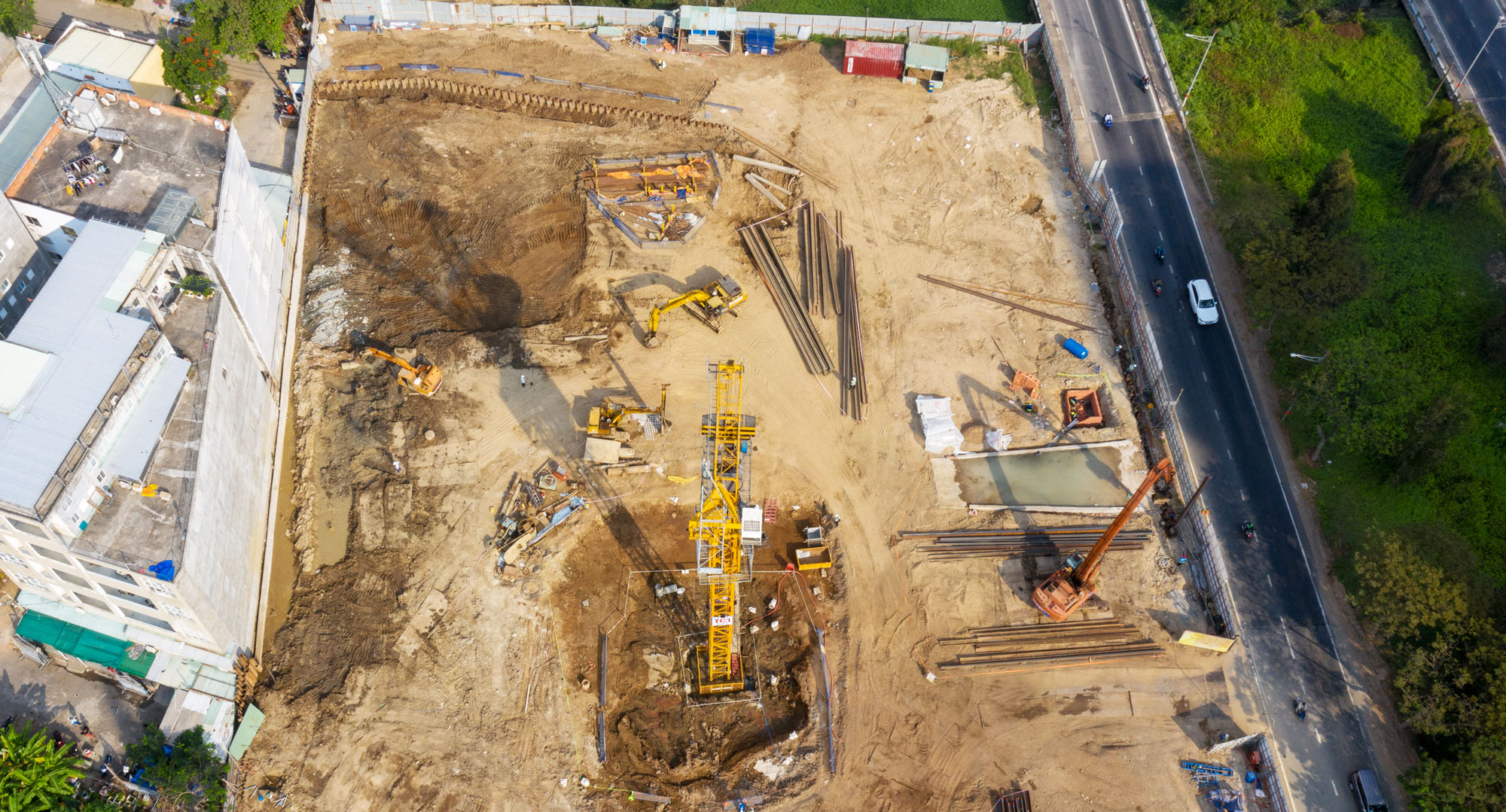

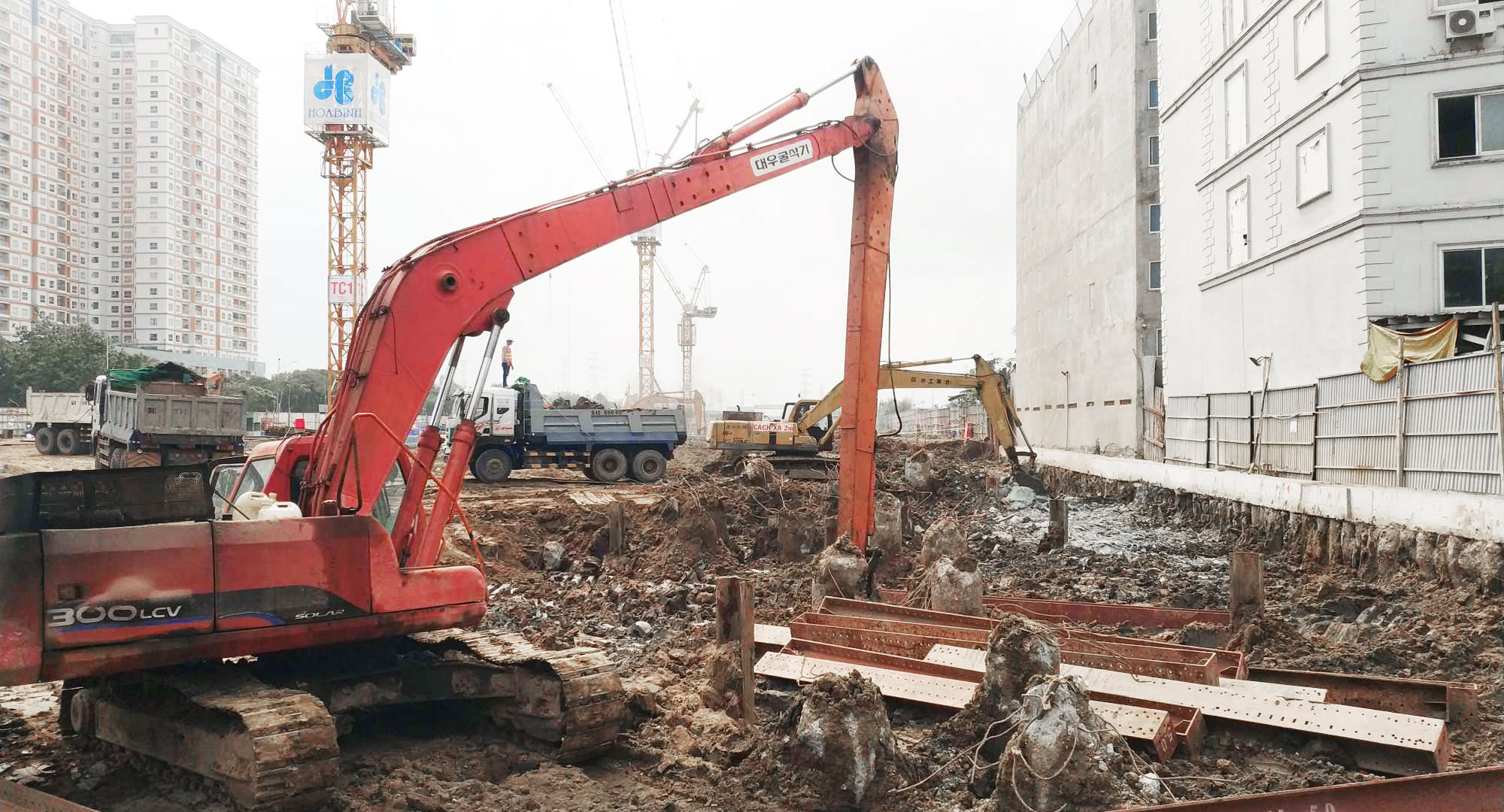

Excavation at Tower 1 & 2 is in progress

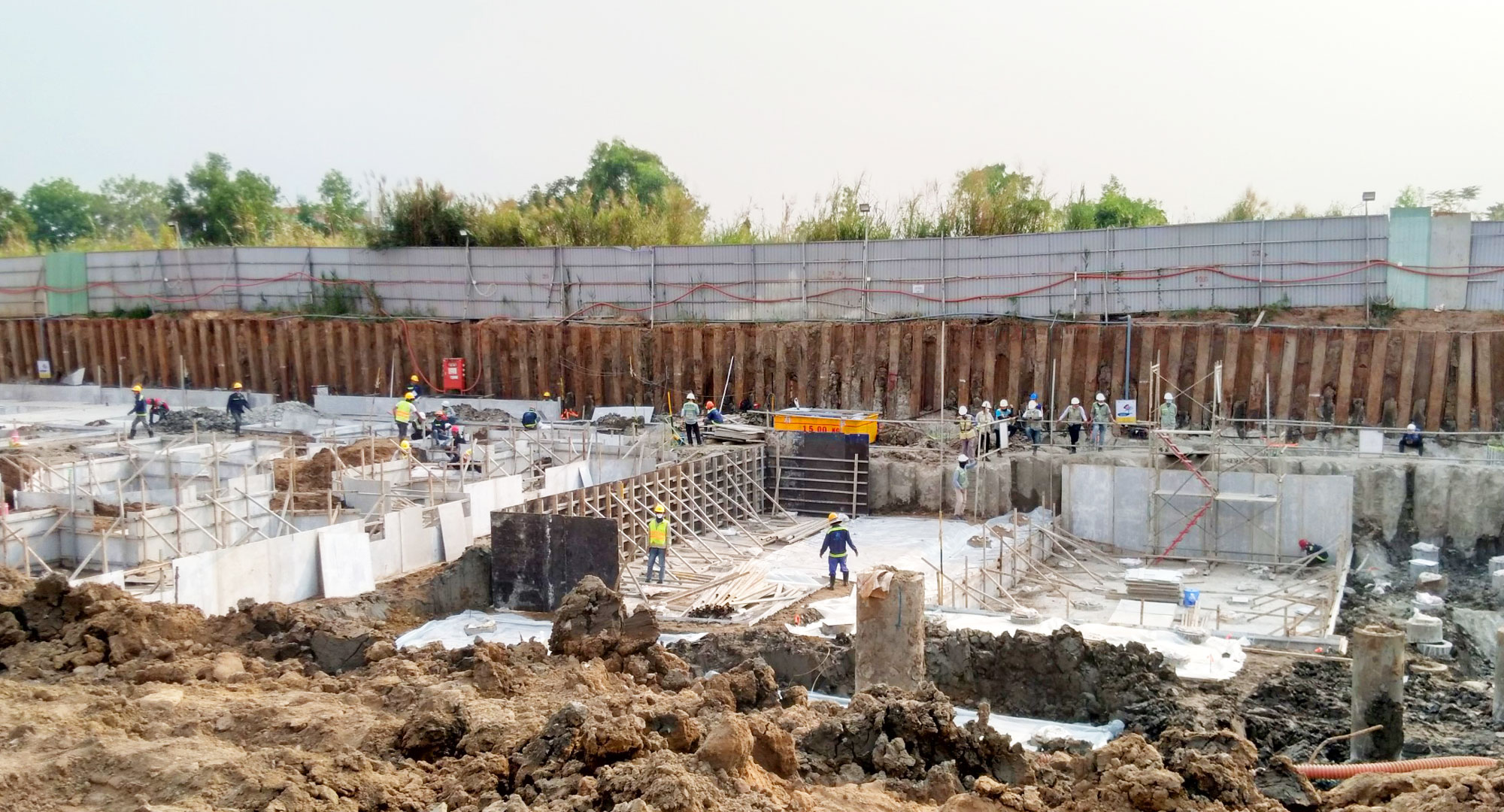

Excavation at Tower 3 is in progress

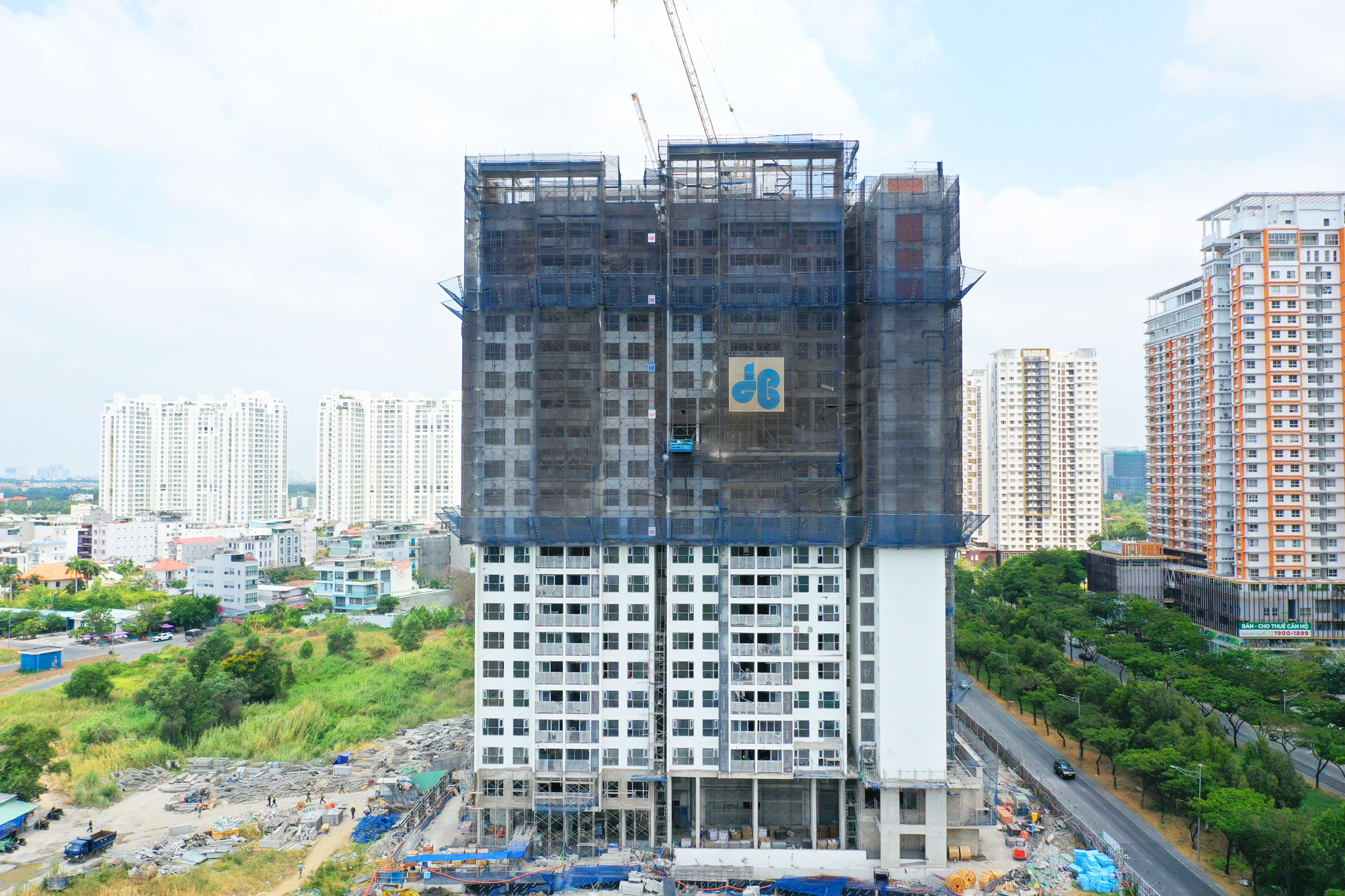

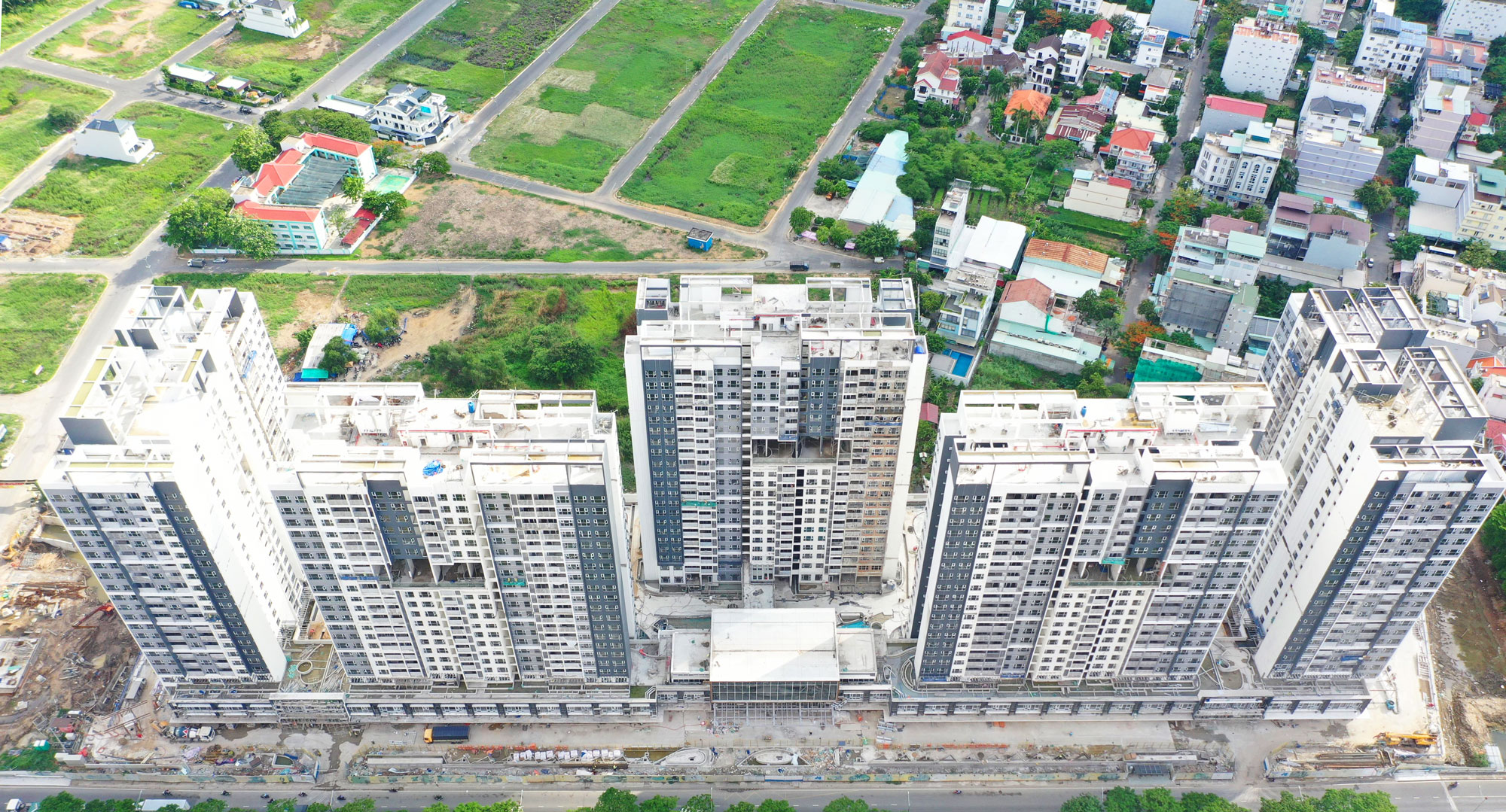

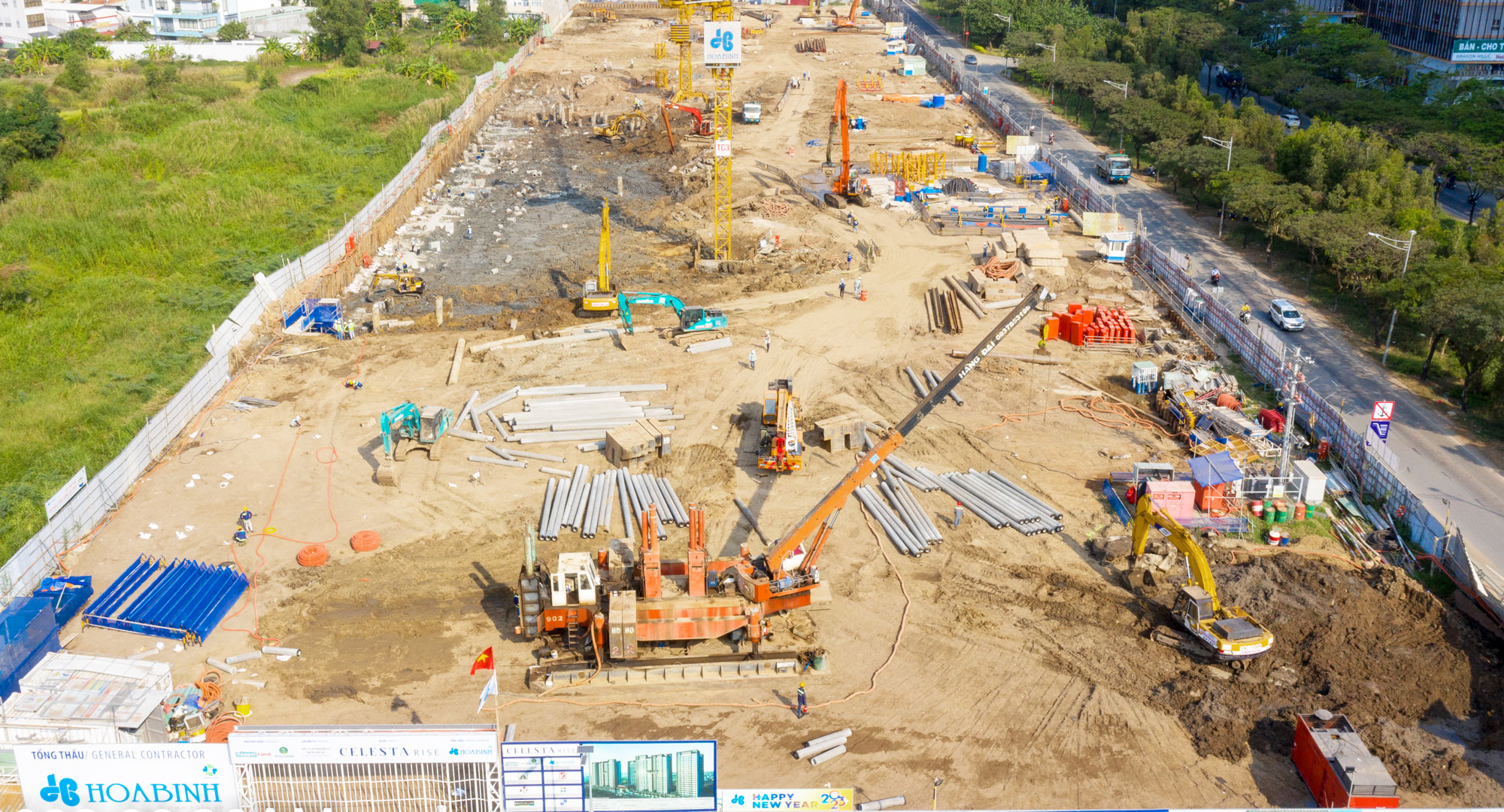

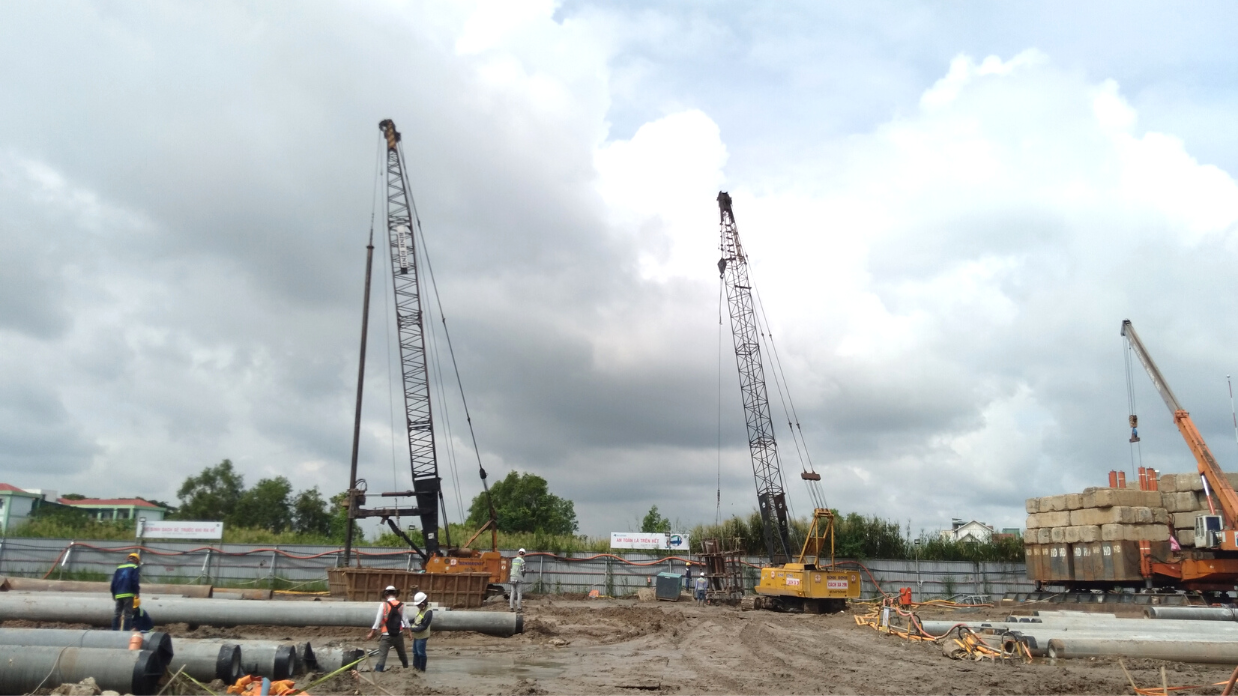

Piling works of the Podium and all the Towers have completed

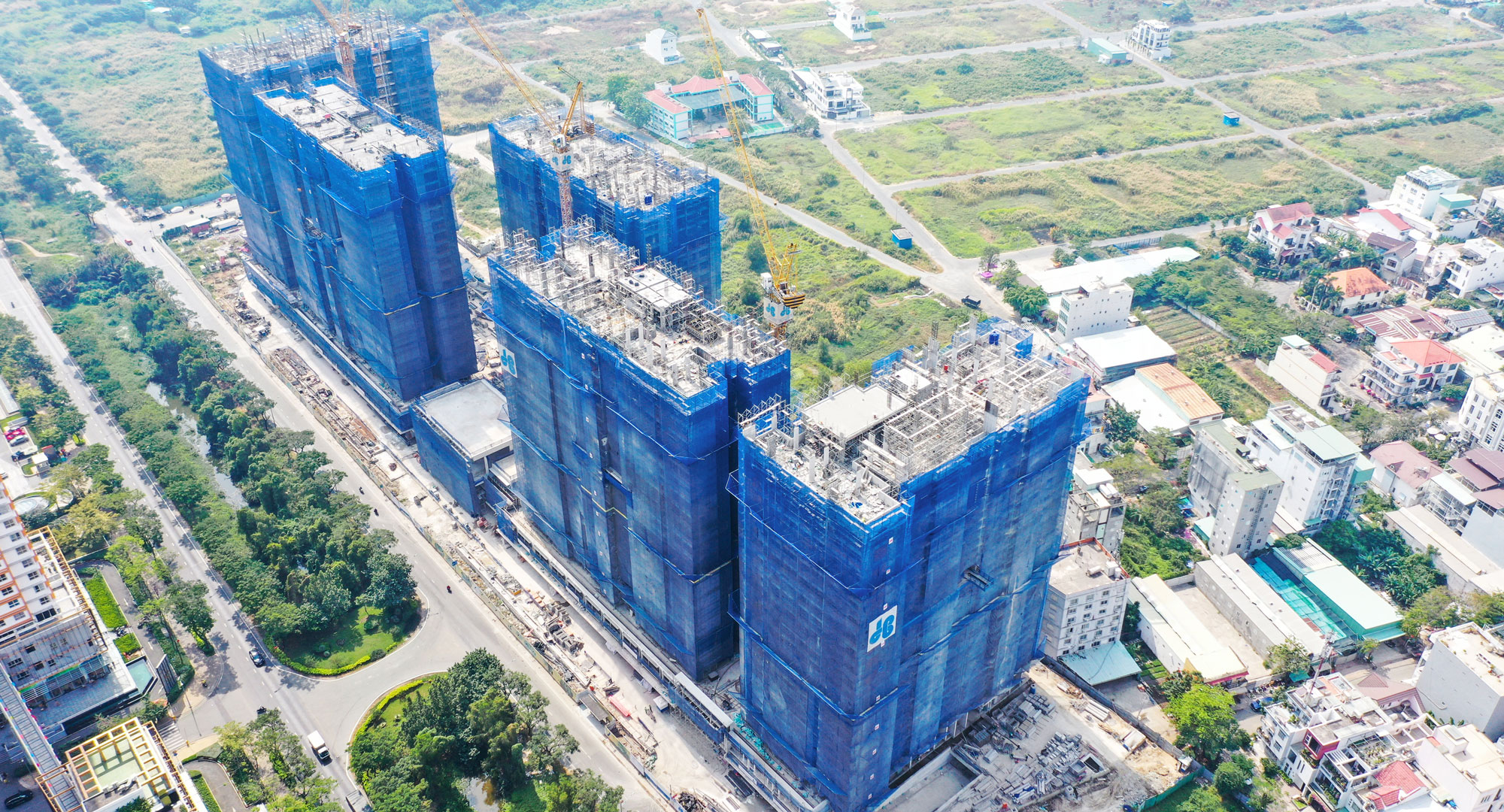

Overall construction site

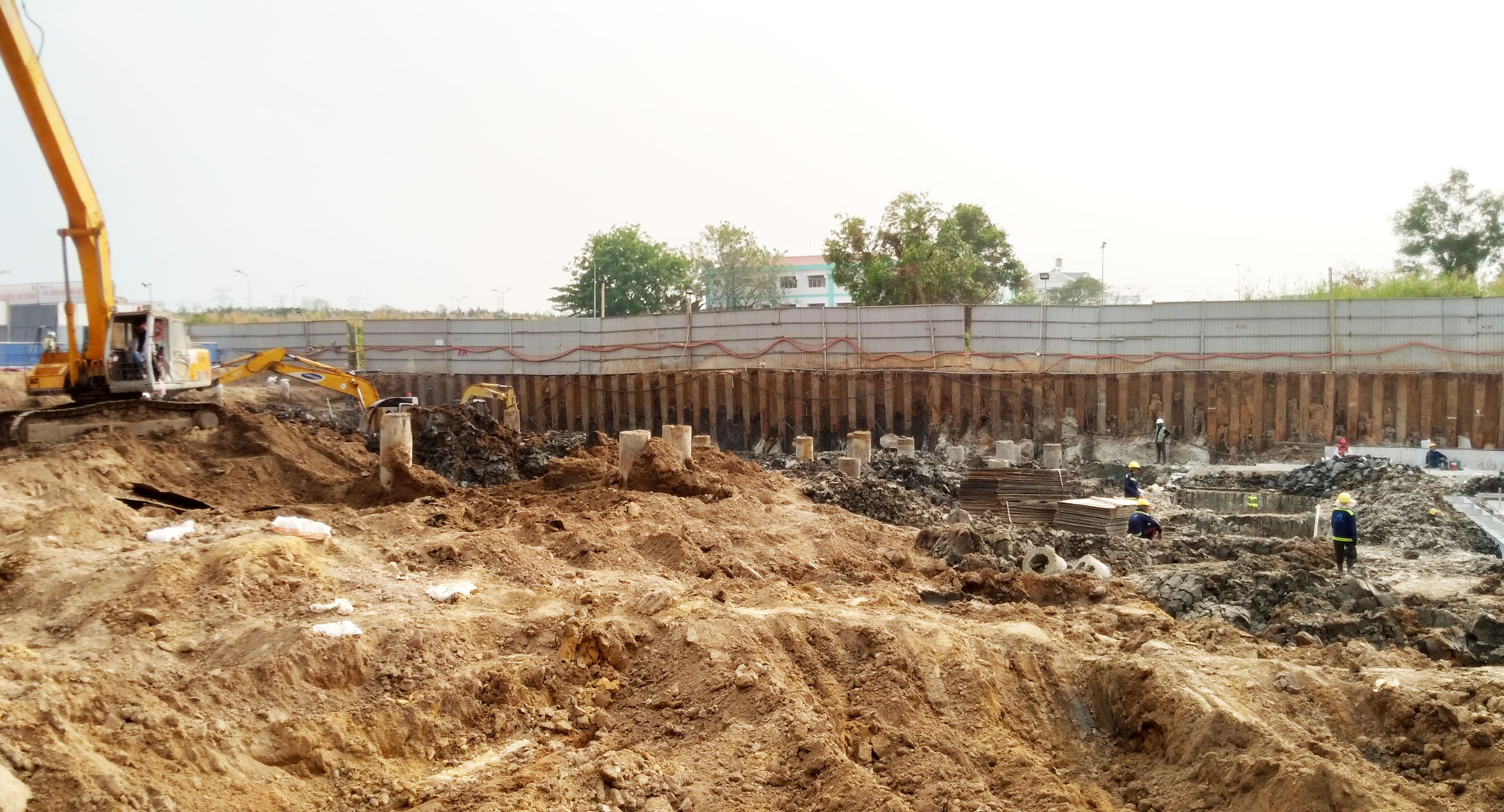

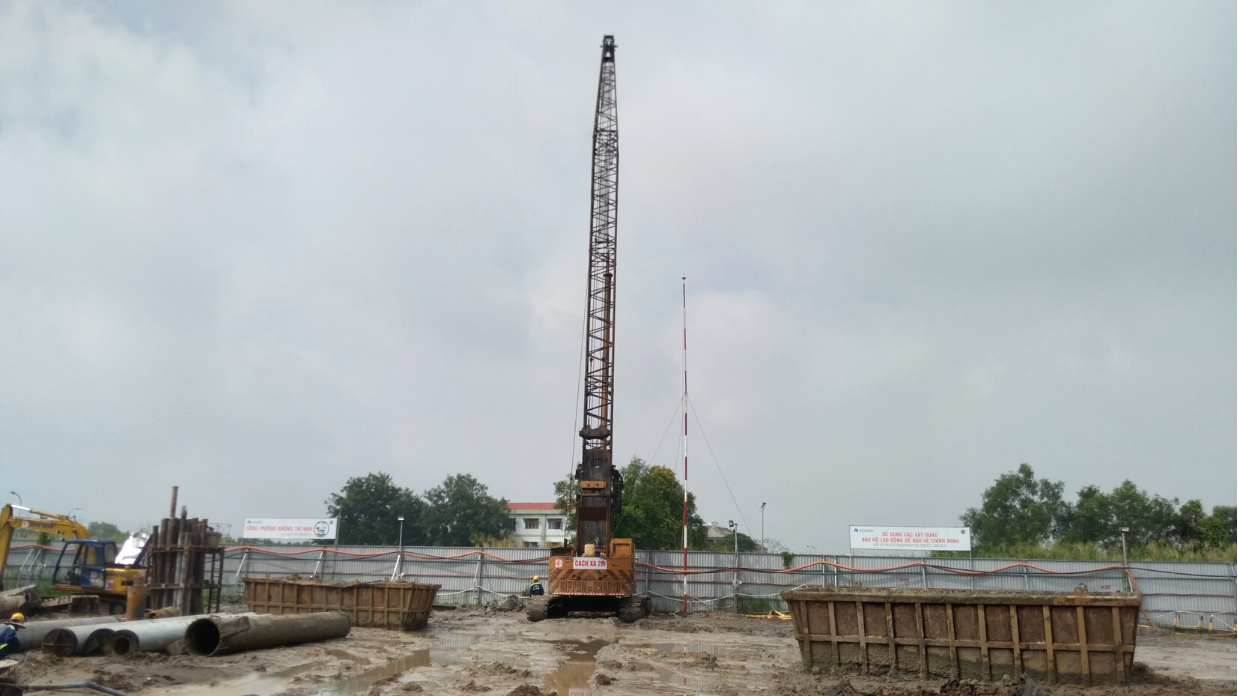

Excavation works at tower 5 are in progress

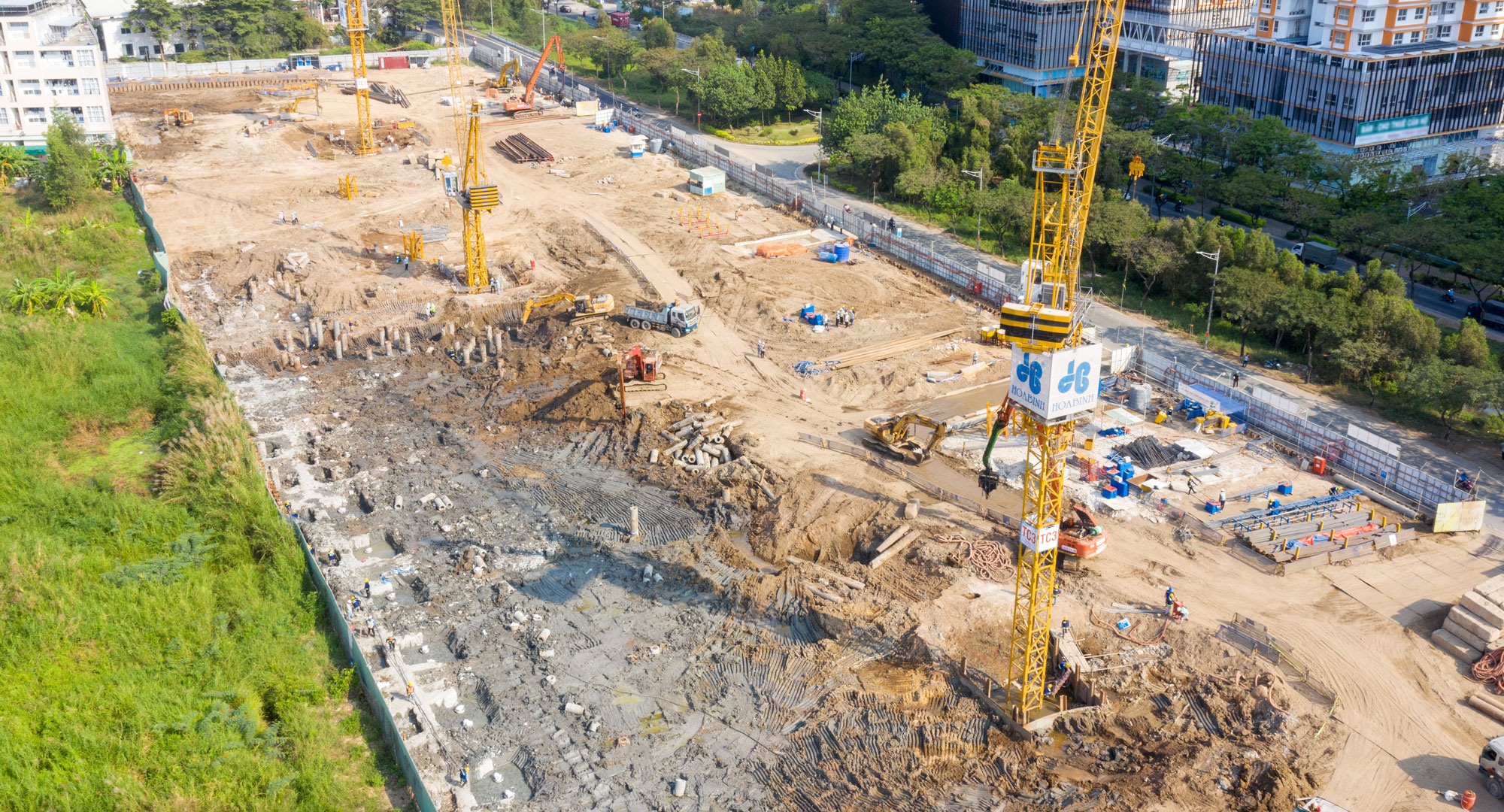

Excavation works at towers 3, 5 and the podium are in progress

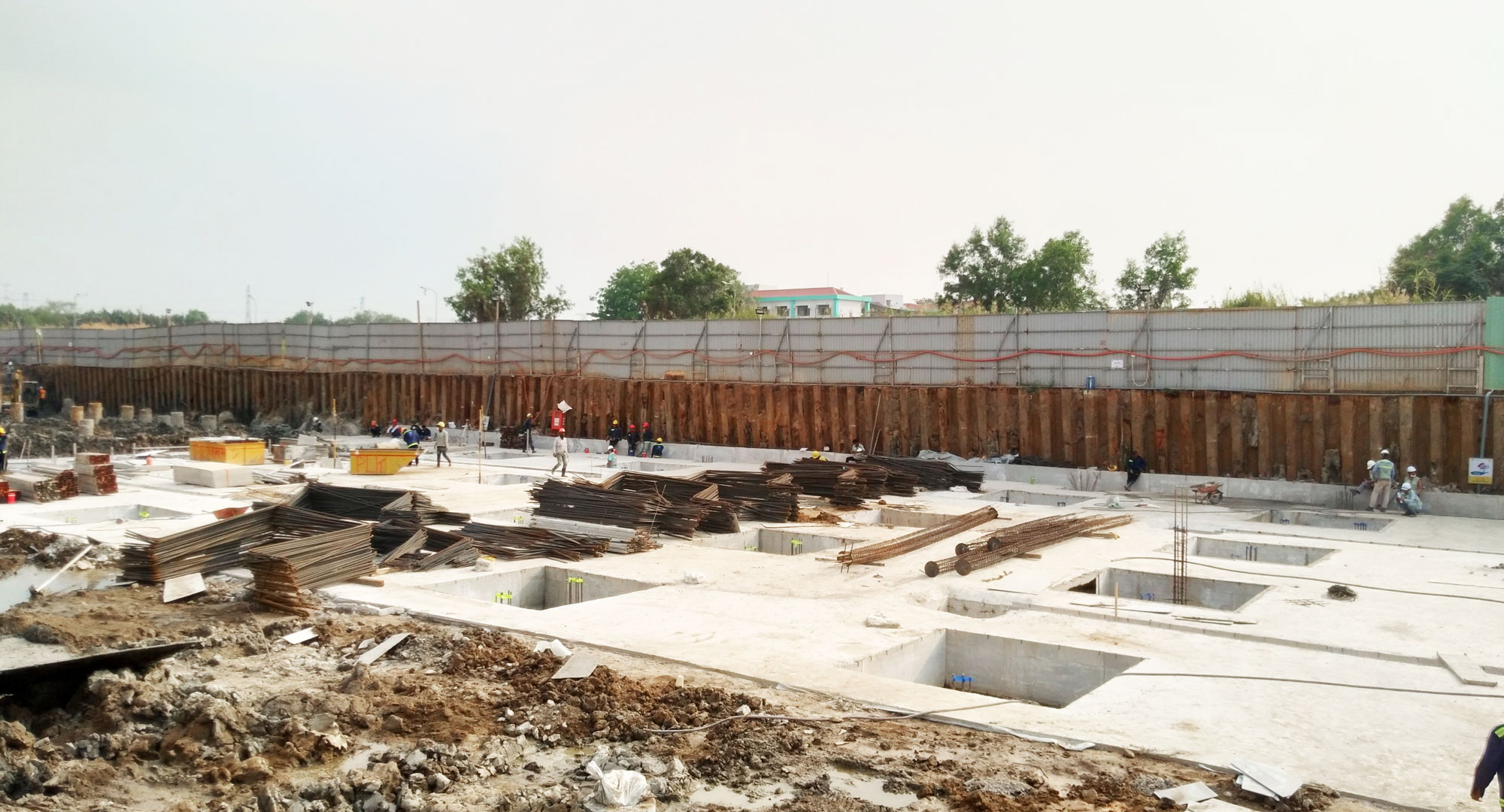

Excavation works at the podium between towers 3 and 5 are in progress
Excavation works at tower 3 are in progress

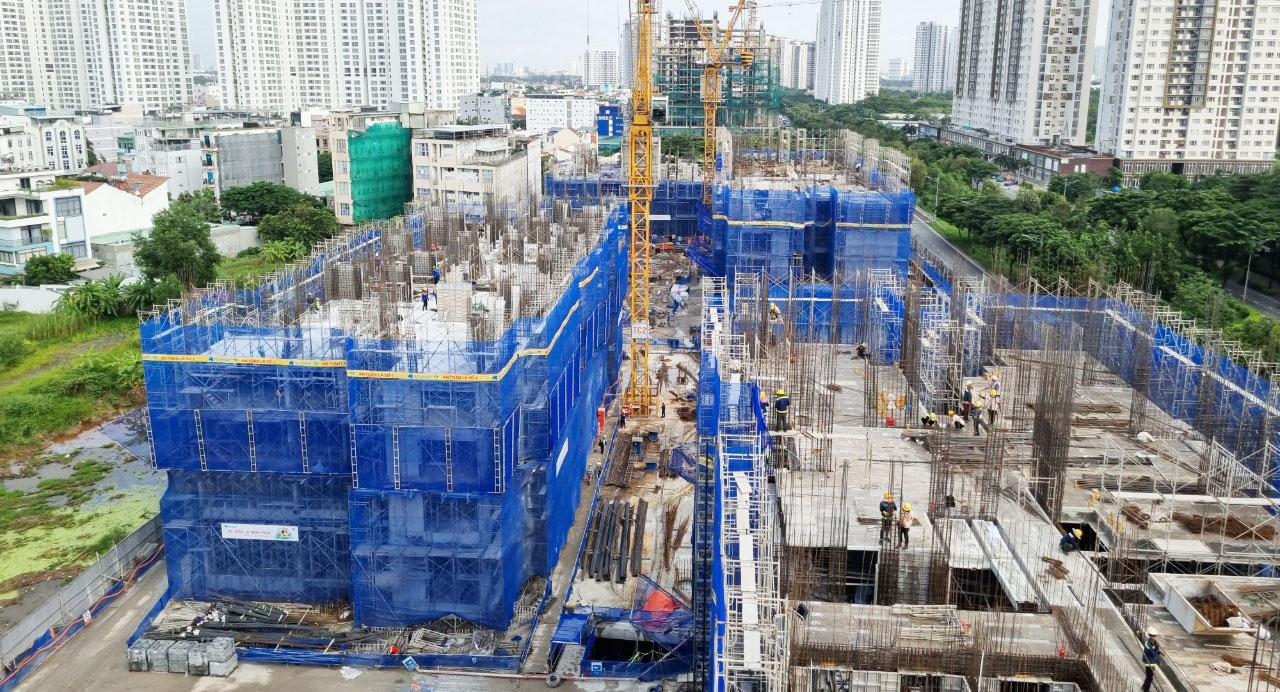

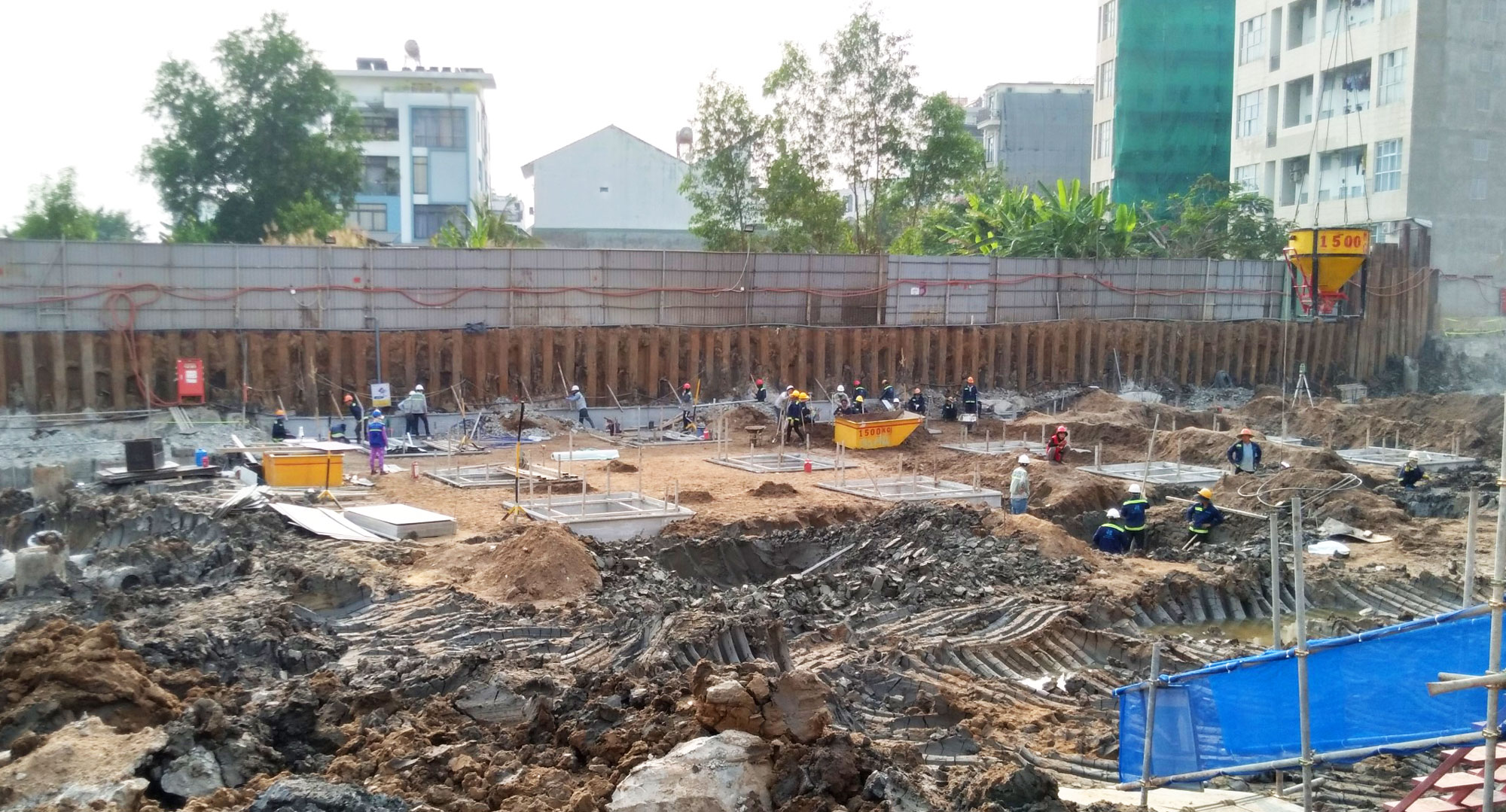

Excavation works at the podium between towers 1 and 3 are in progress
Excavation works at tower 5 are in progress
Overall construction site from Dong Tay street
Excavation works at tower 1 from above

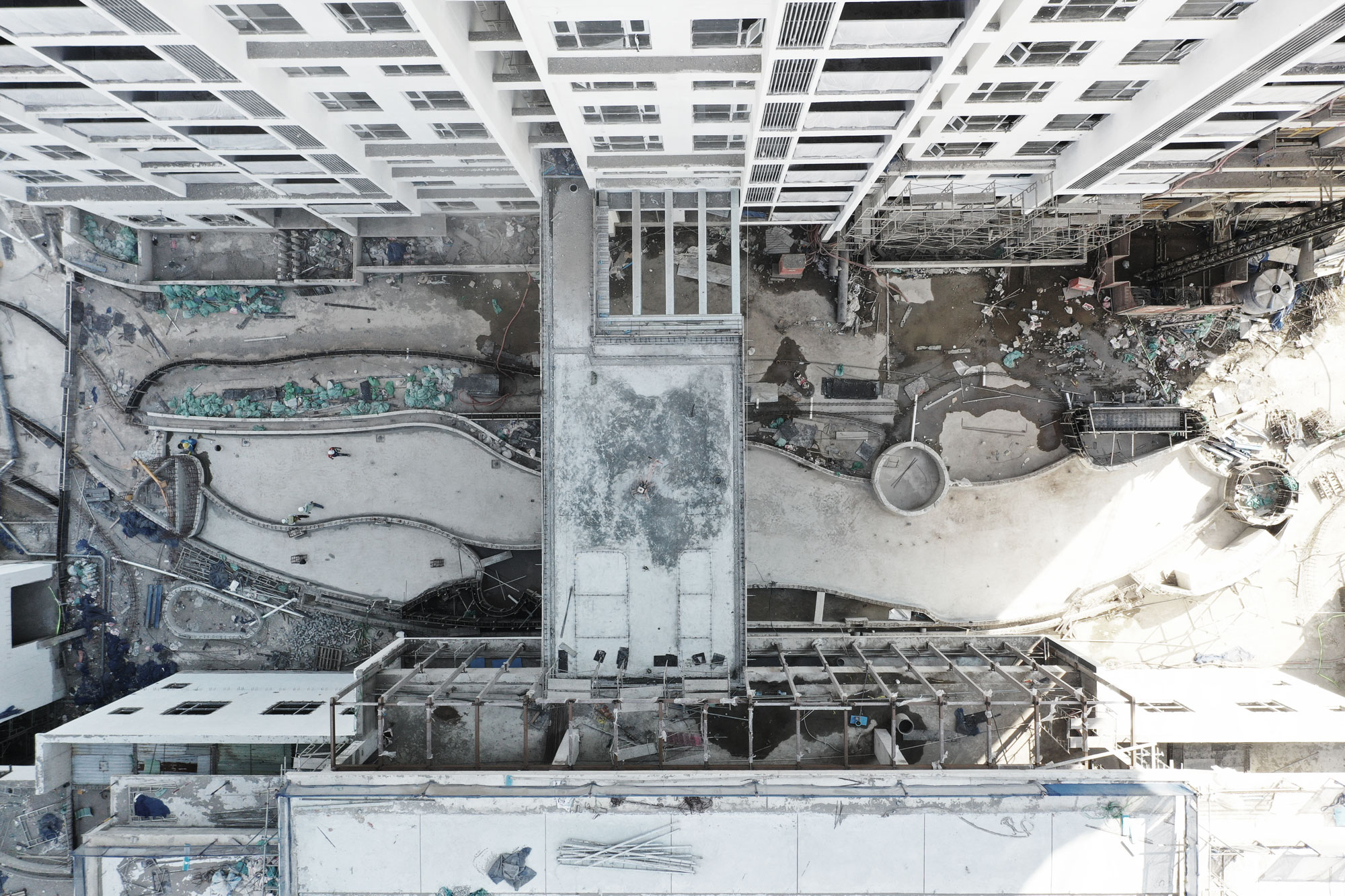

Close-up excavation works at tower 1

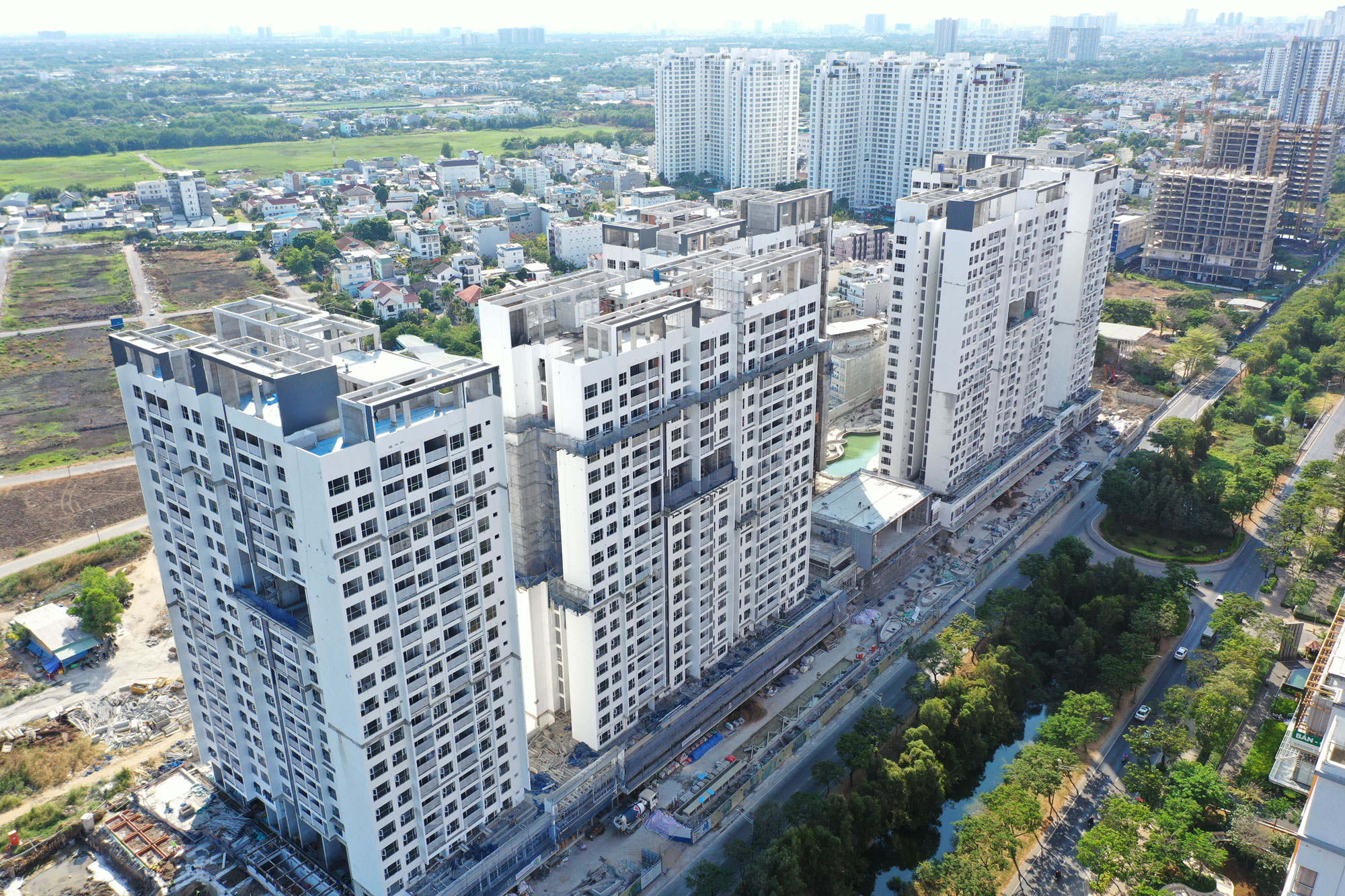

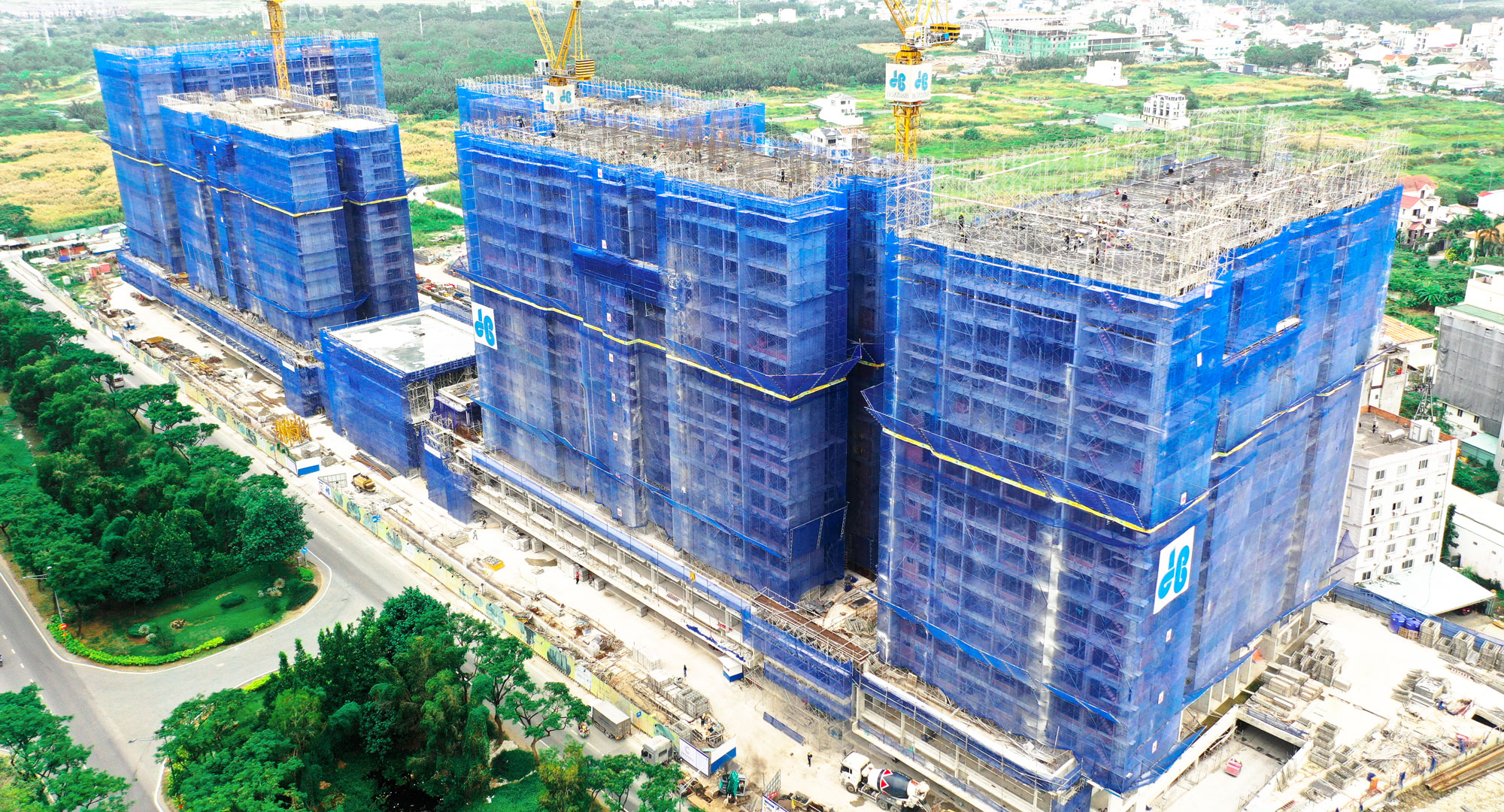

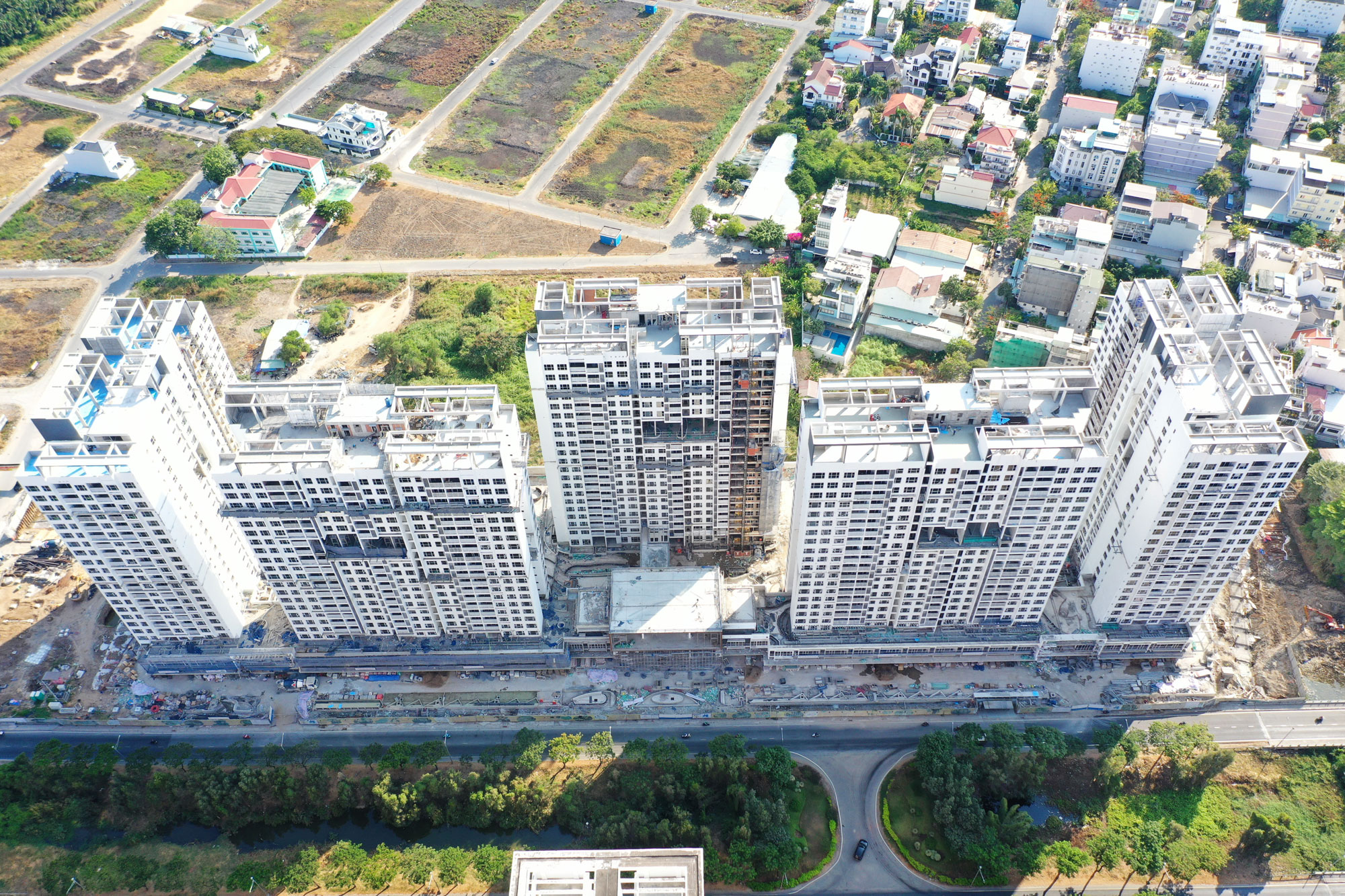

Overall construction site
Overall construction site

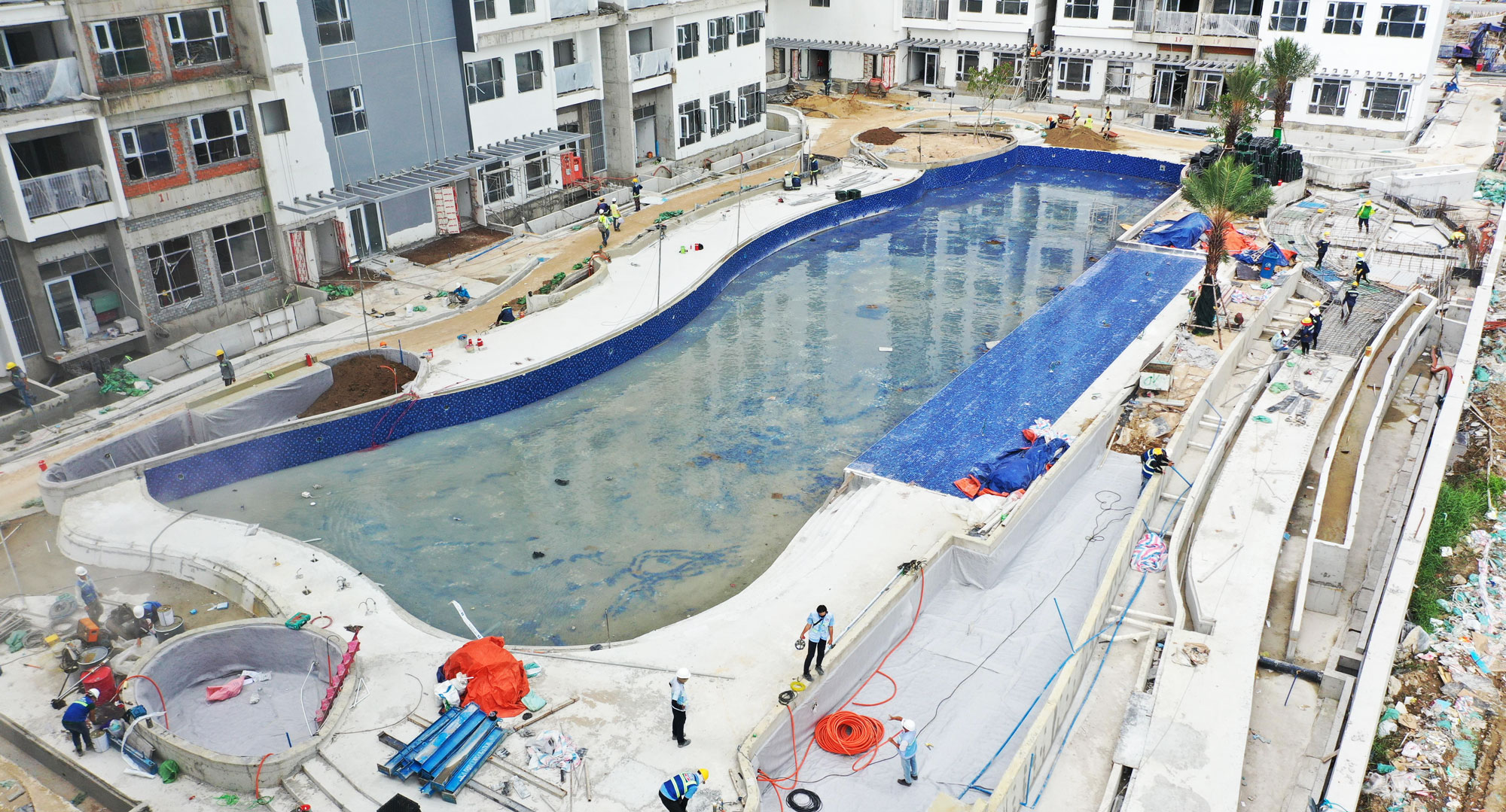

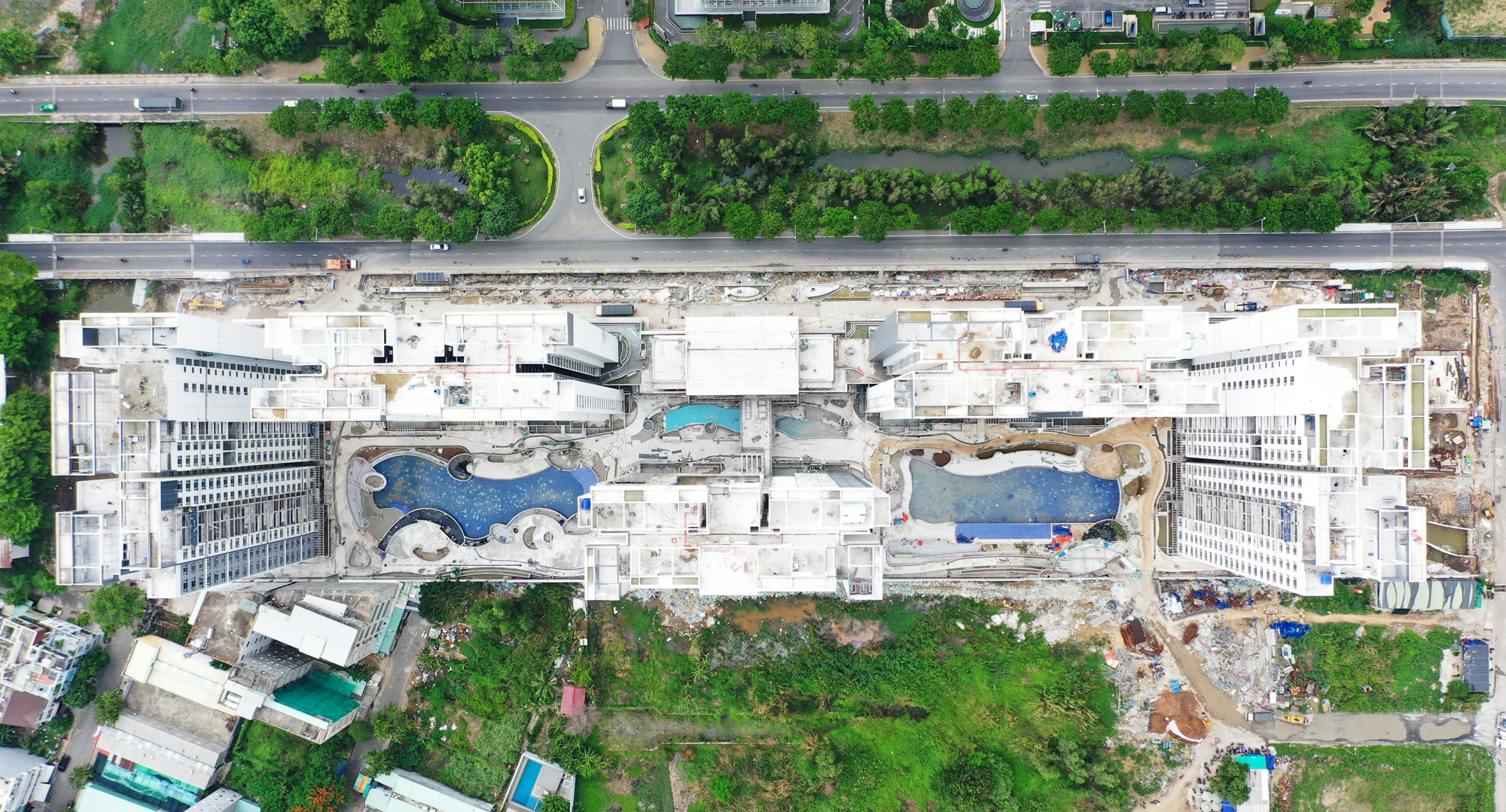

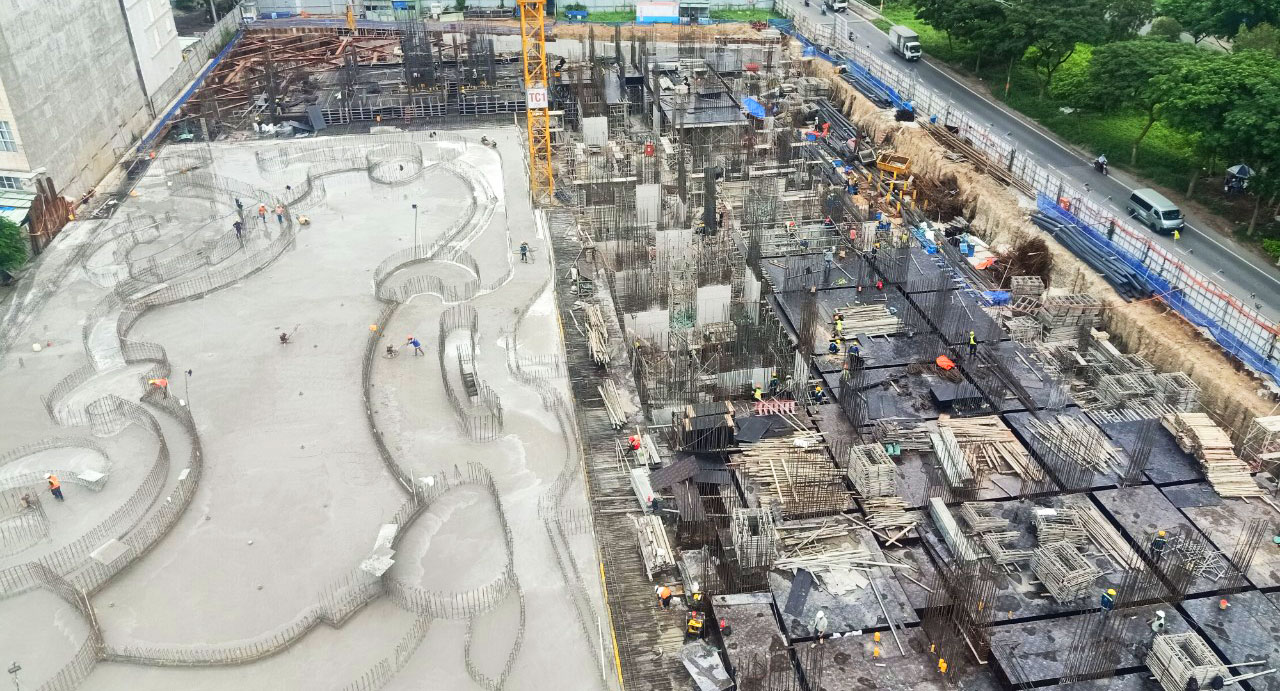

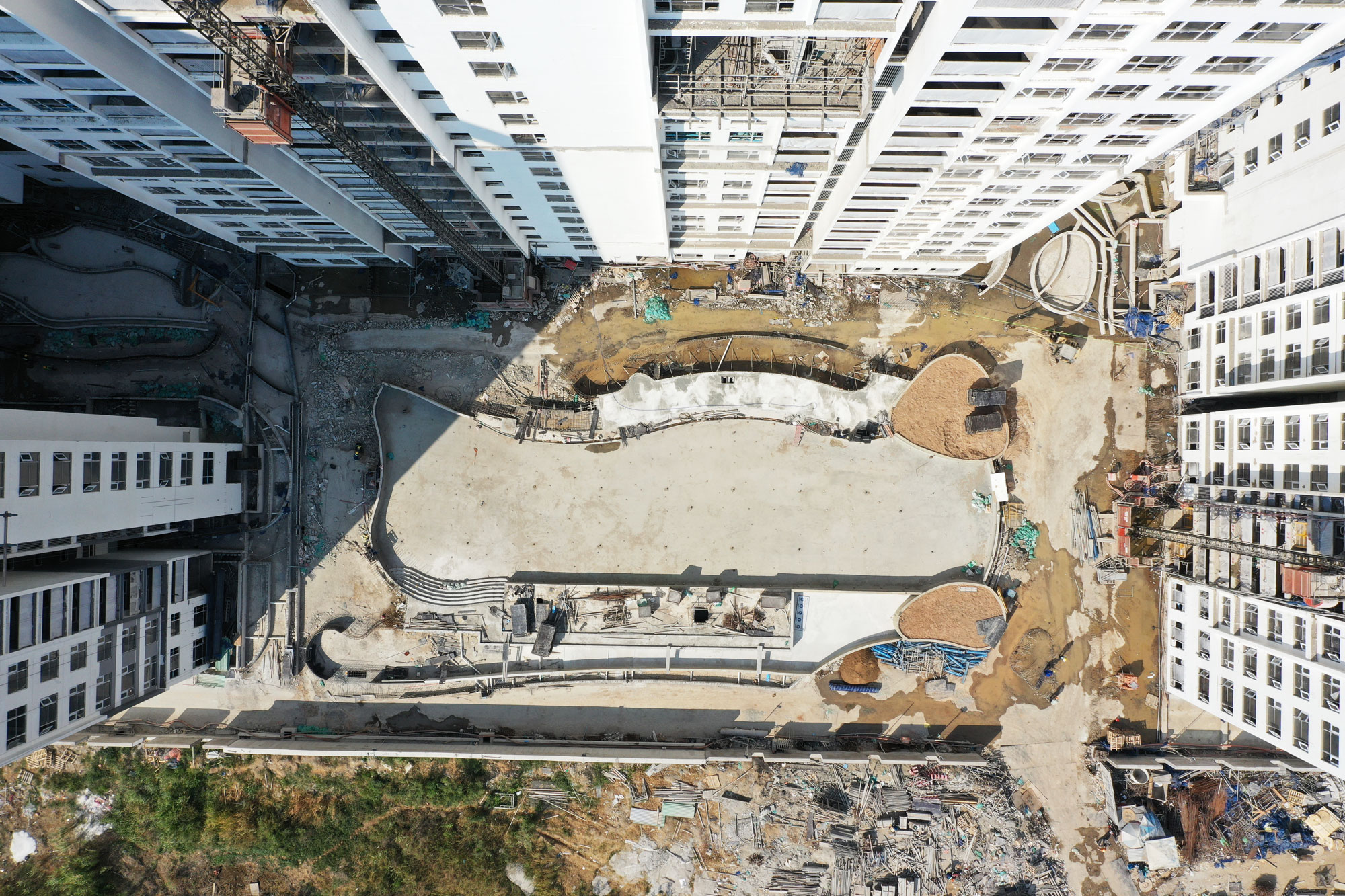

Overview of the swimming pool, tower 1 & 2 construction

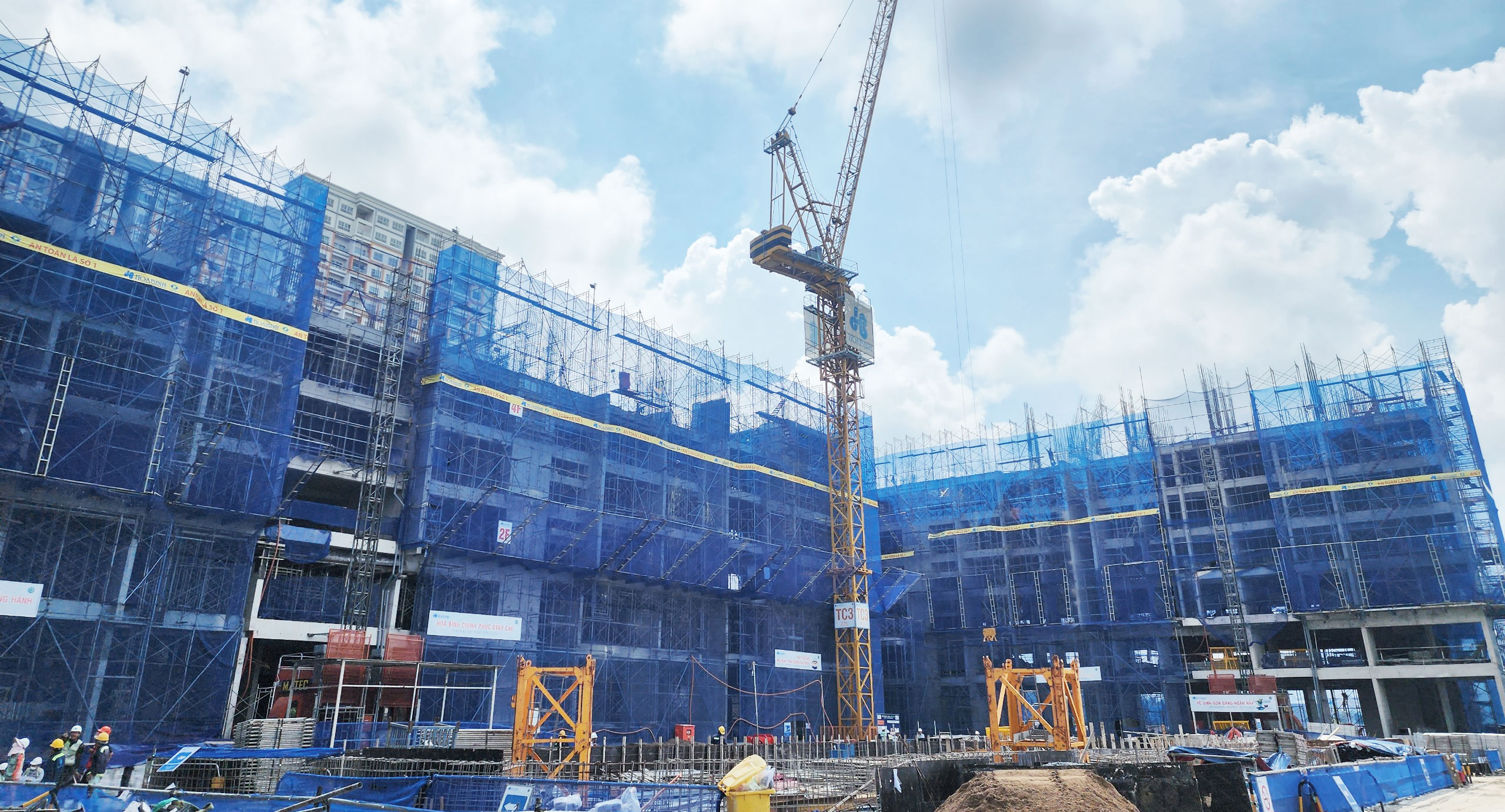

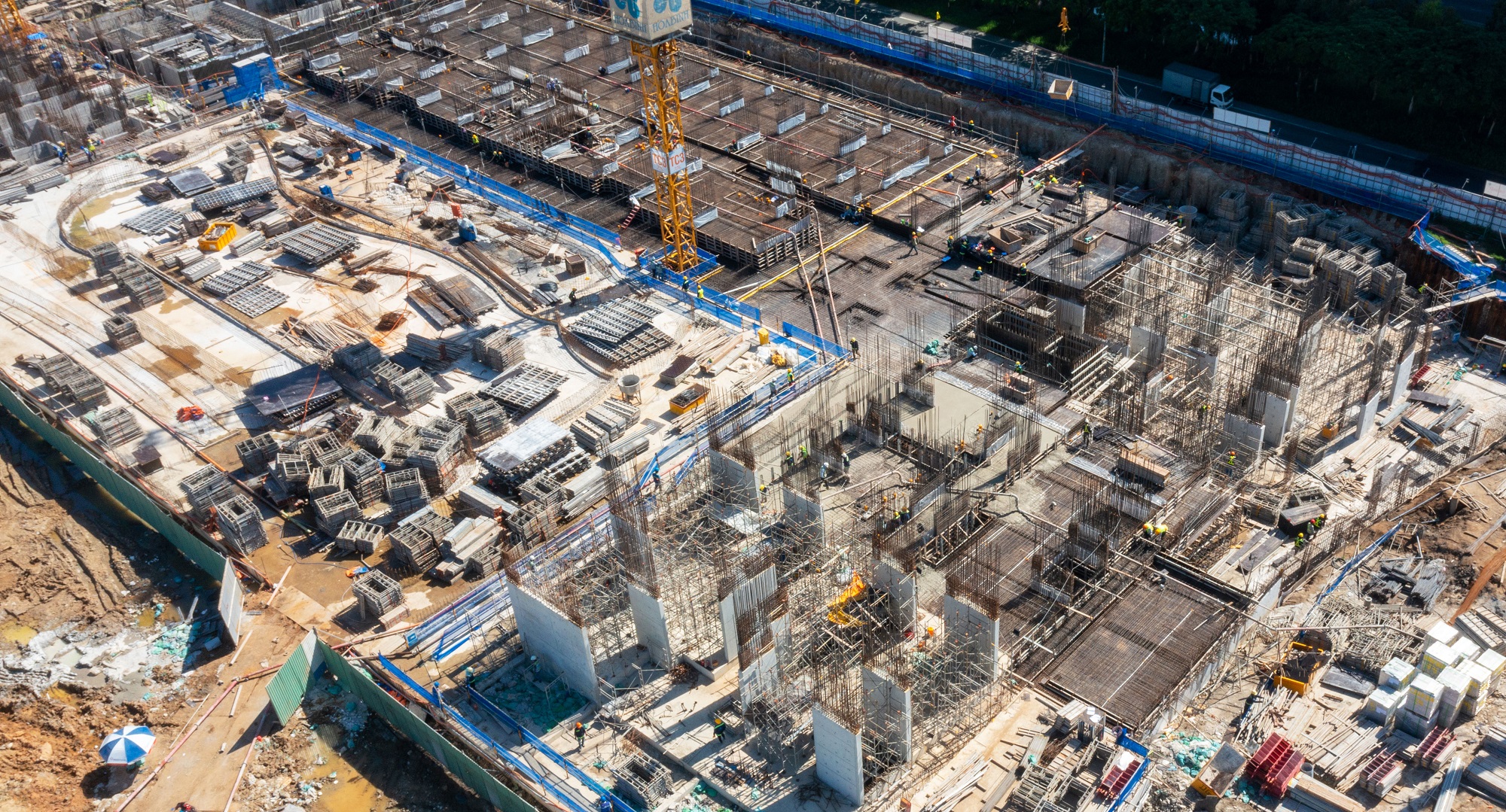

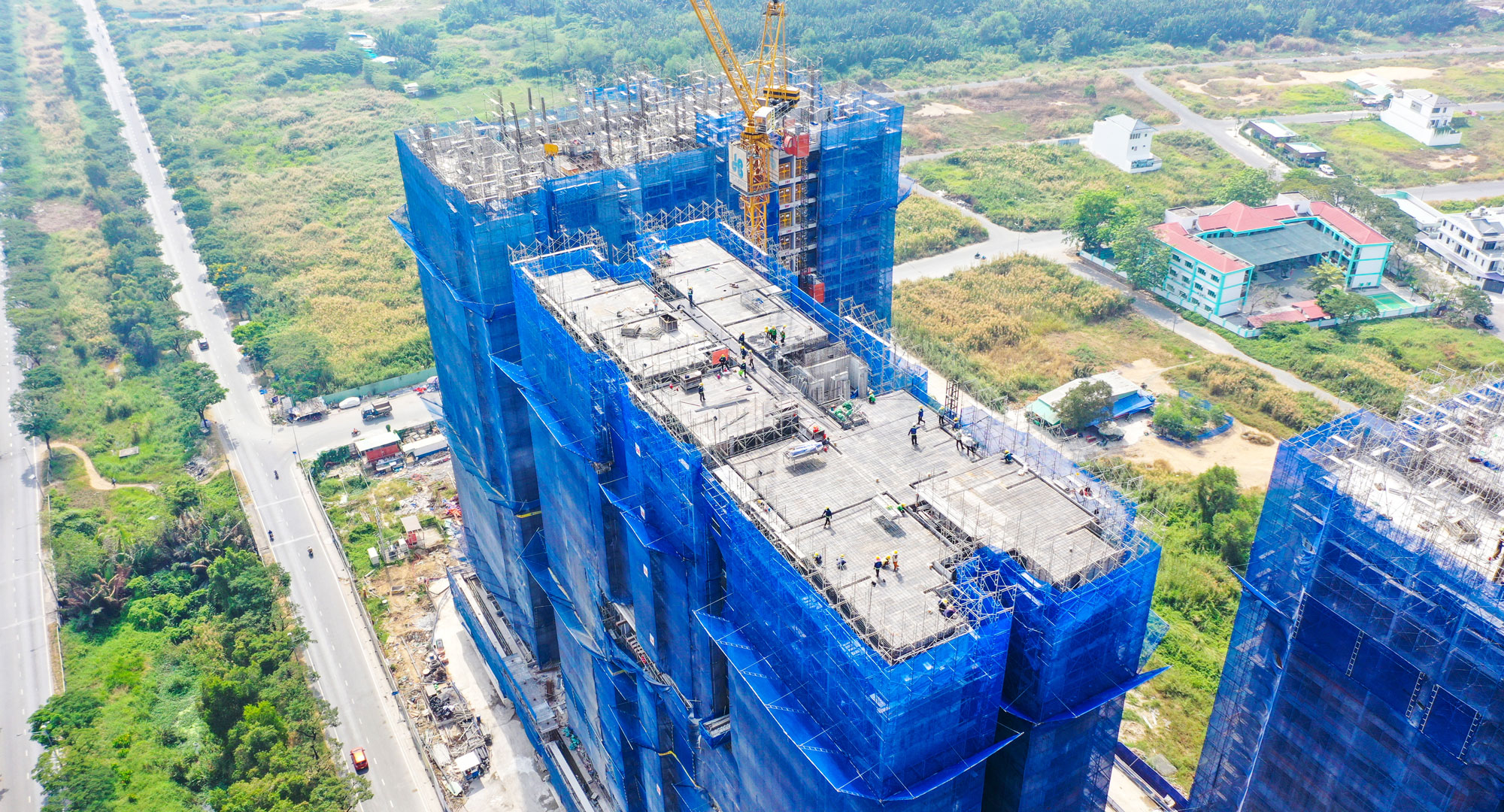

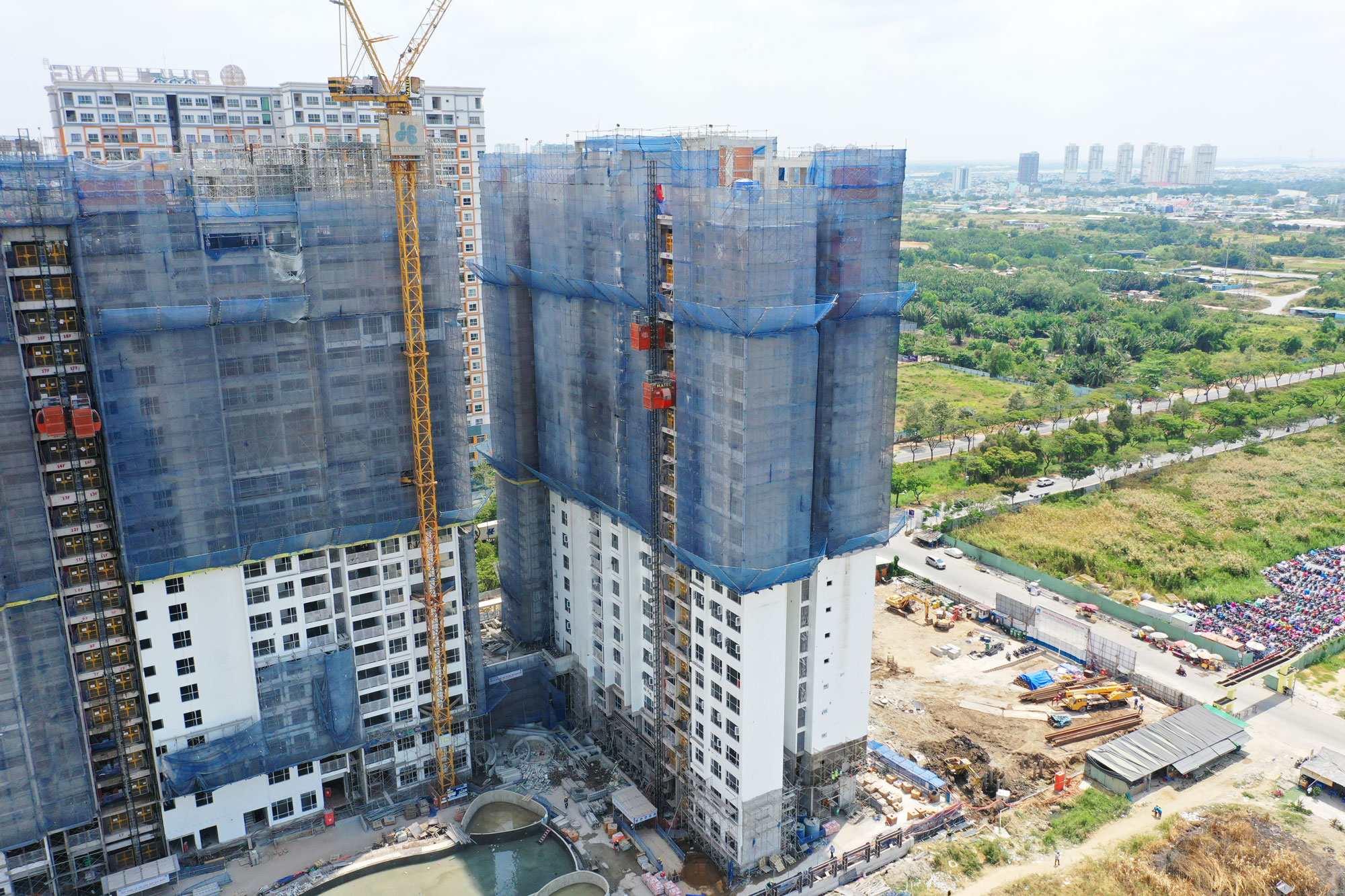

Overview of the swimming pool, tower 4 & 5 construction

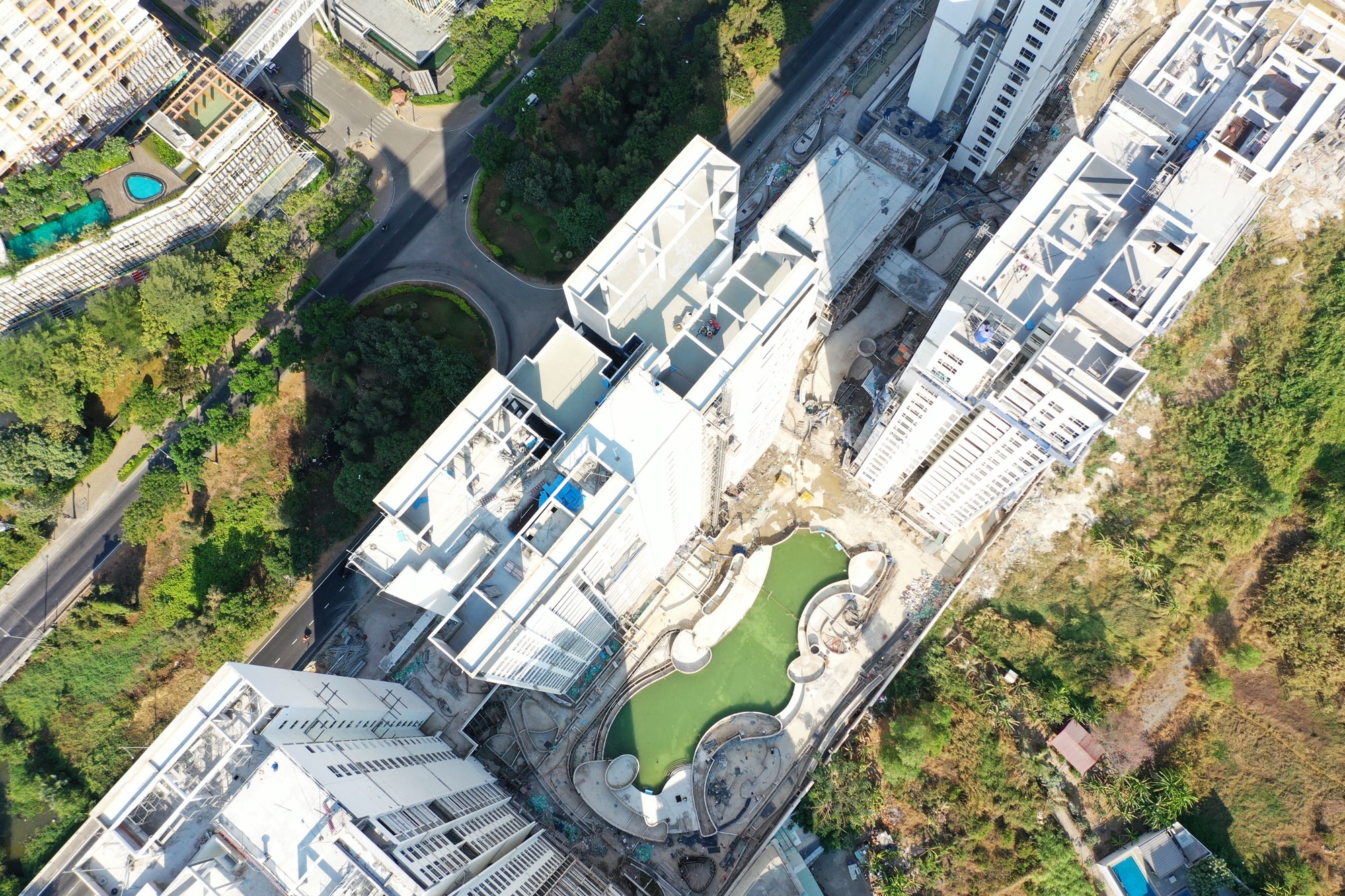

Overview of the swimming pool, tower 4 & 5 construction

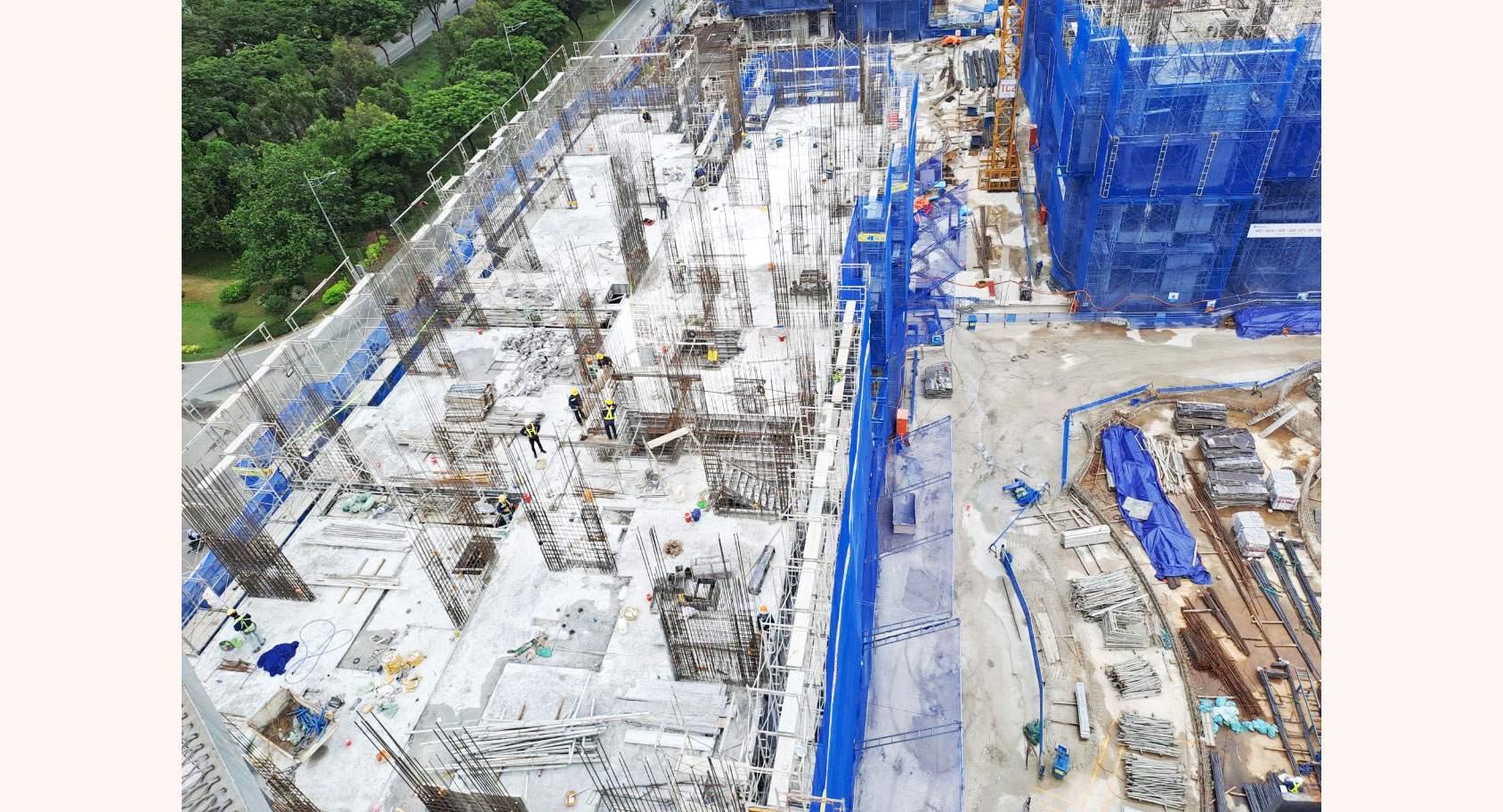

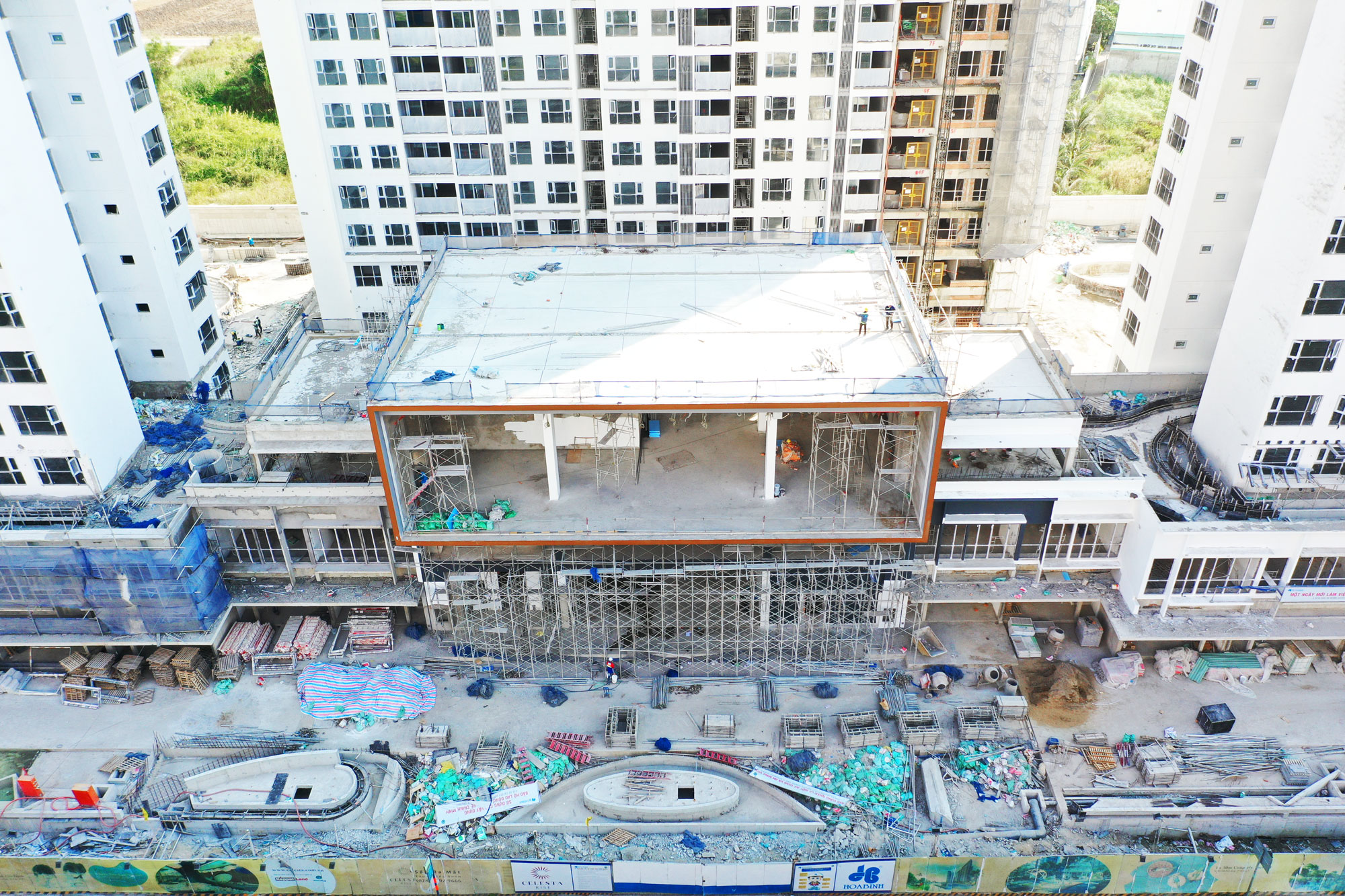

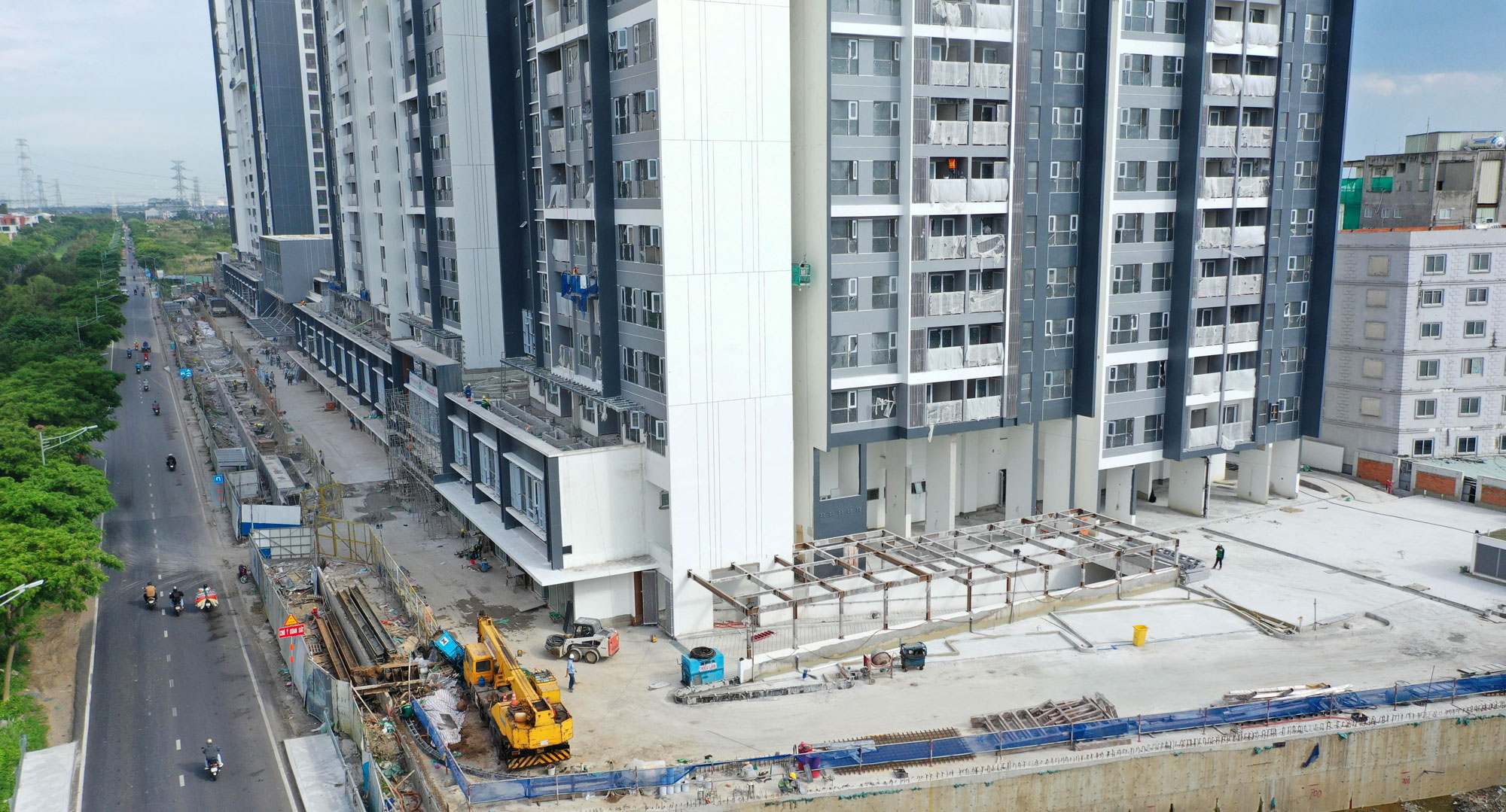

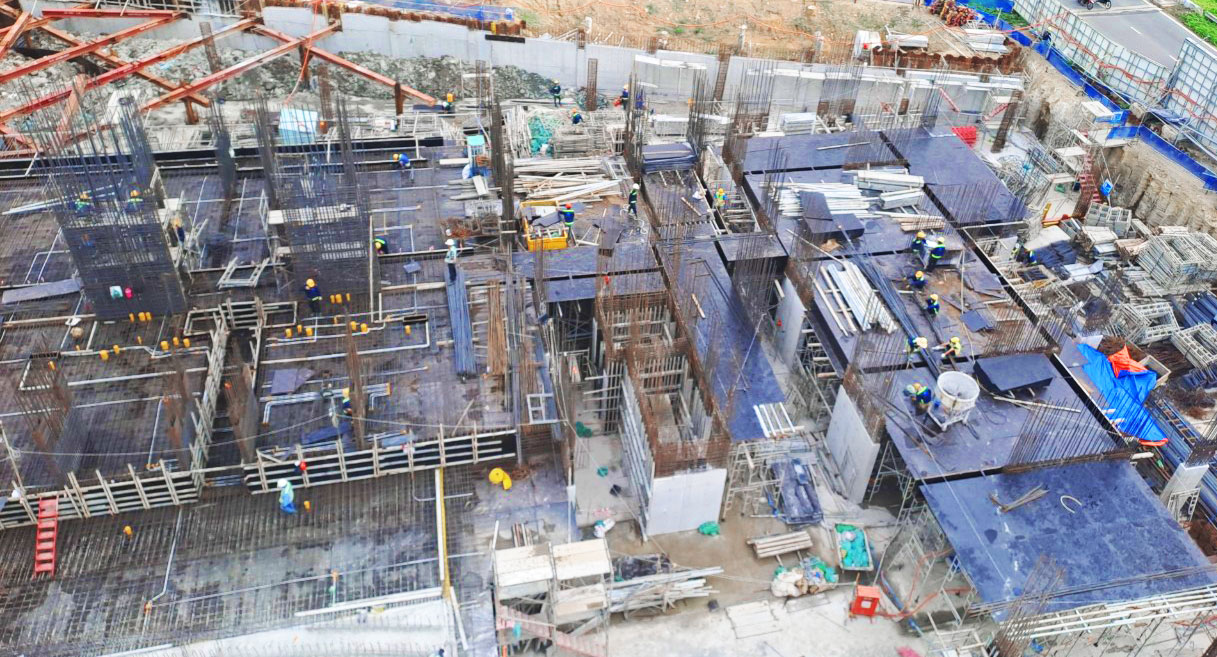

Formwork and rebar installation for ground floor slab (Tower 1) are in progress

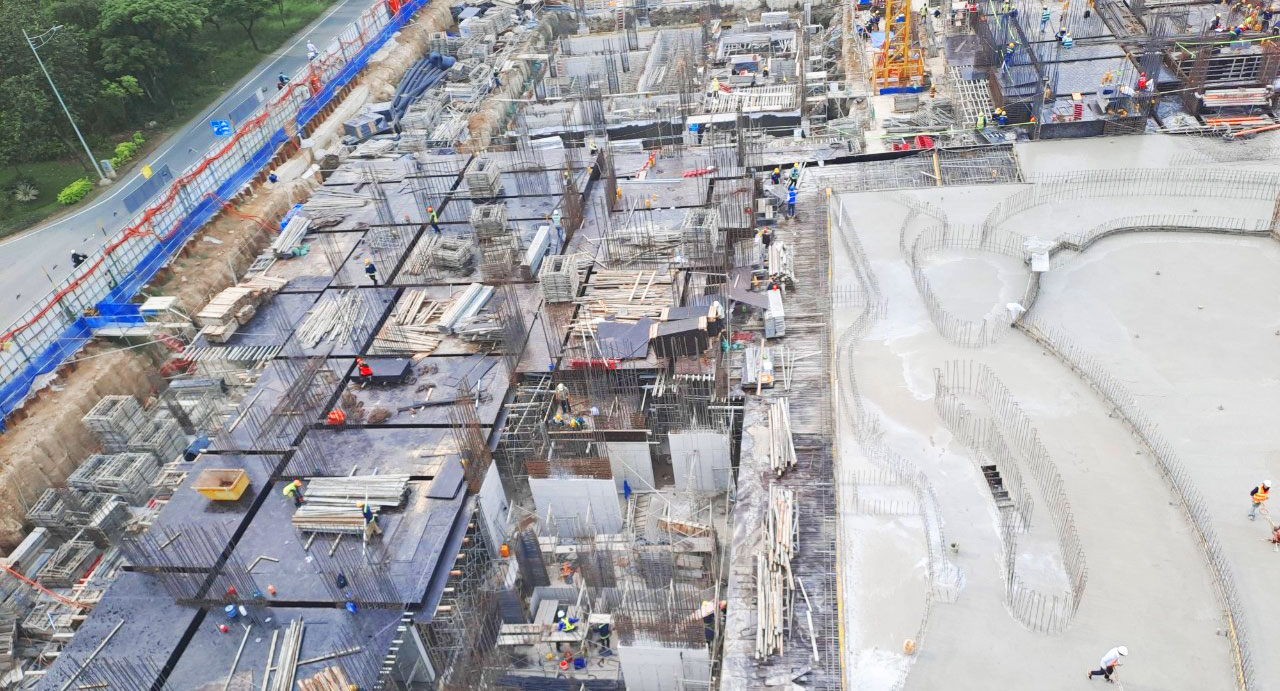

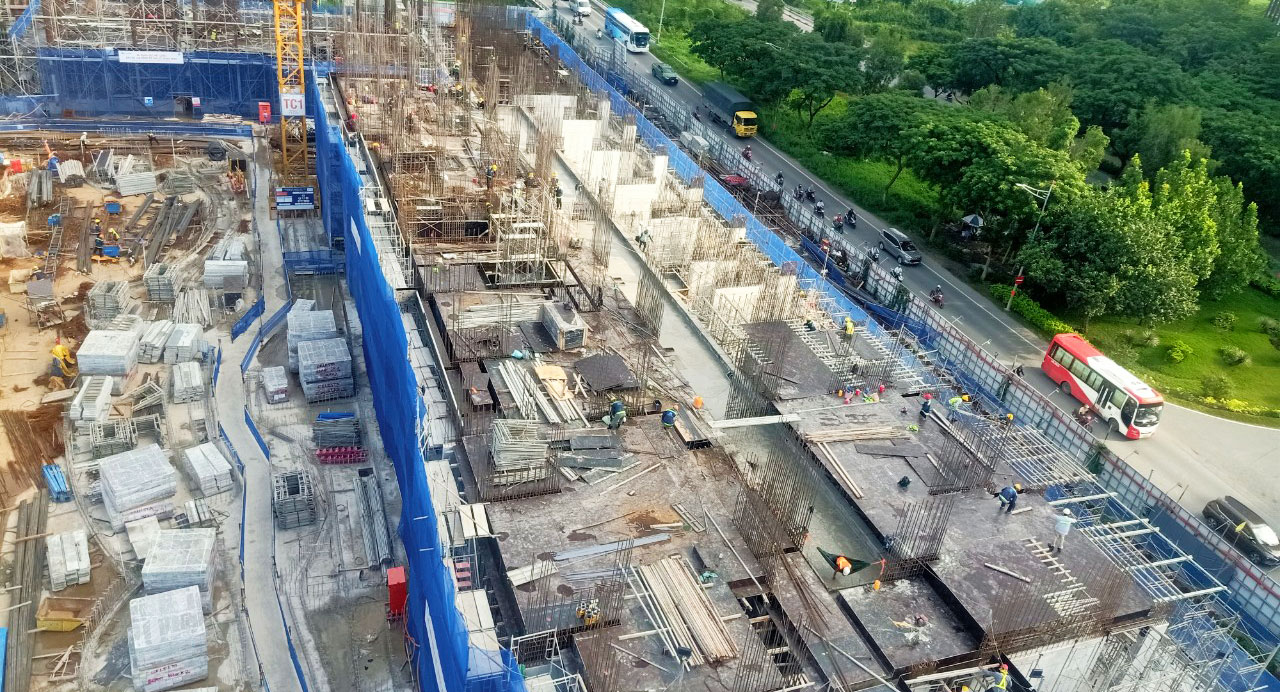

Formwork and rebar installation for ground floor slab (Tower 2) are in progress

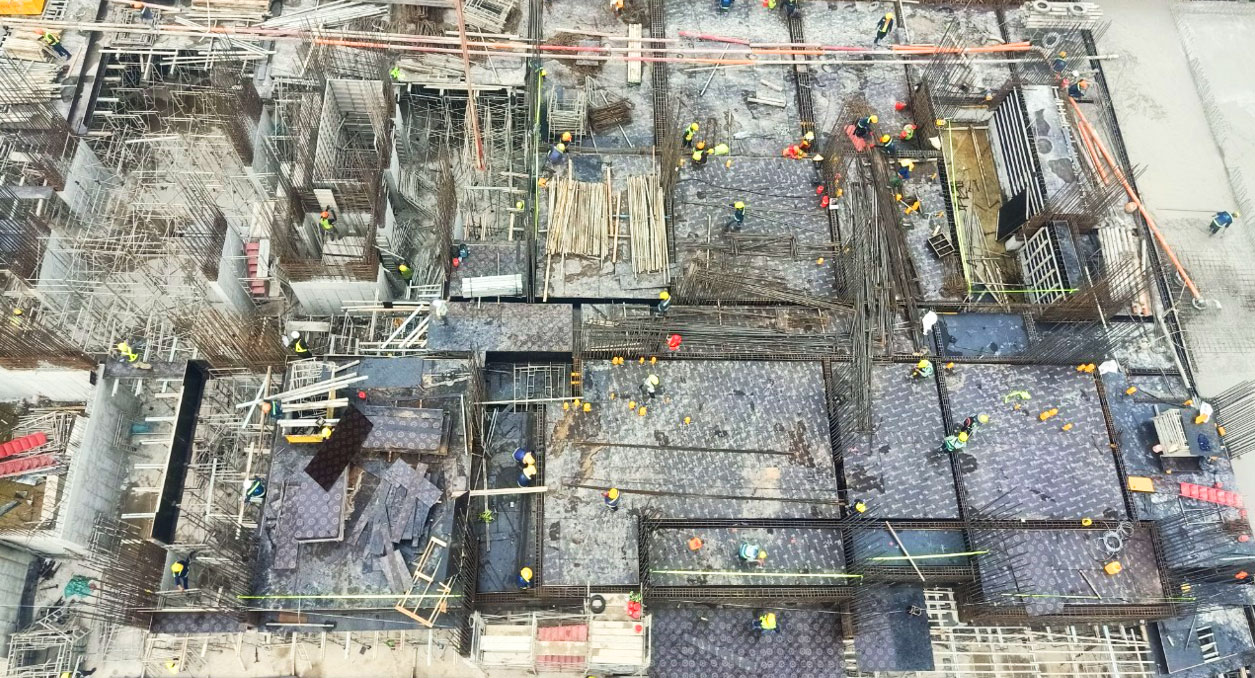

Formwork and rebar installation for ground floor slab (Tower 3) are in progress

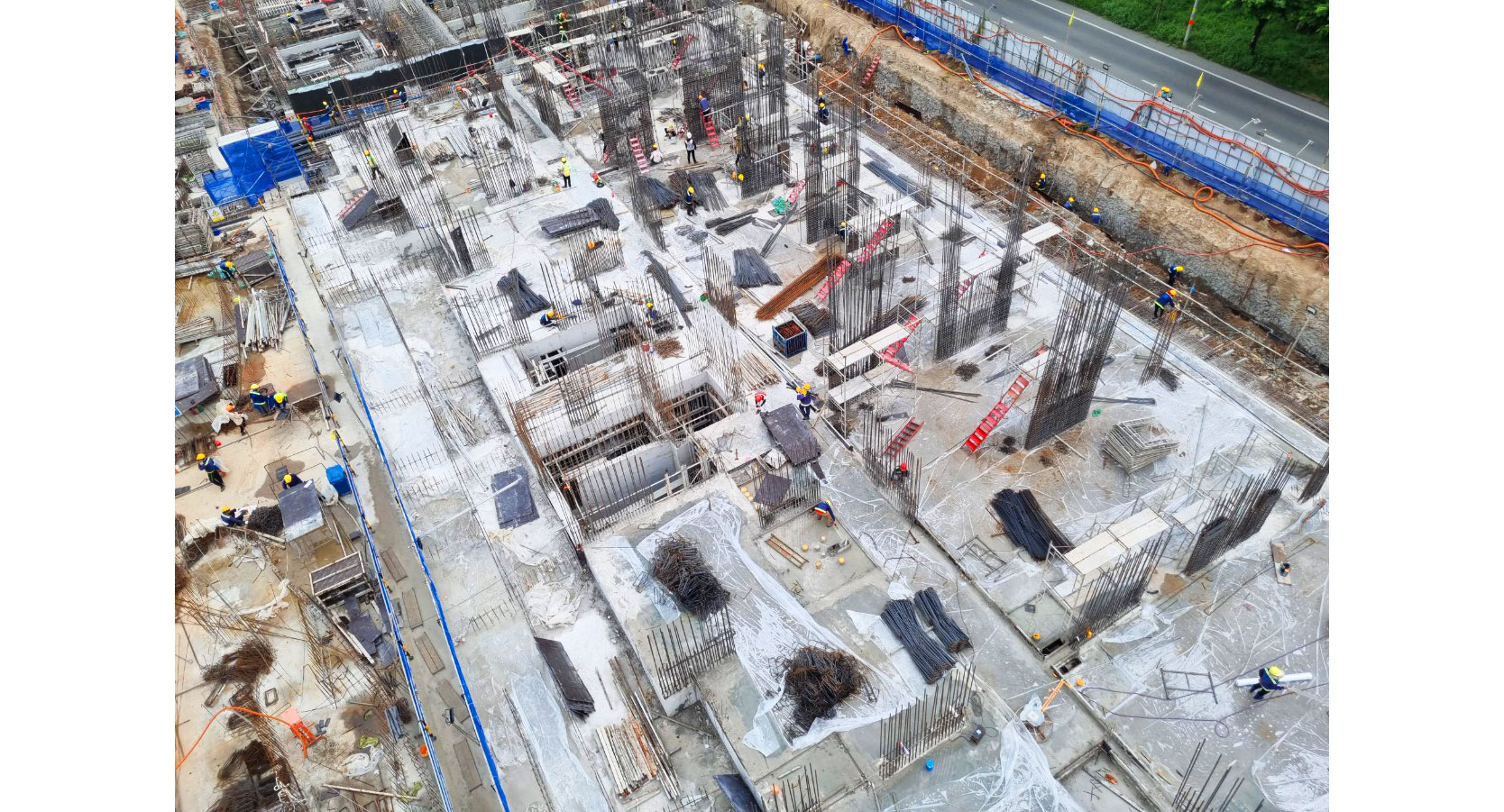

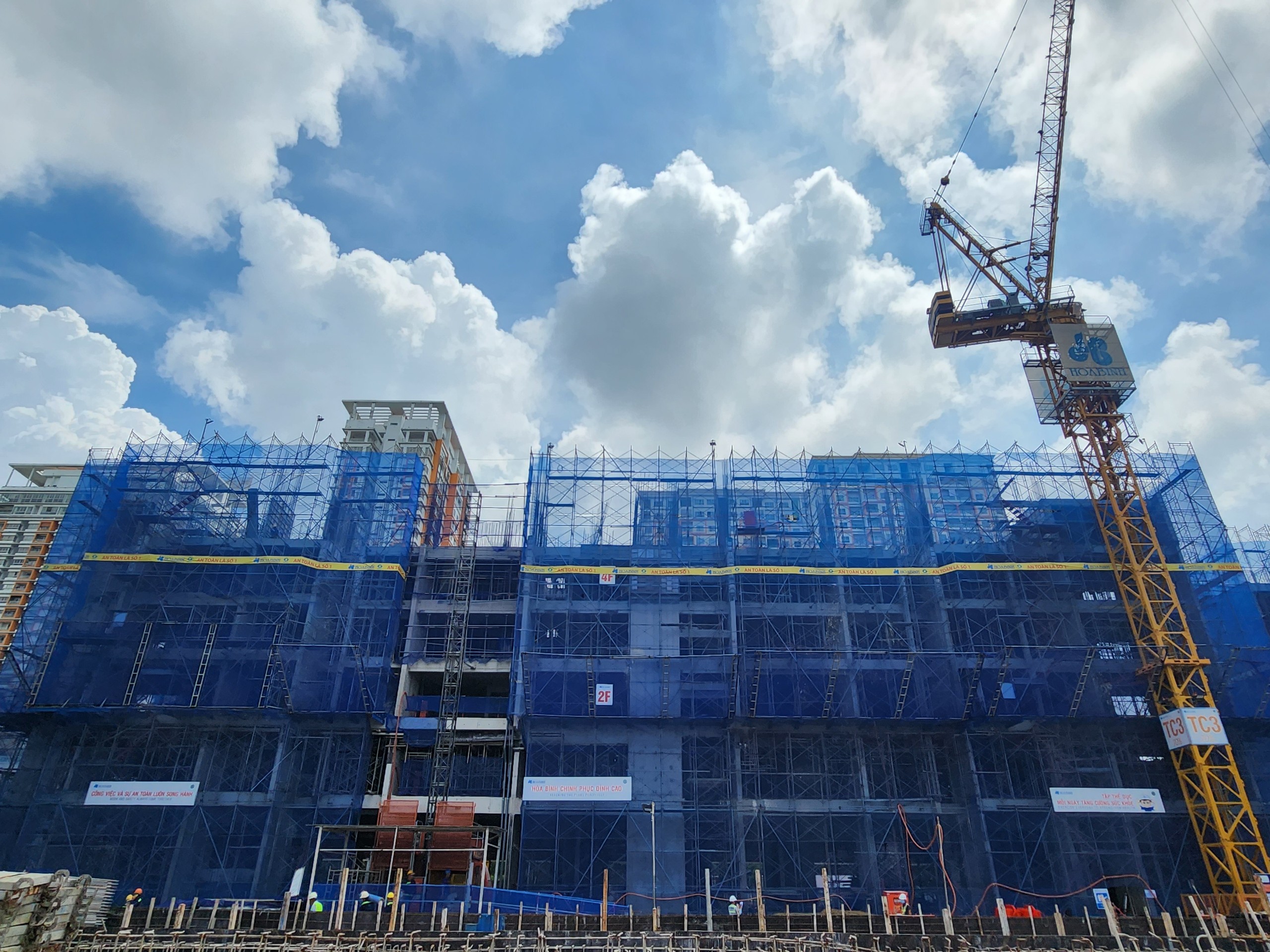

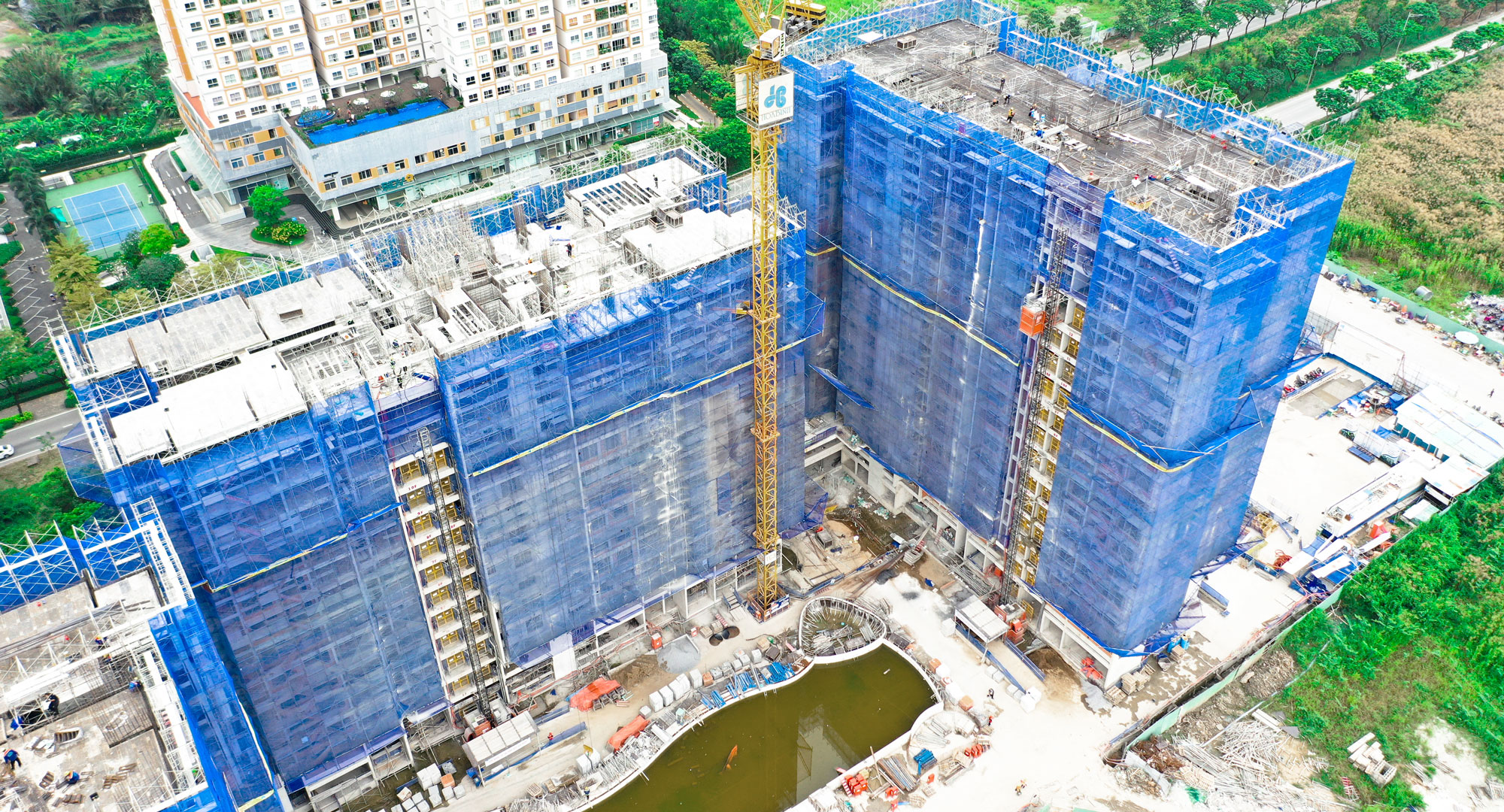

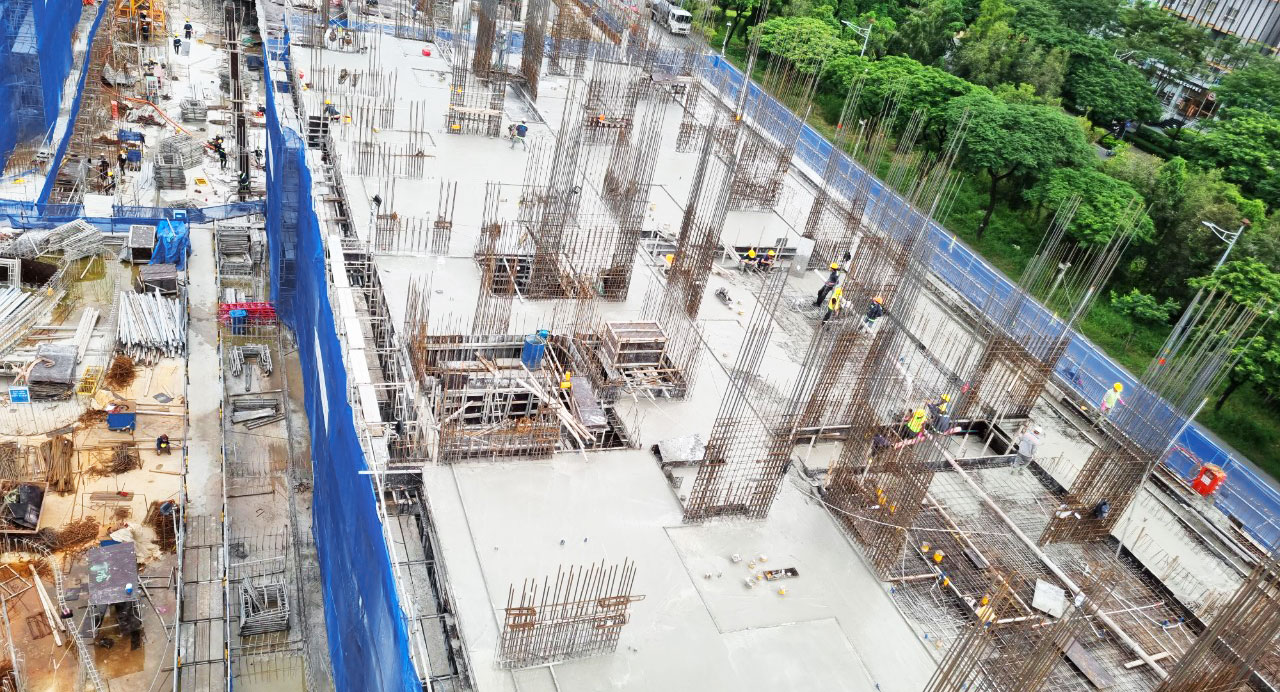

Formwork and rebar installation for ground floor wall and column (Tower 4) are in progress

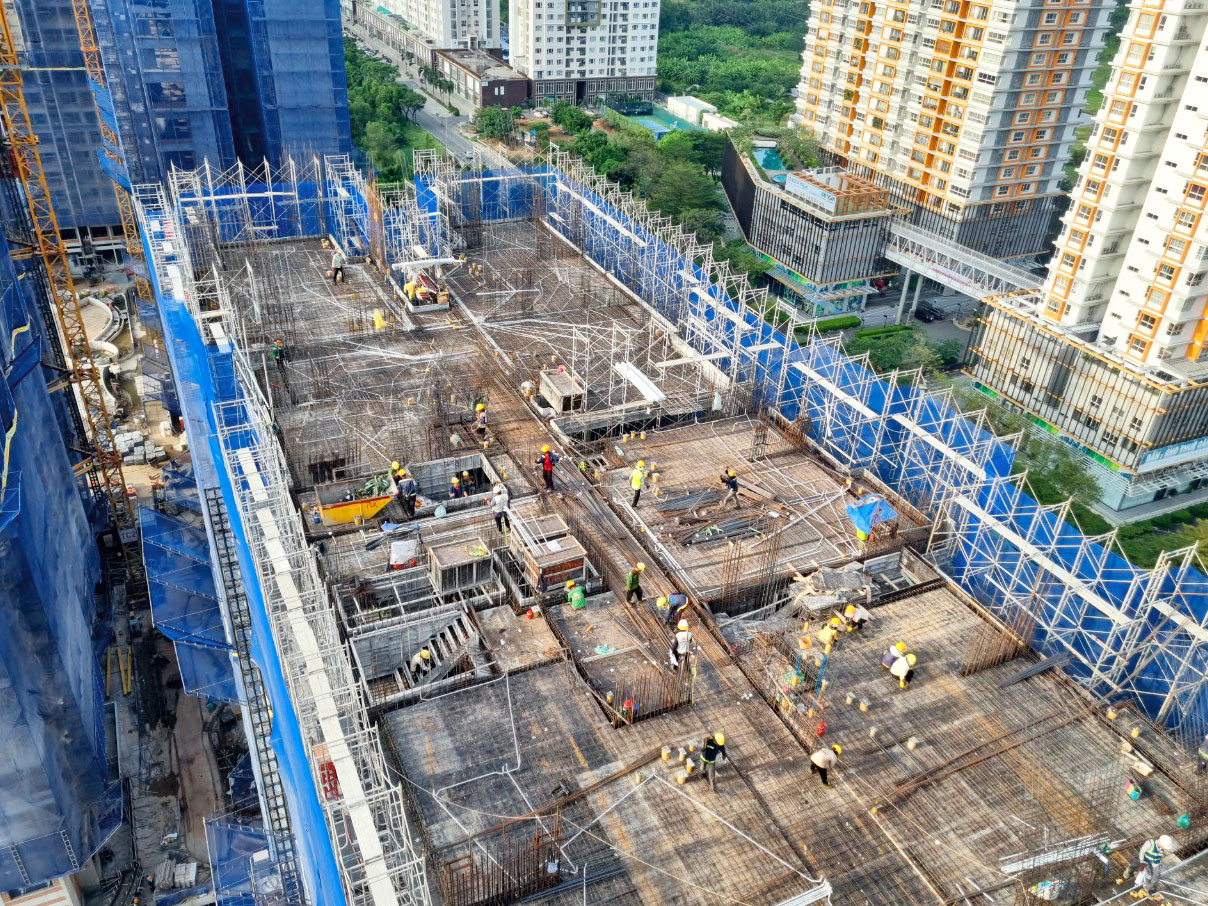

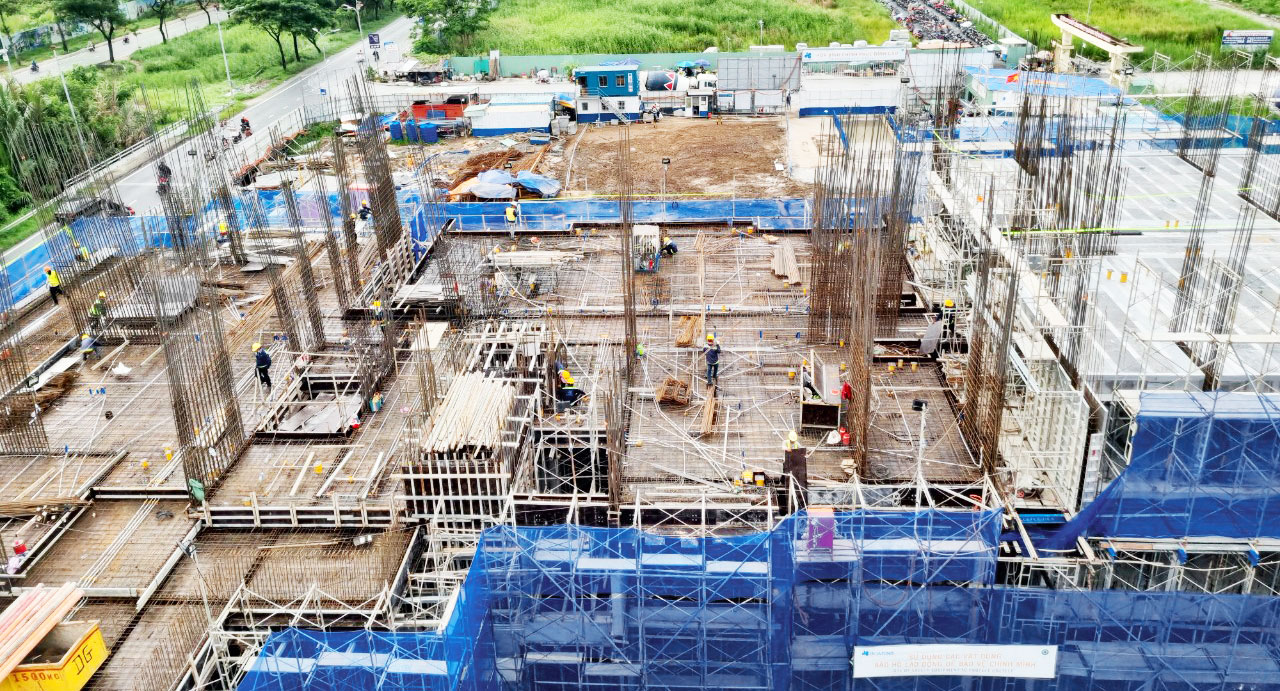

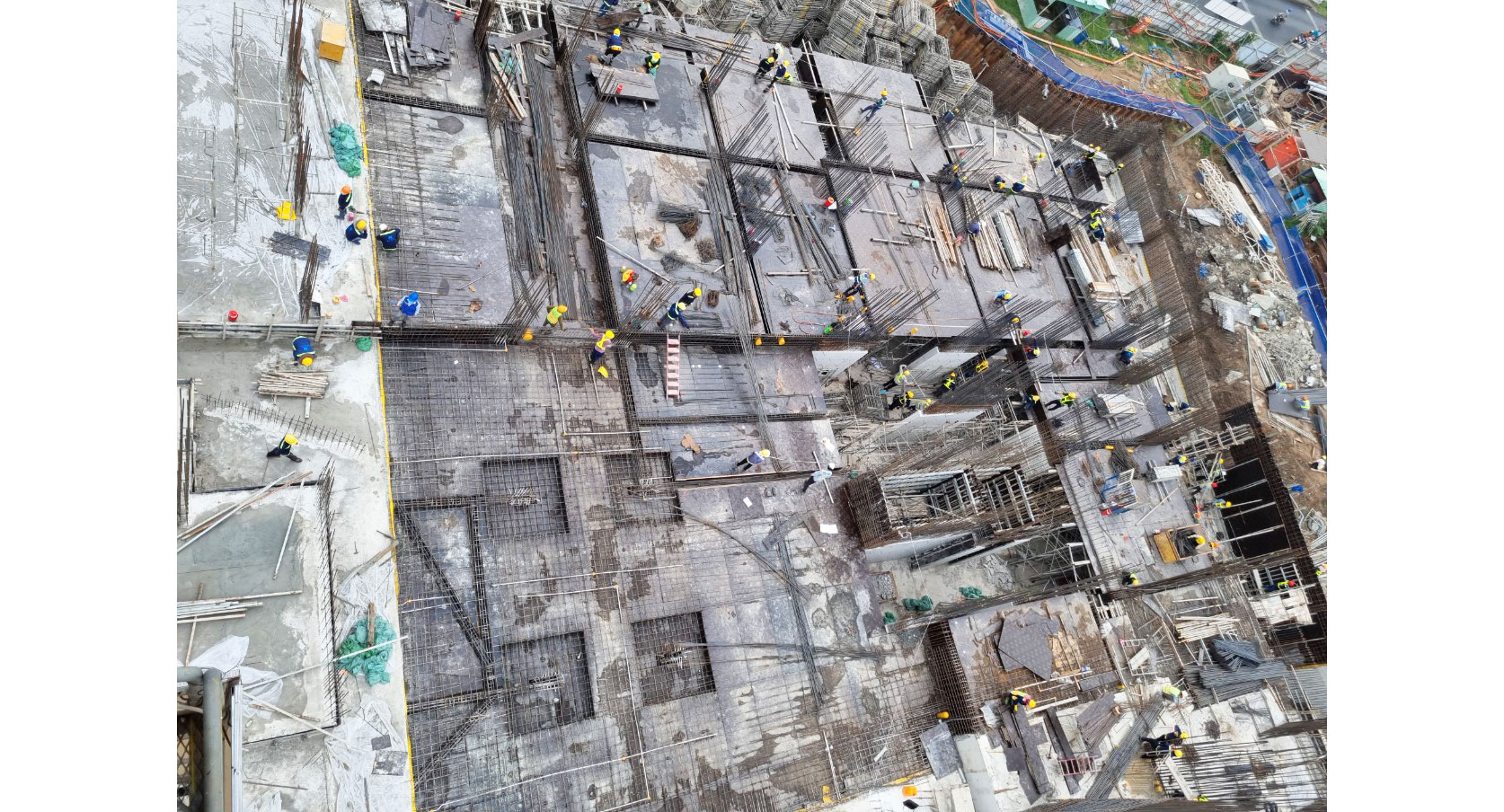

Formwork and rebar installation for ground floor slab (Tower 5) are in progress

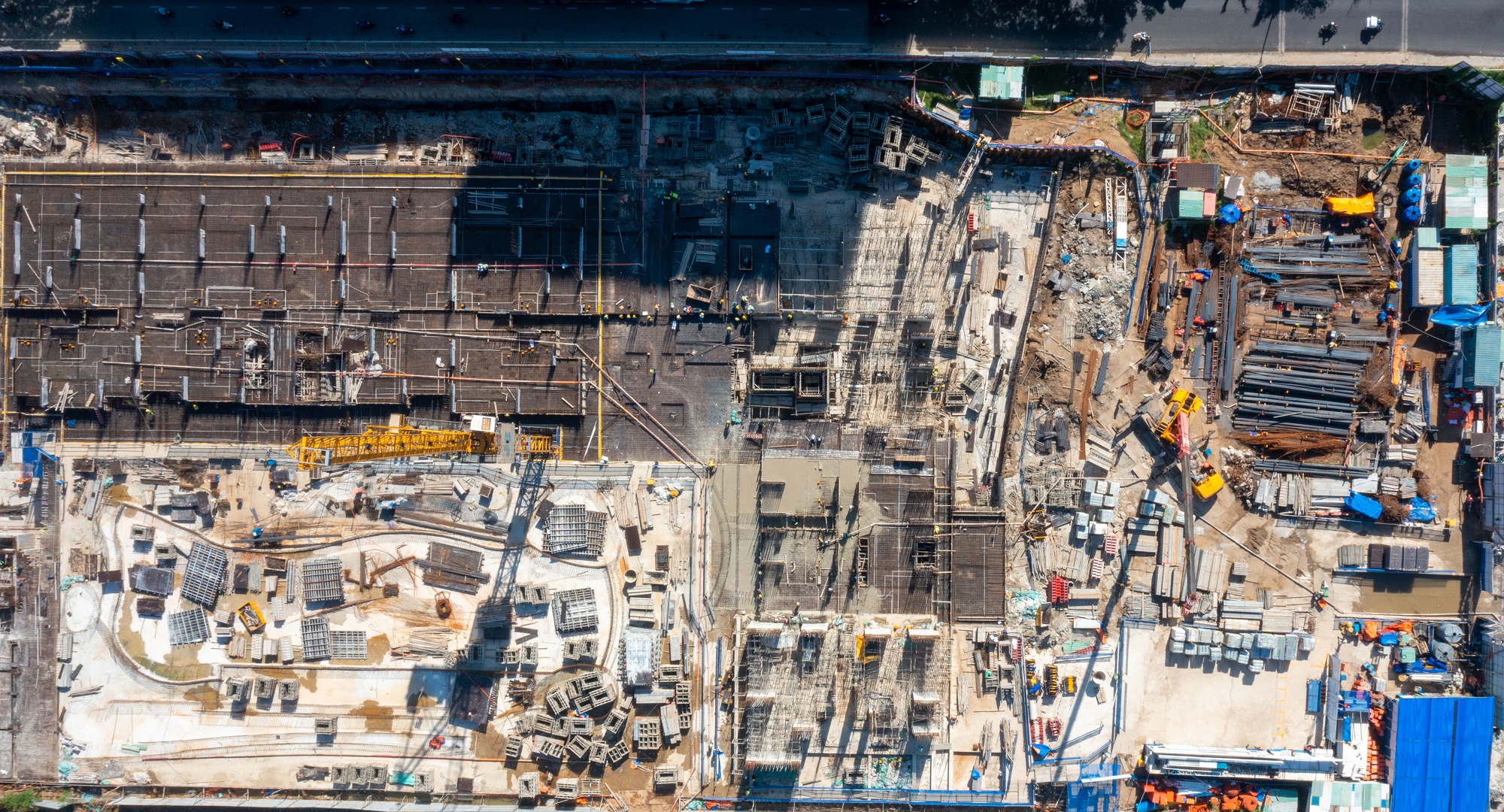

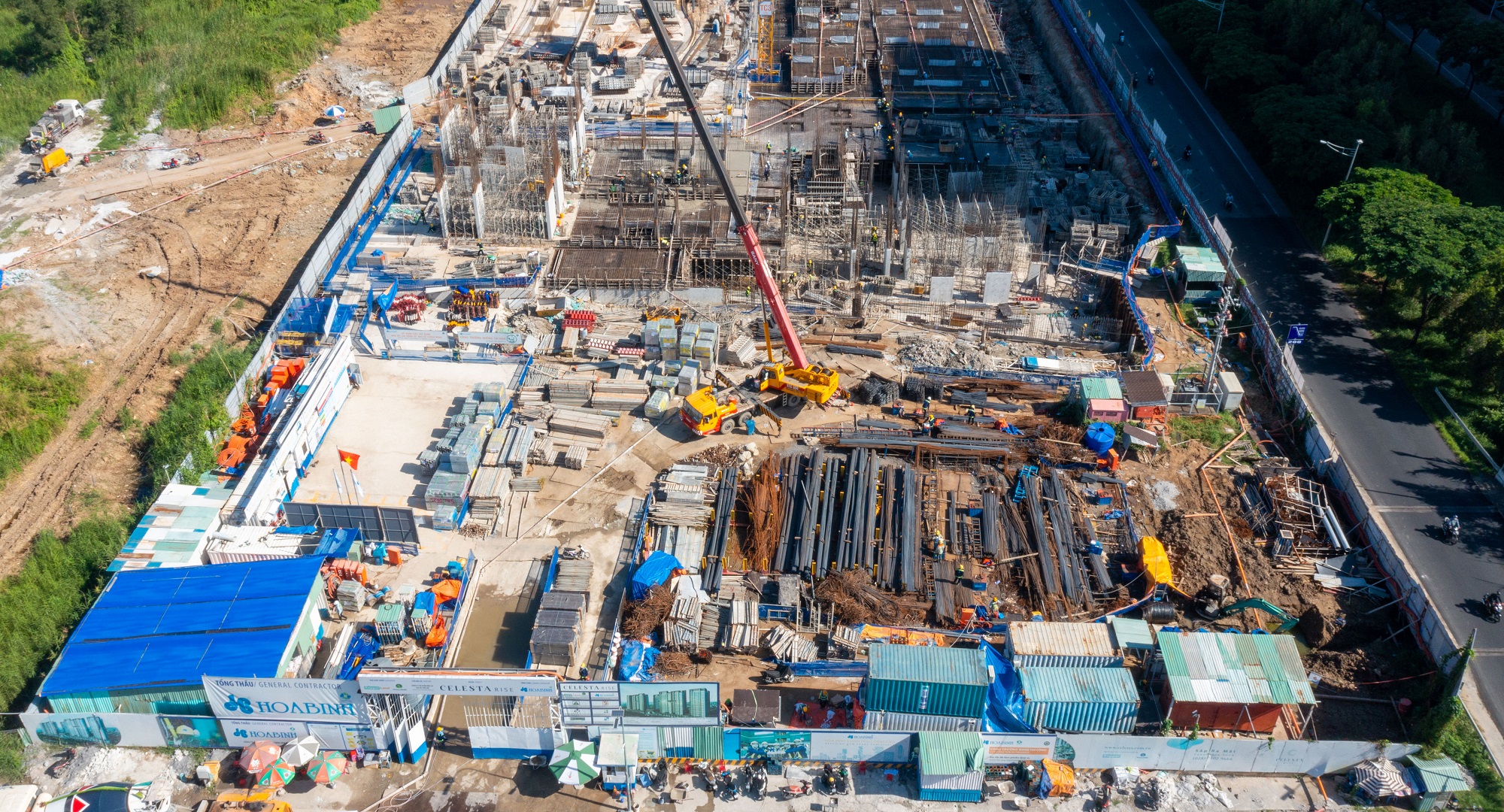

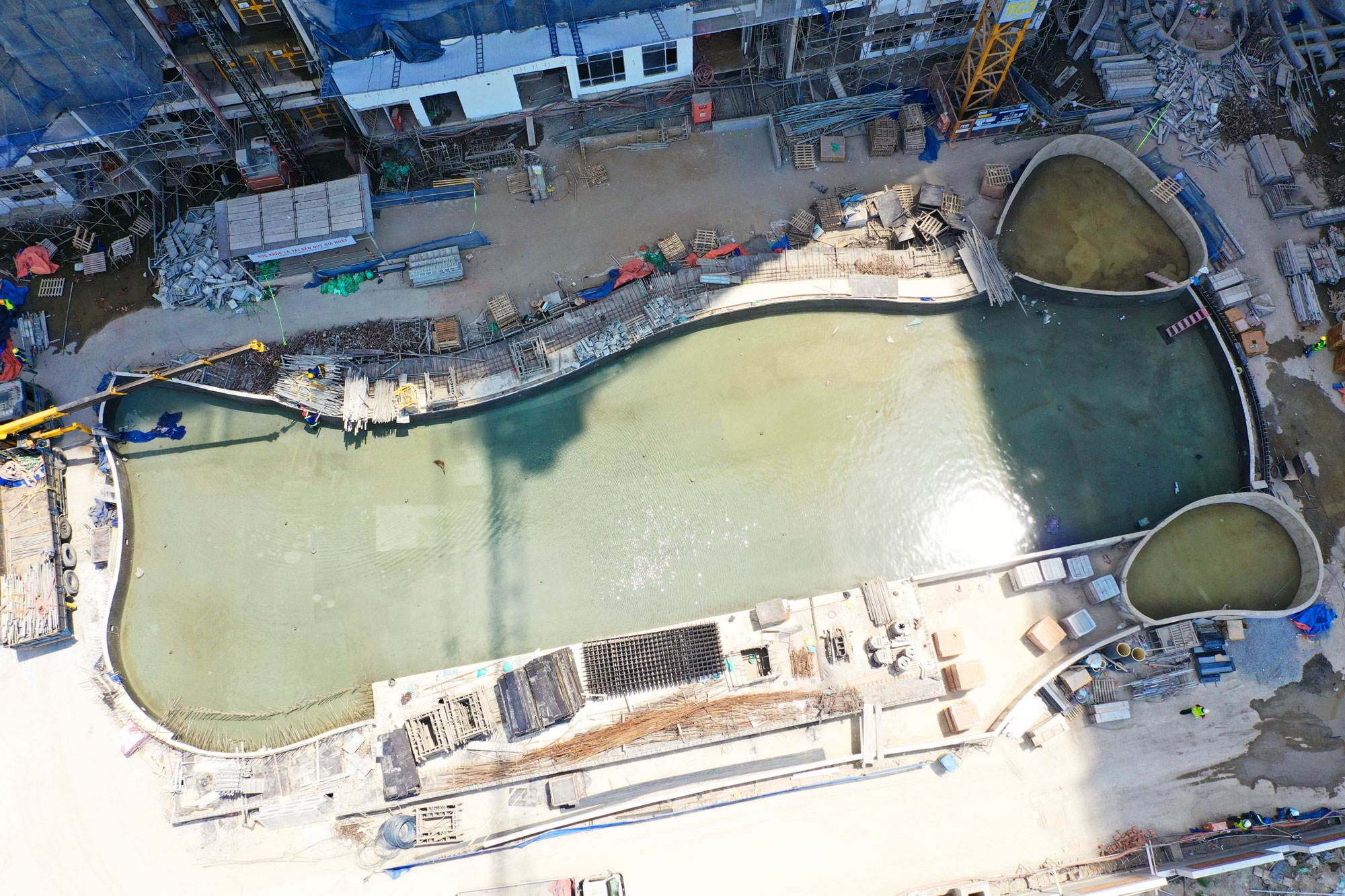

Overview of the public park and lake construction

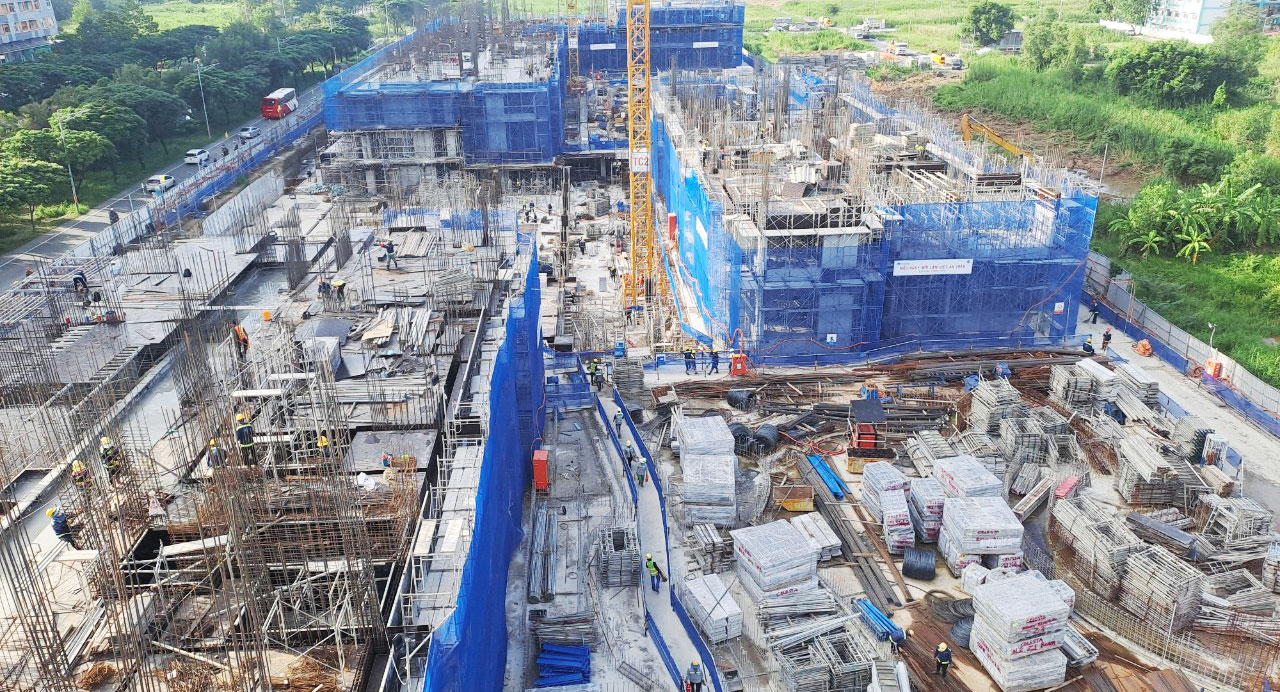

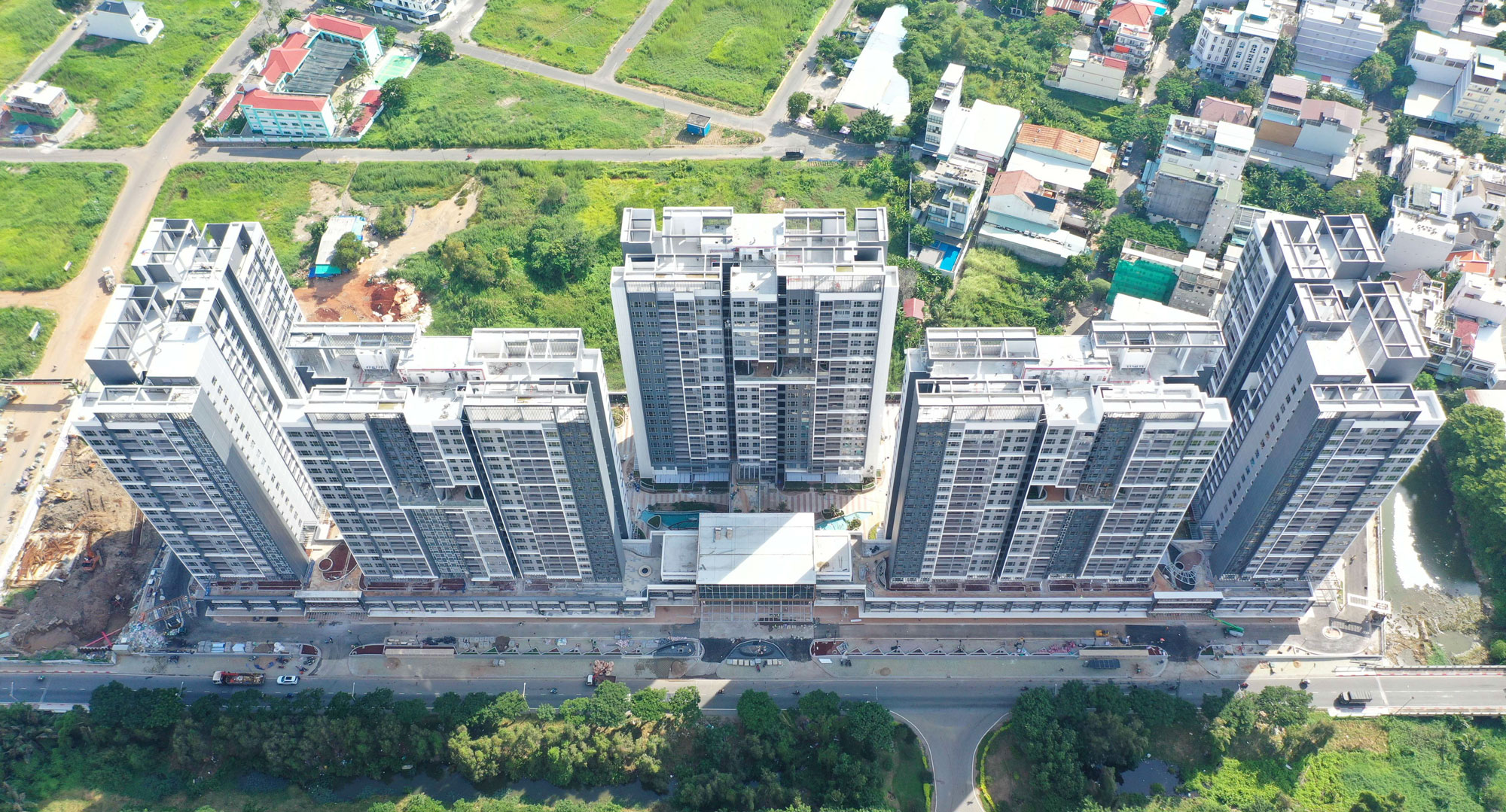

Overall construction site

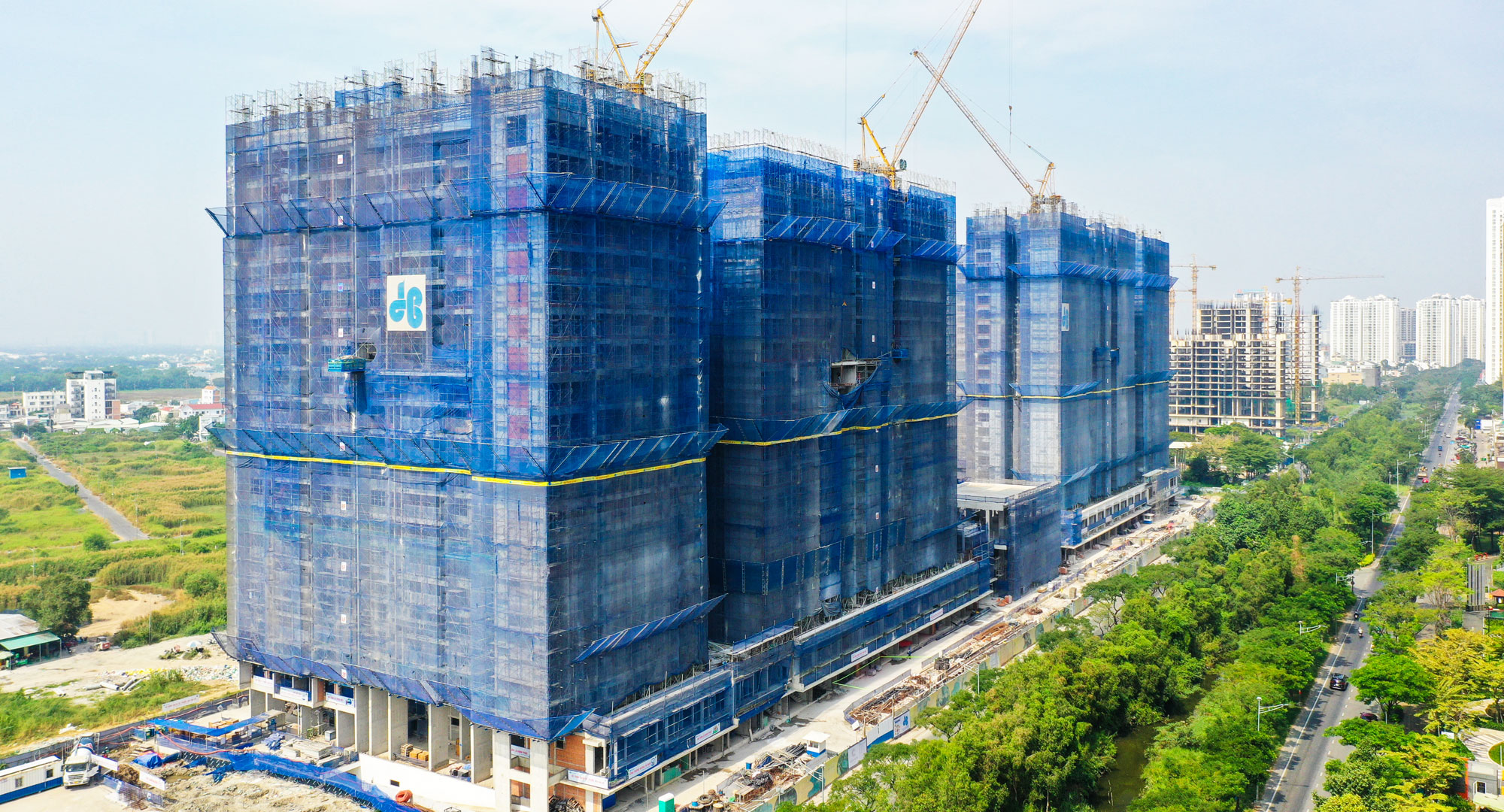

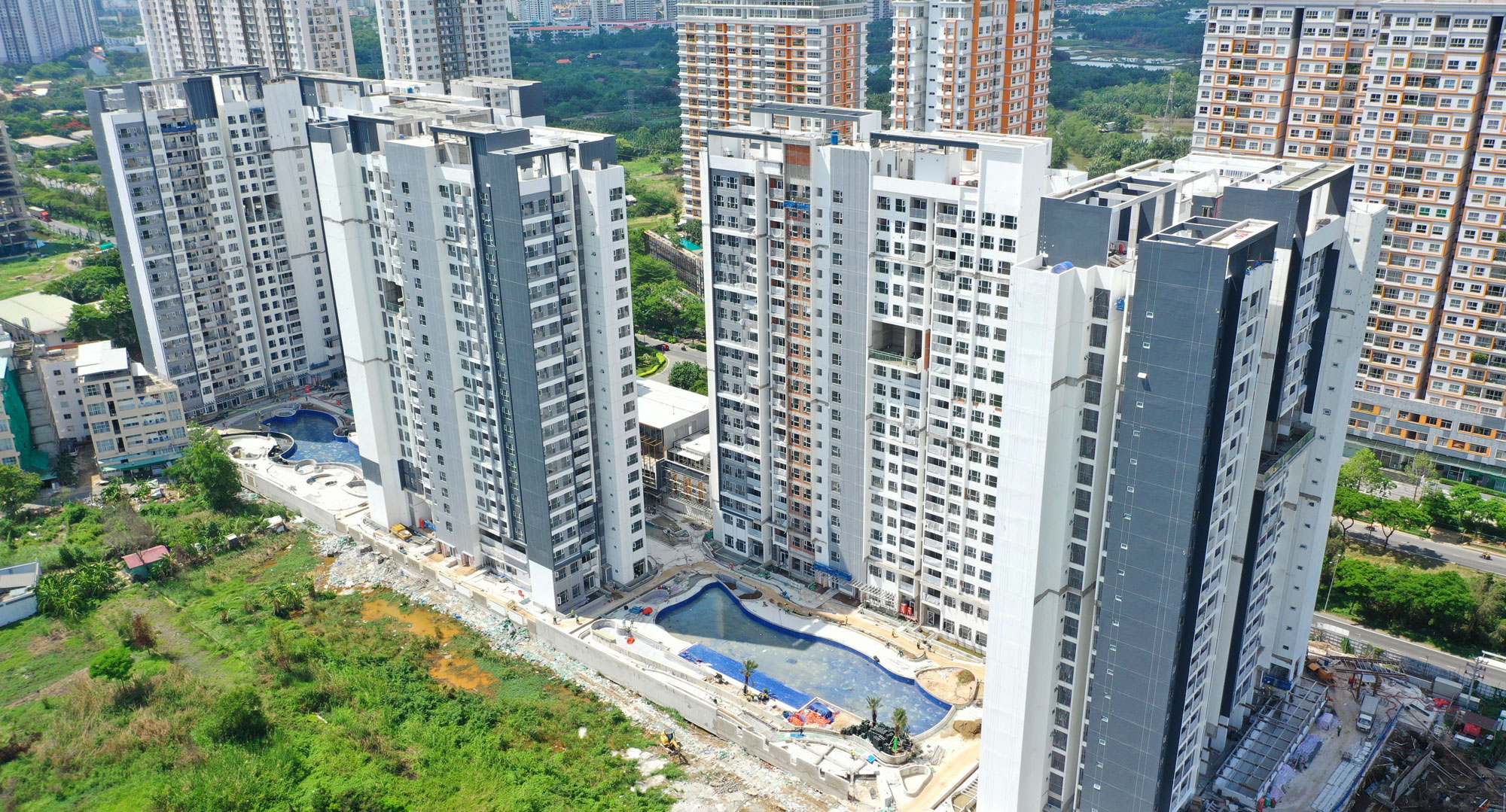

Overall construction site

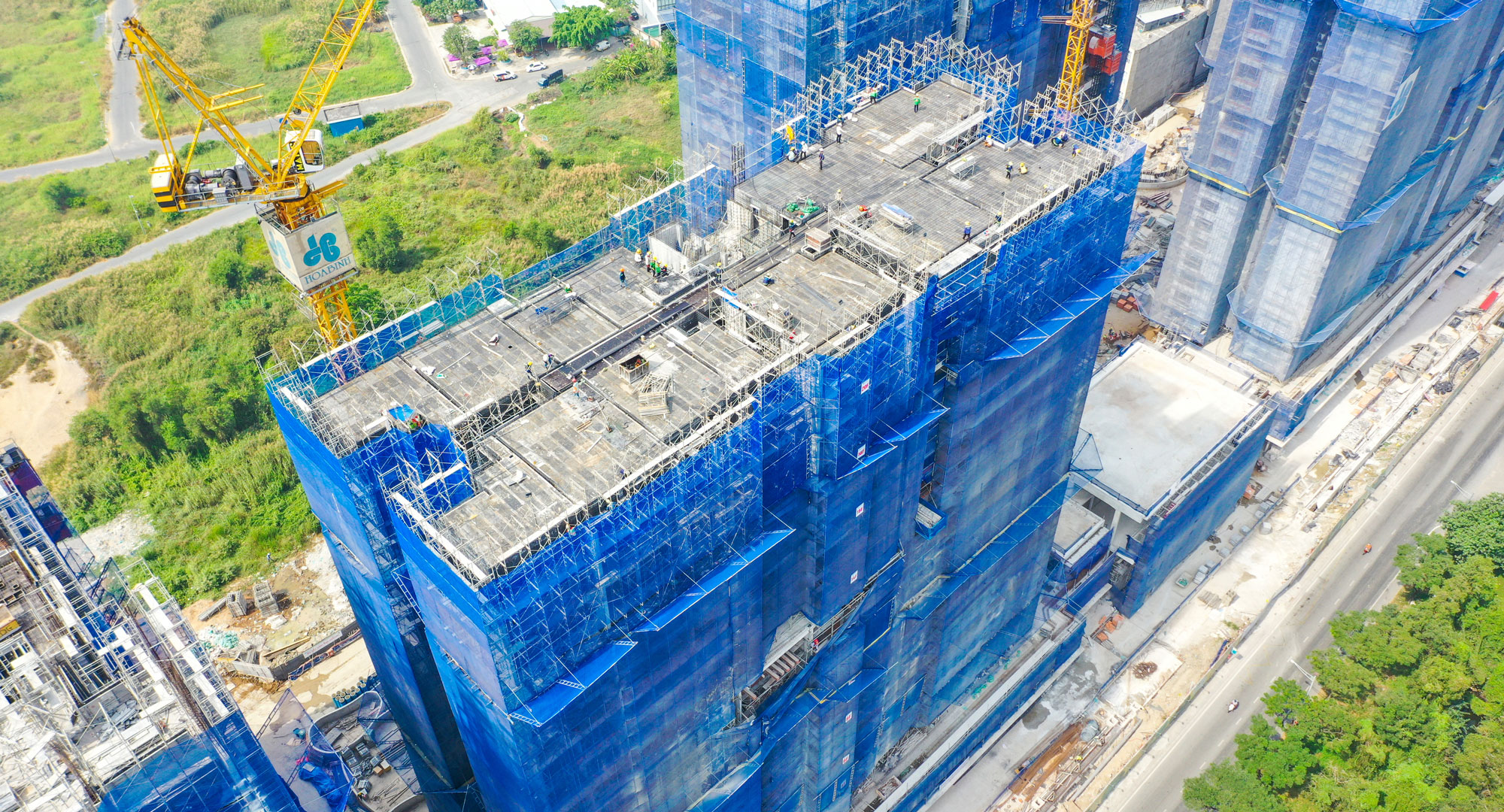

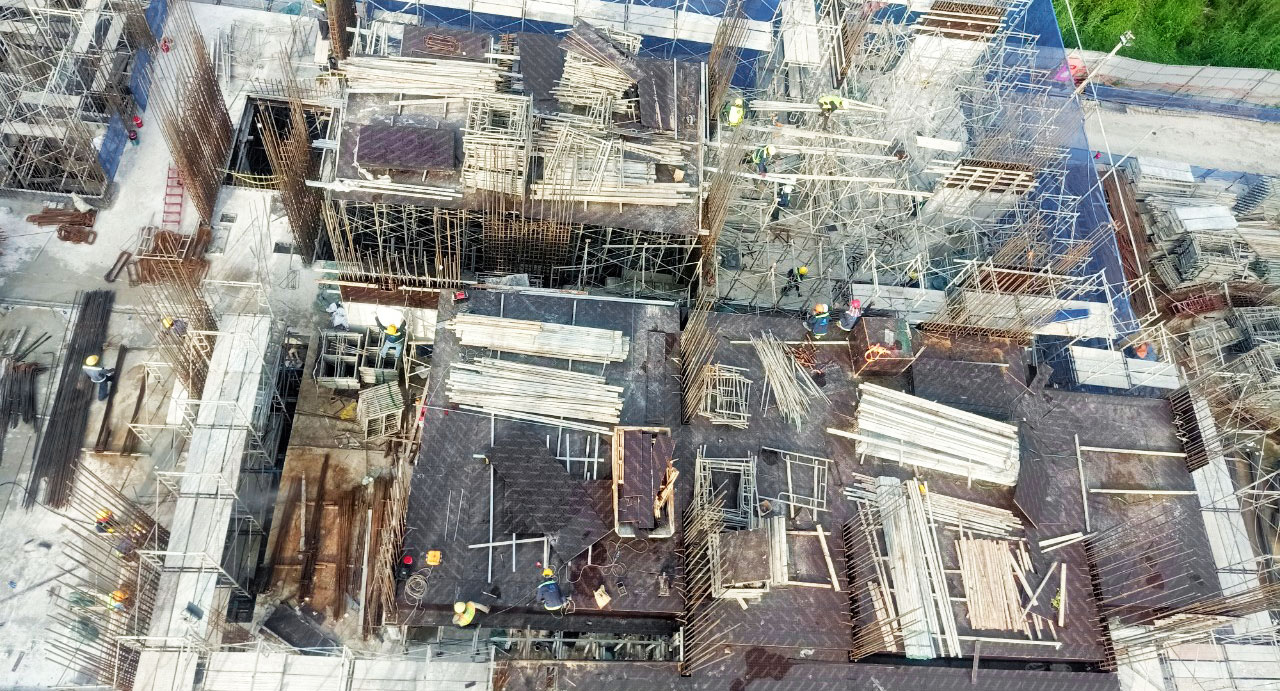

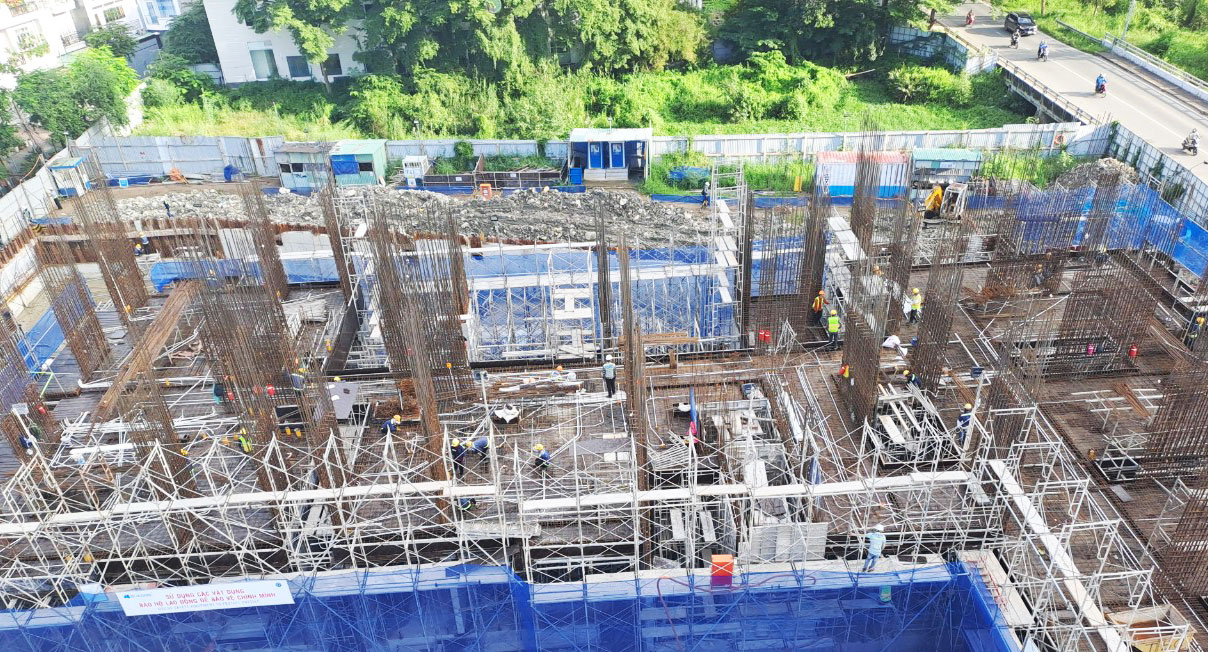

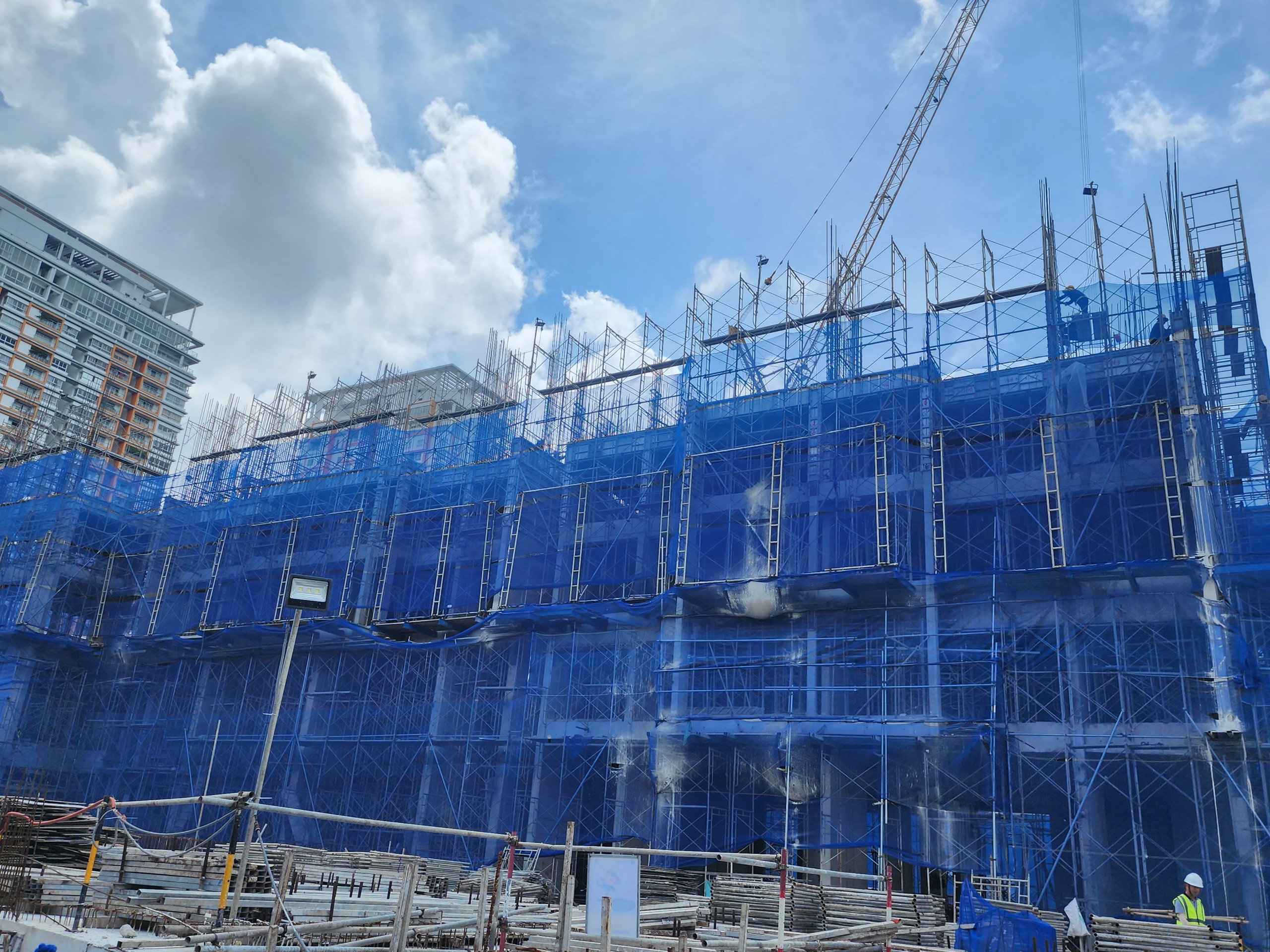

Formwork and rebar installtion for 1st floor (Tower 1) are in progress

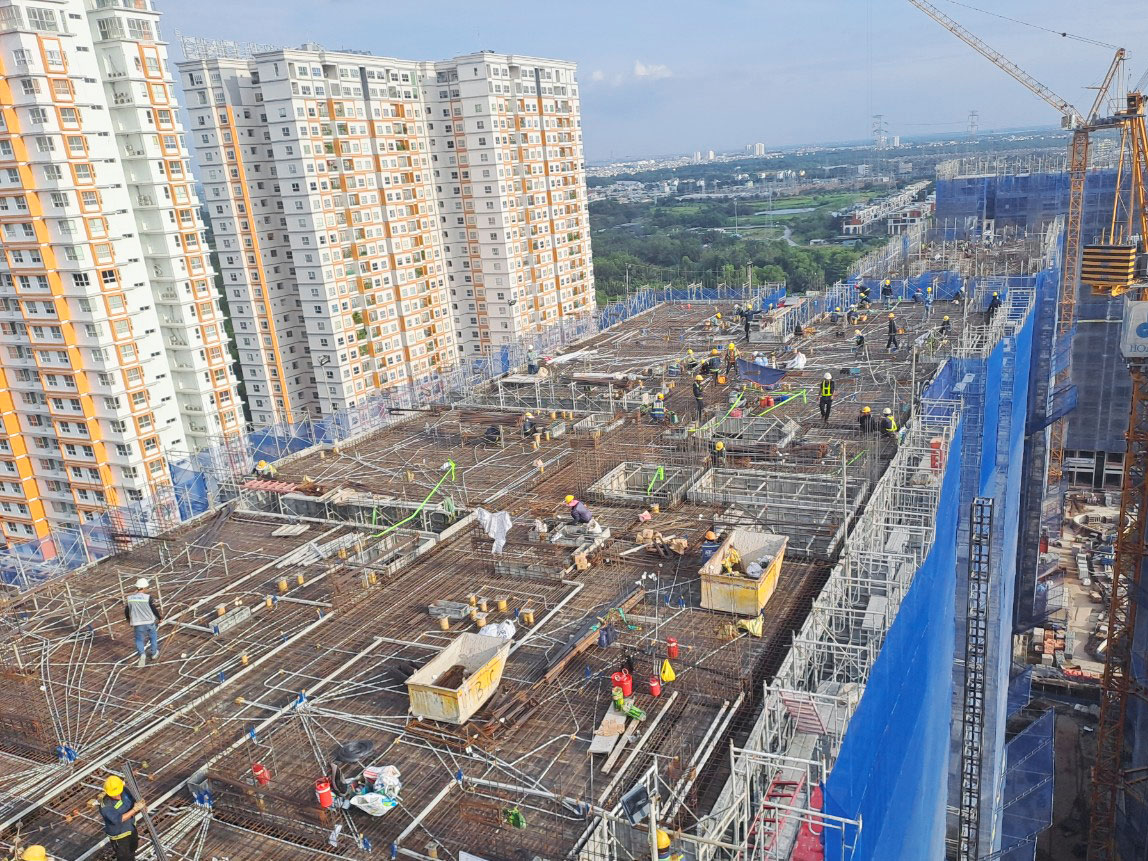

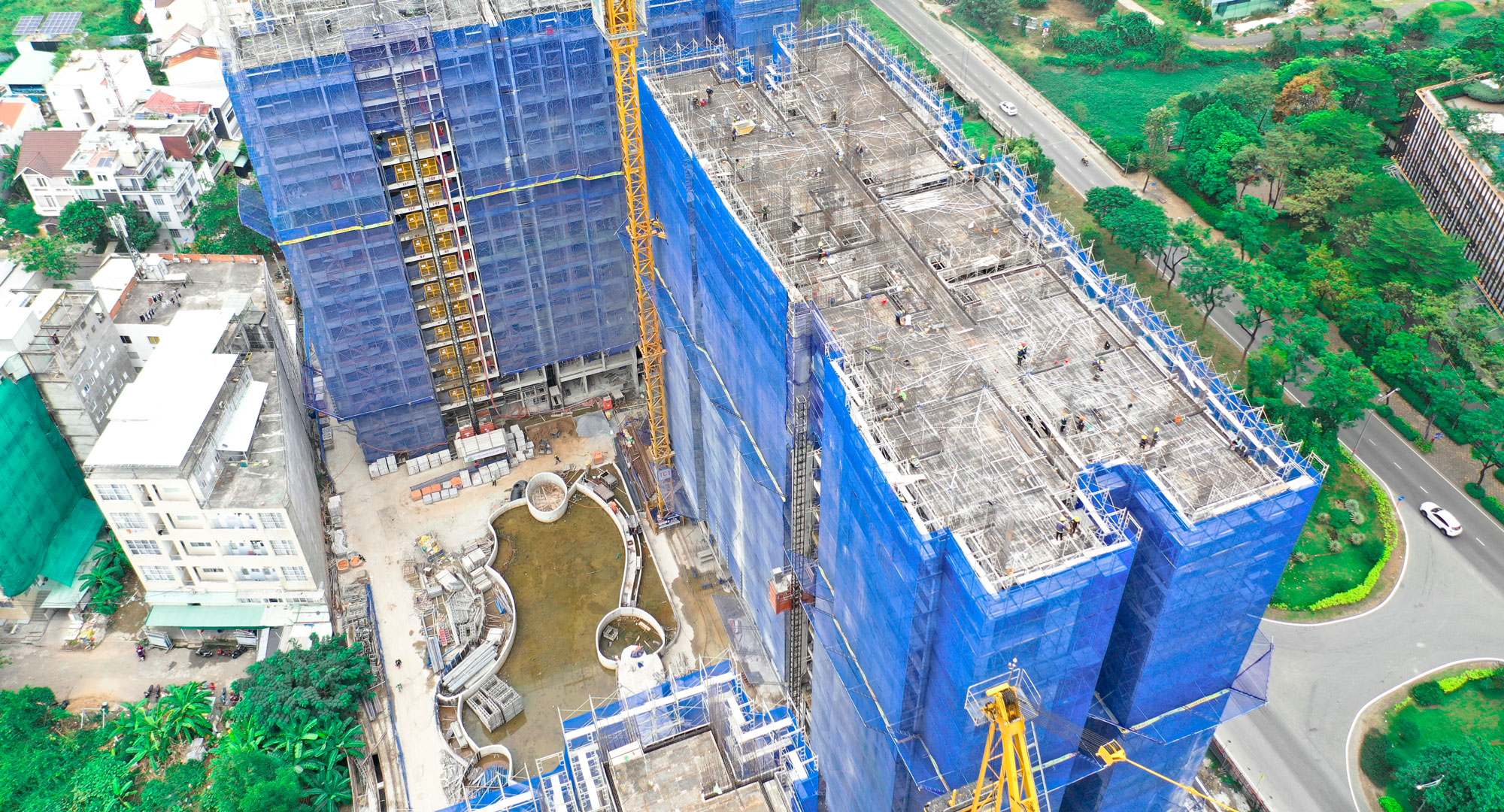

Formwork and rebar installtion for 2nd floor (Tower 2) are in progress
Formwork and rebar installtion for 2nd floor (Tower 3) are in progress
Formwork and rebar installtion for 2nd floor (Tower 4) are in progress

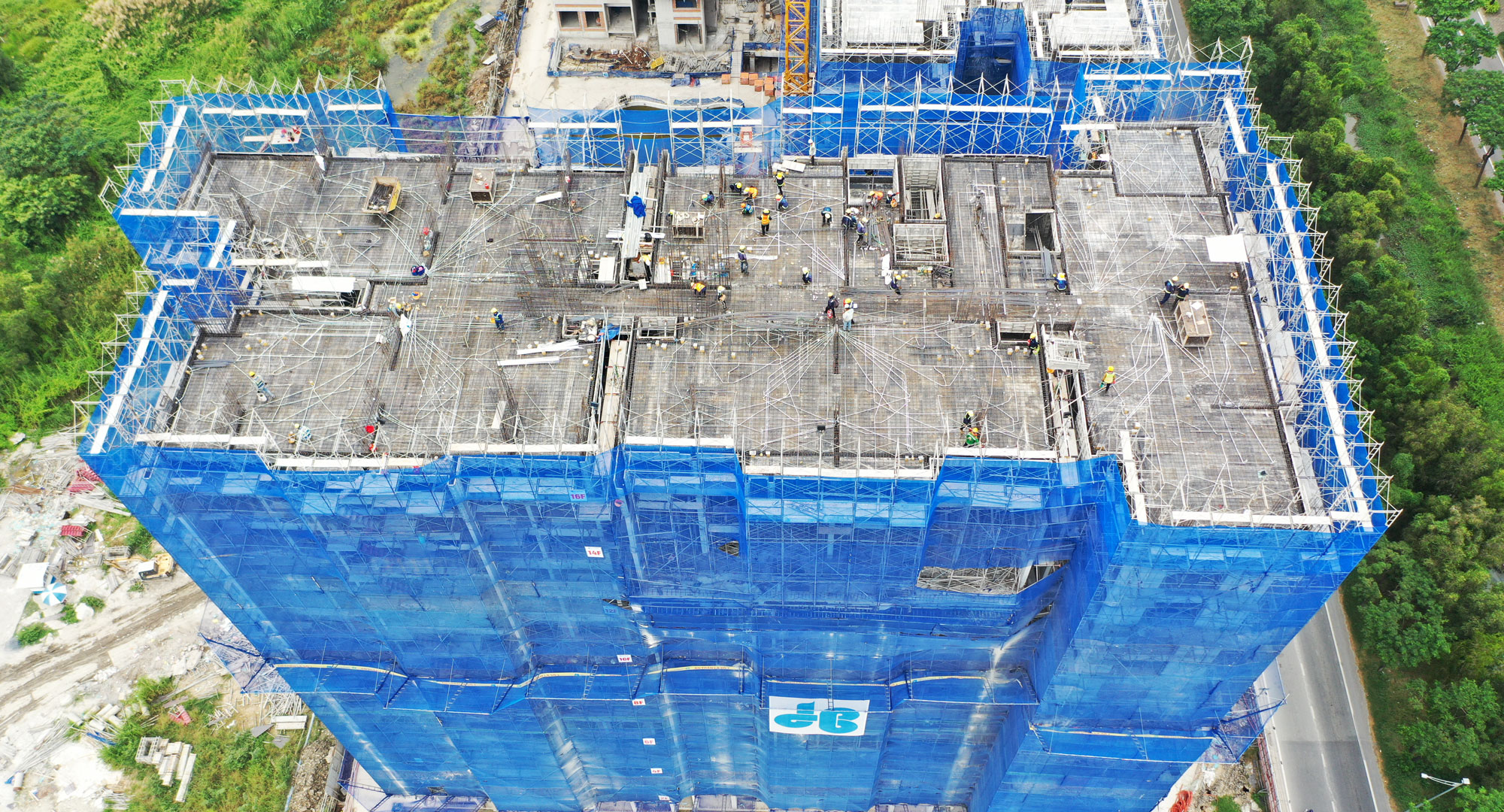

Formwork and rebar installtion for 3rd floor (Tower 5) are in progress

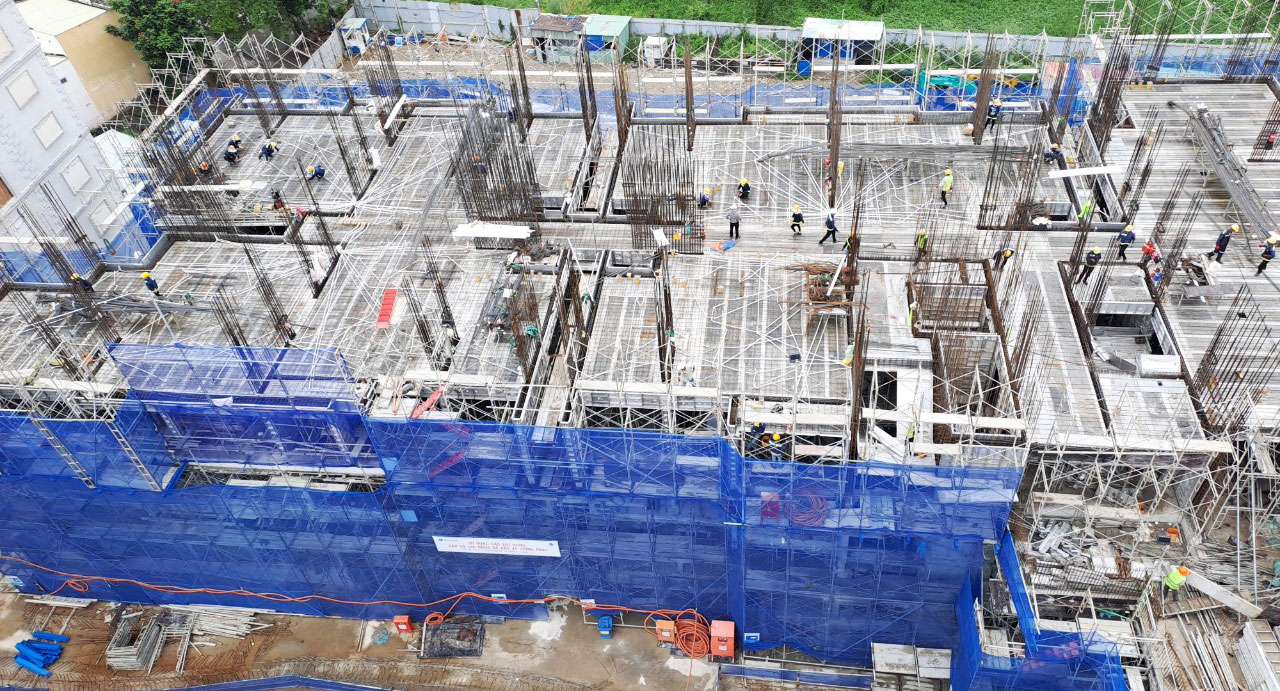

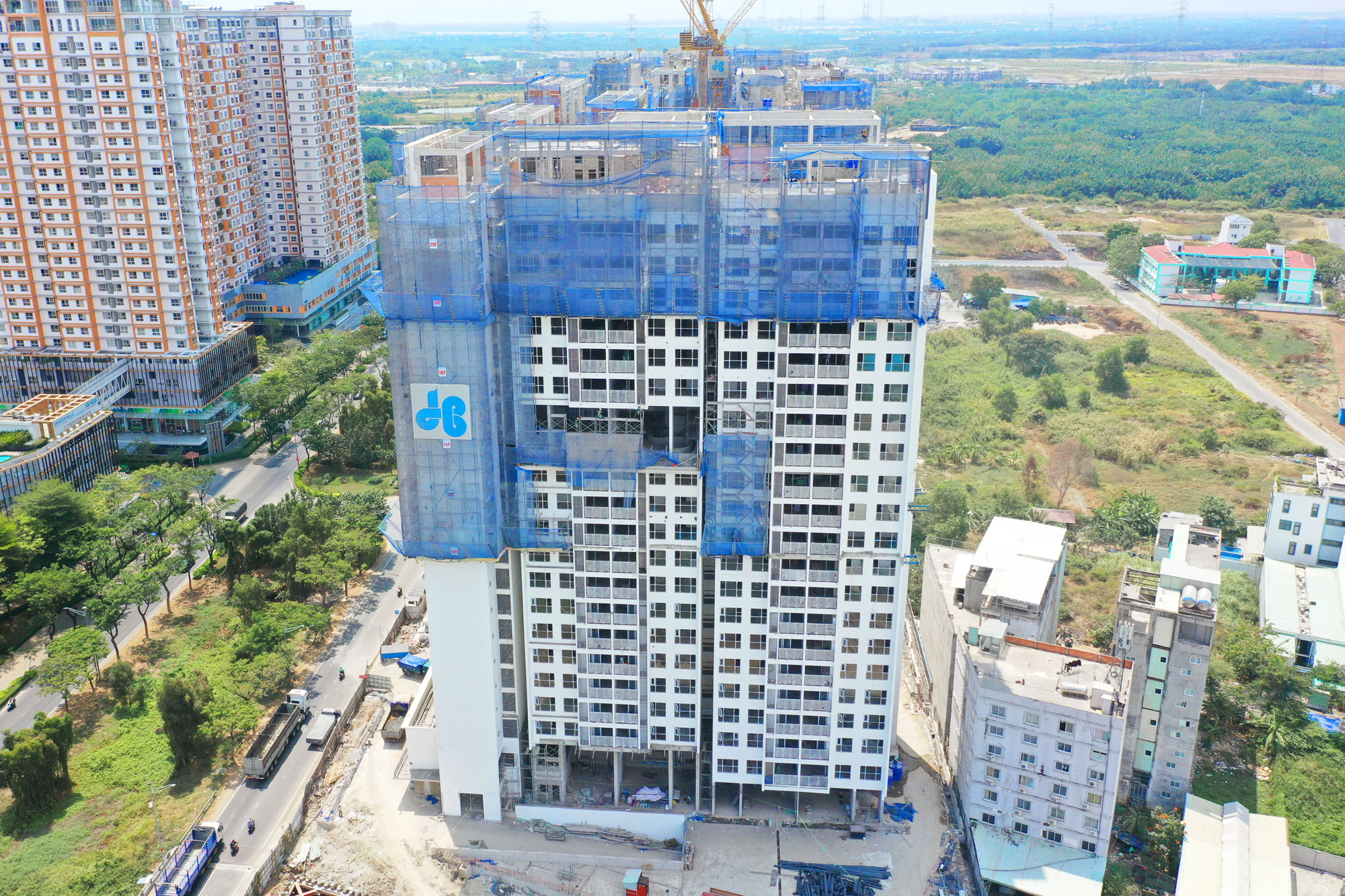

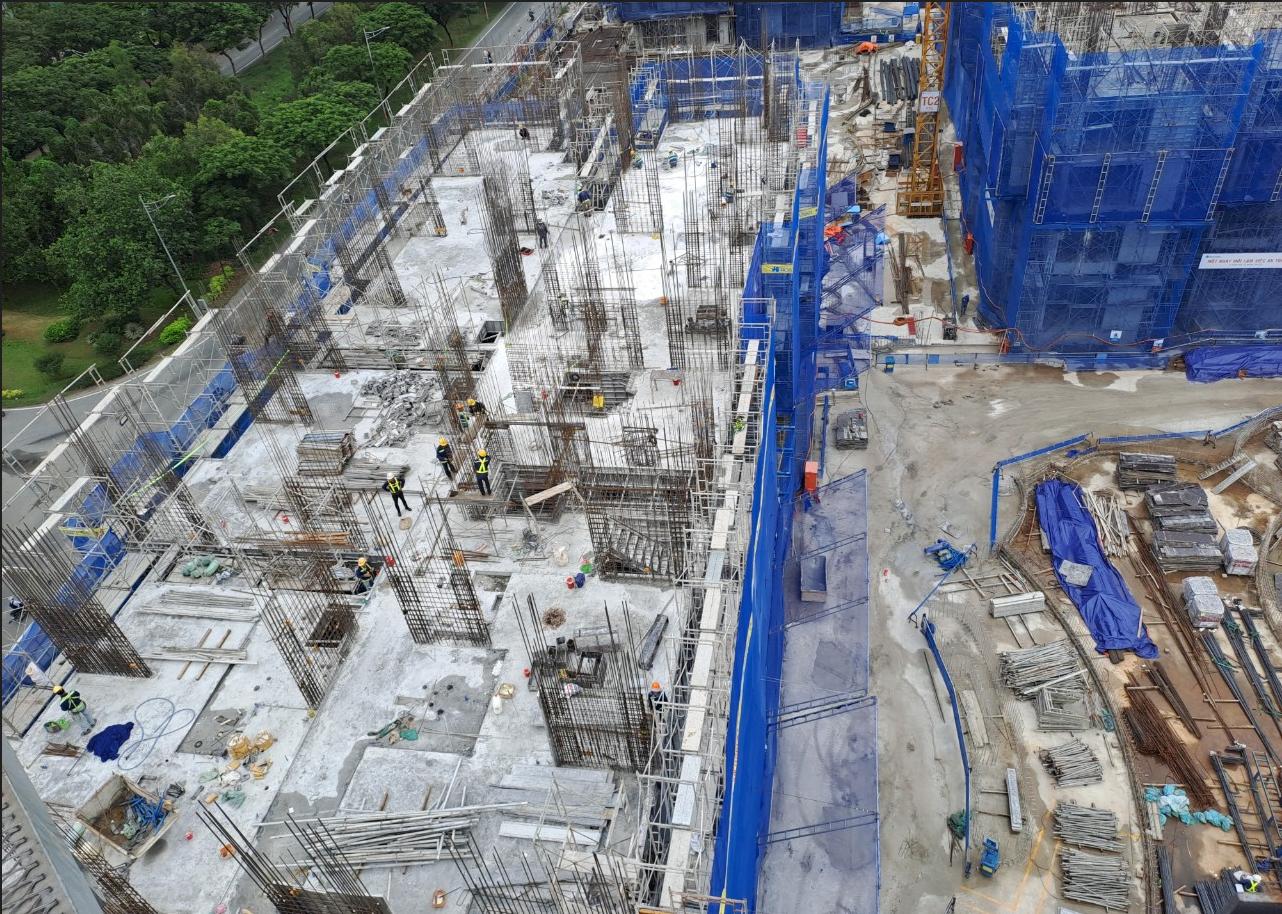

T1 - Casting was completed on Floor 4.

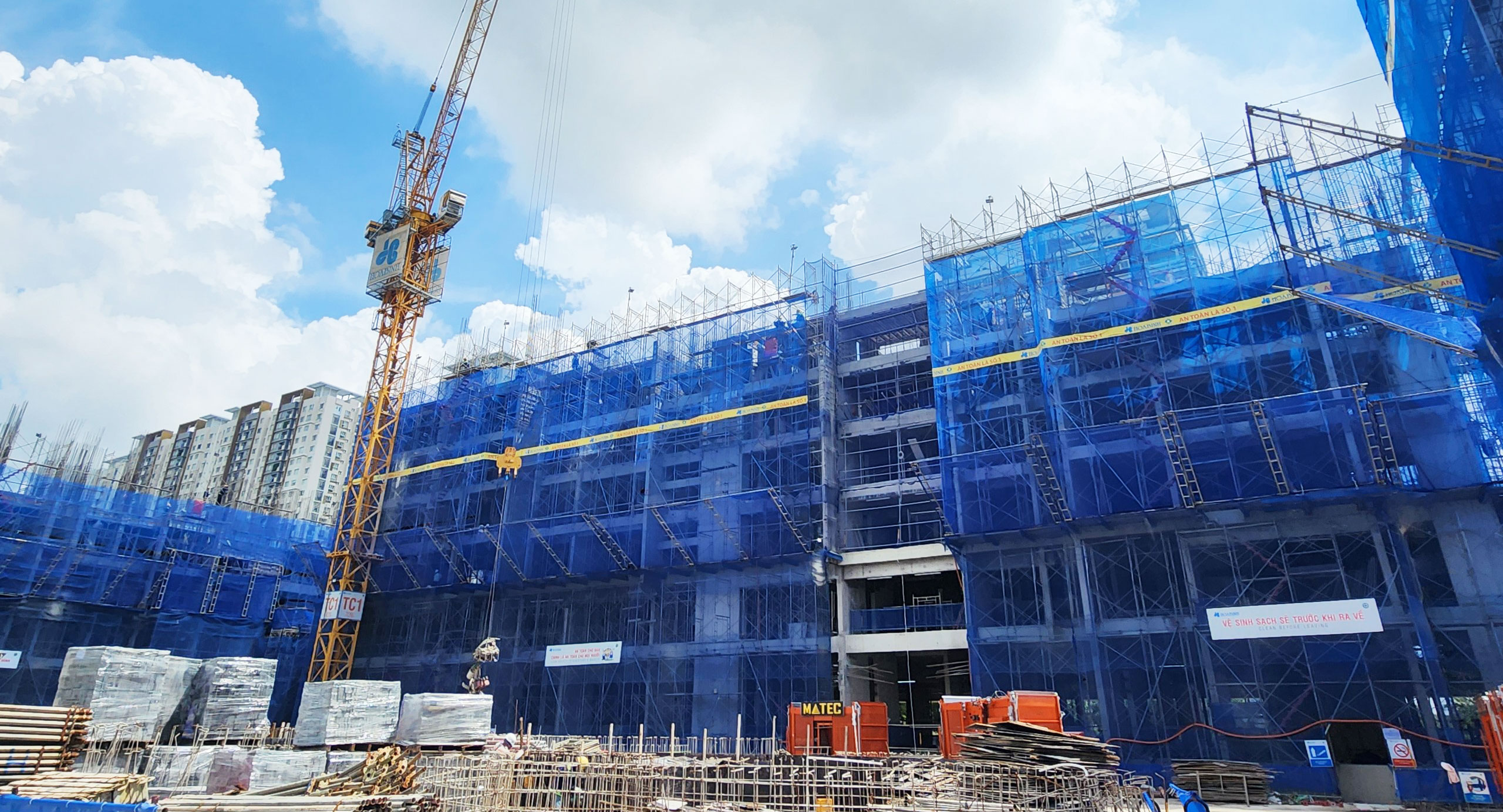

T2 - Slab was casted on Floor 5. Formwork & rebar installation is in progress for Floor 6.

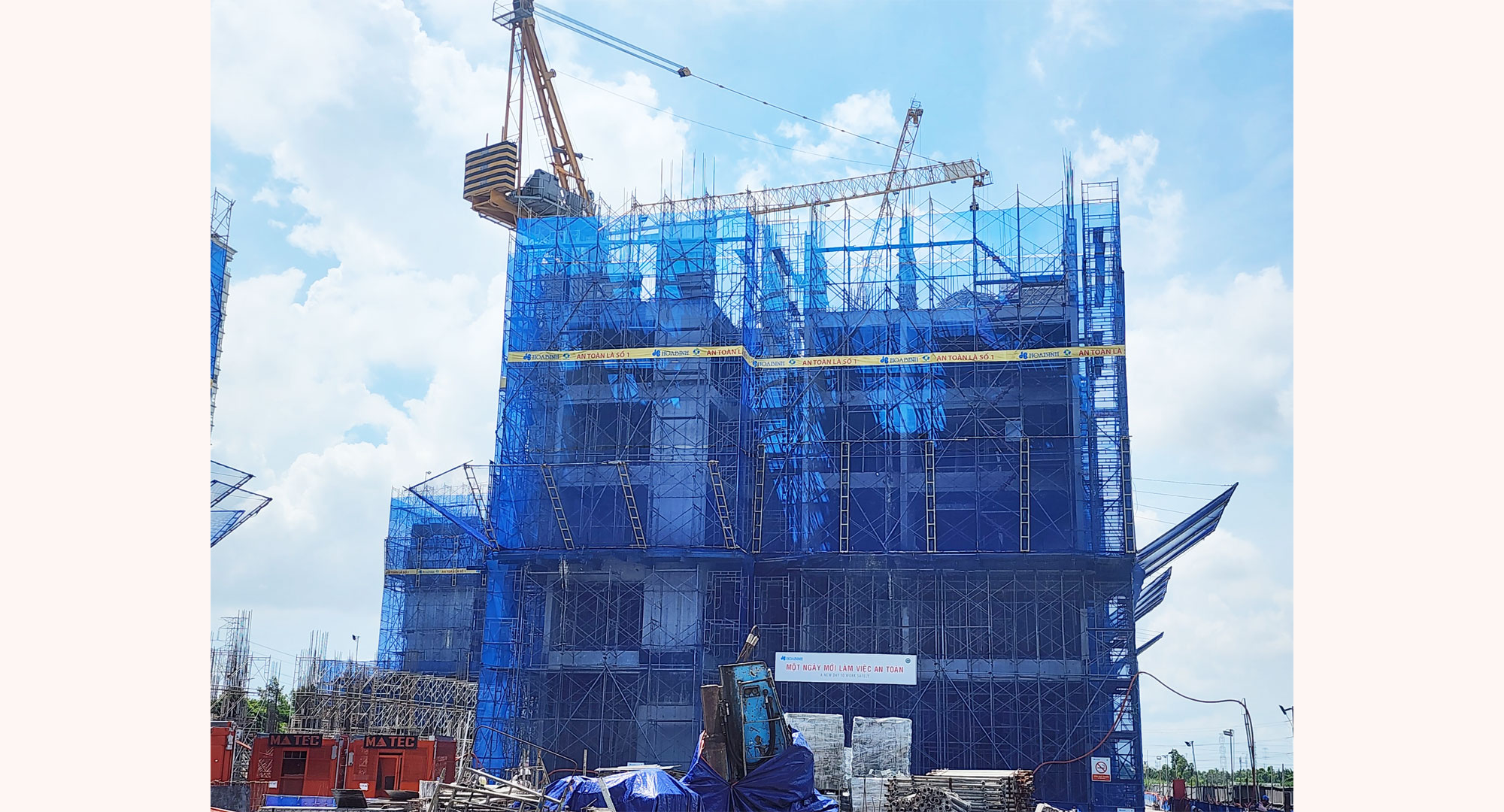

T3 - Slab was casted on Floor 5. Wall’s rebar & formwork are installing from Floor 5 to Floor 6.
T4 - Complete casting on slab of Floor 5. Formwork & rebar installation is in progress for Floor 6.

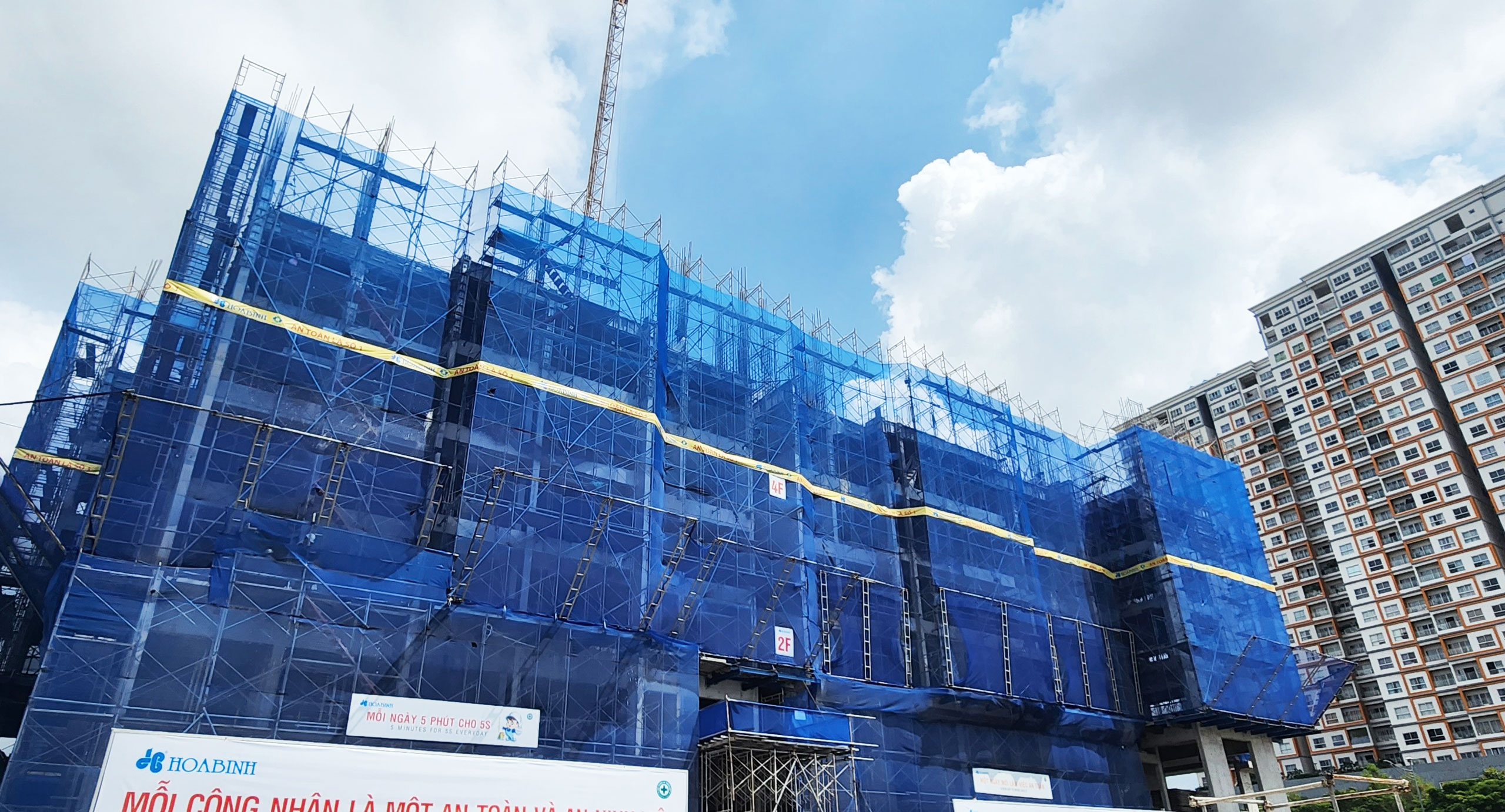

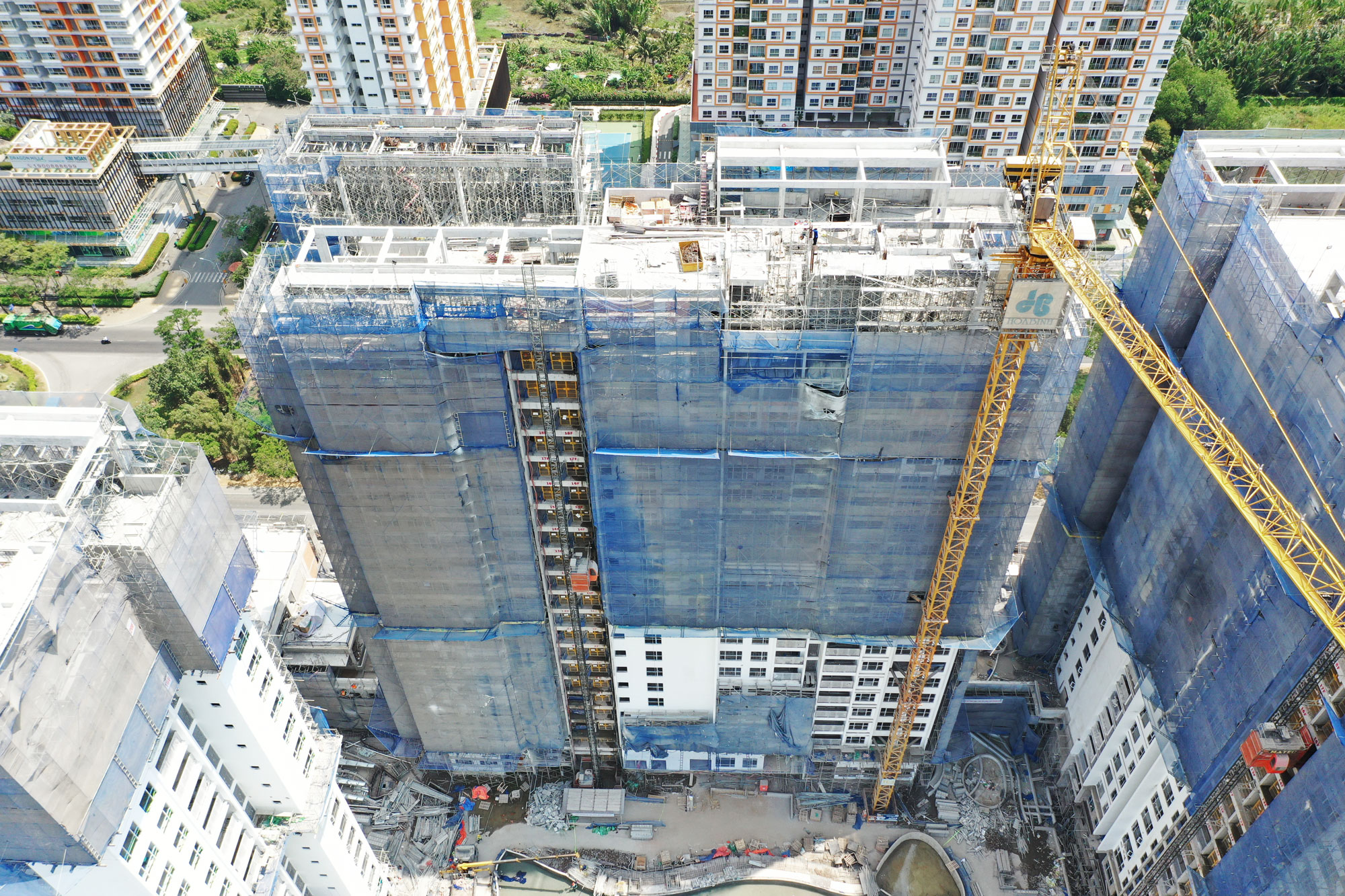

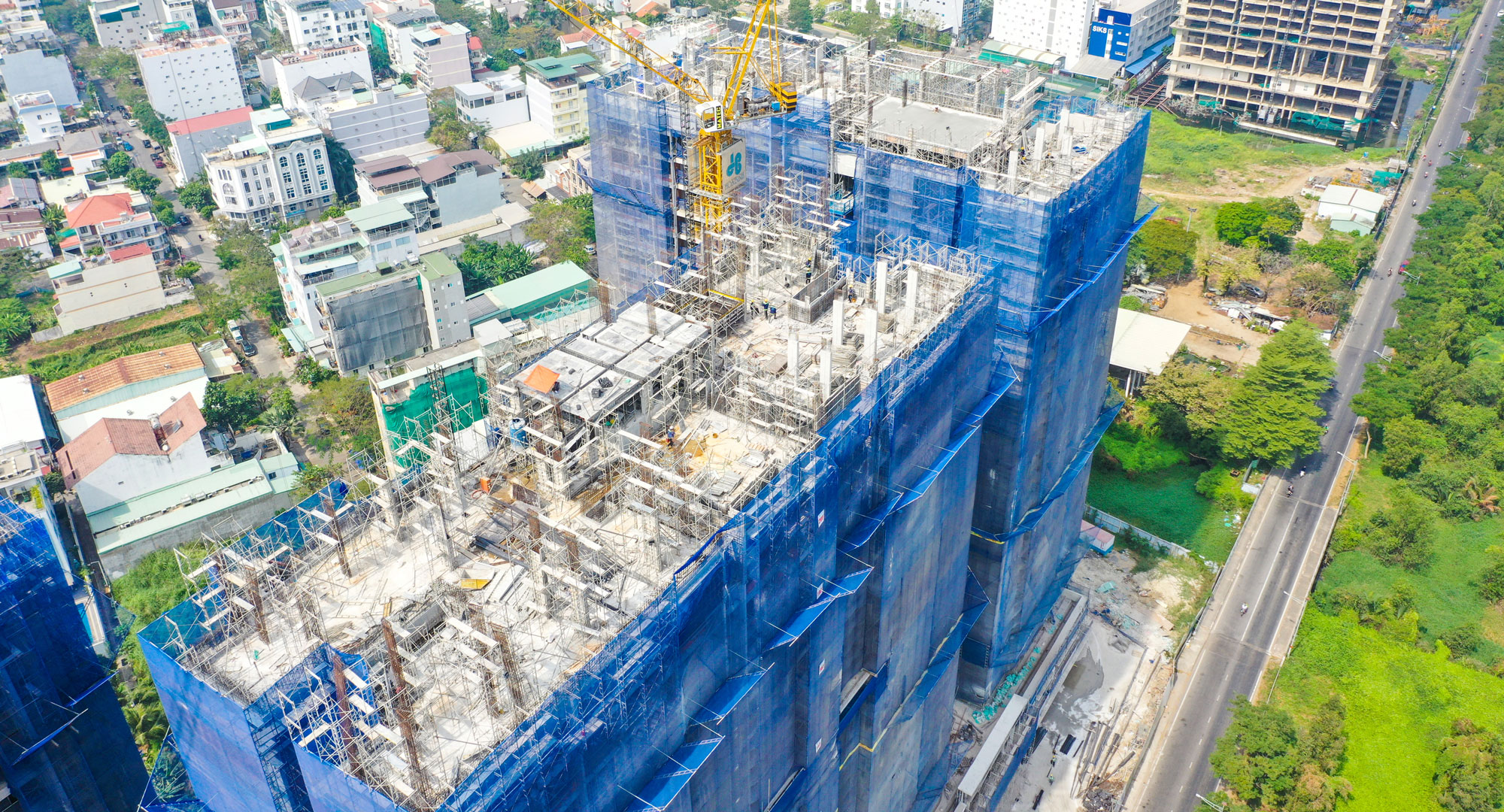

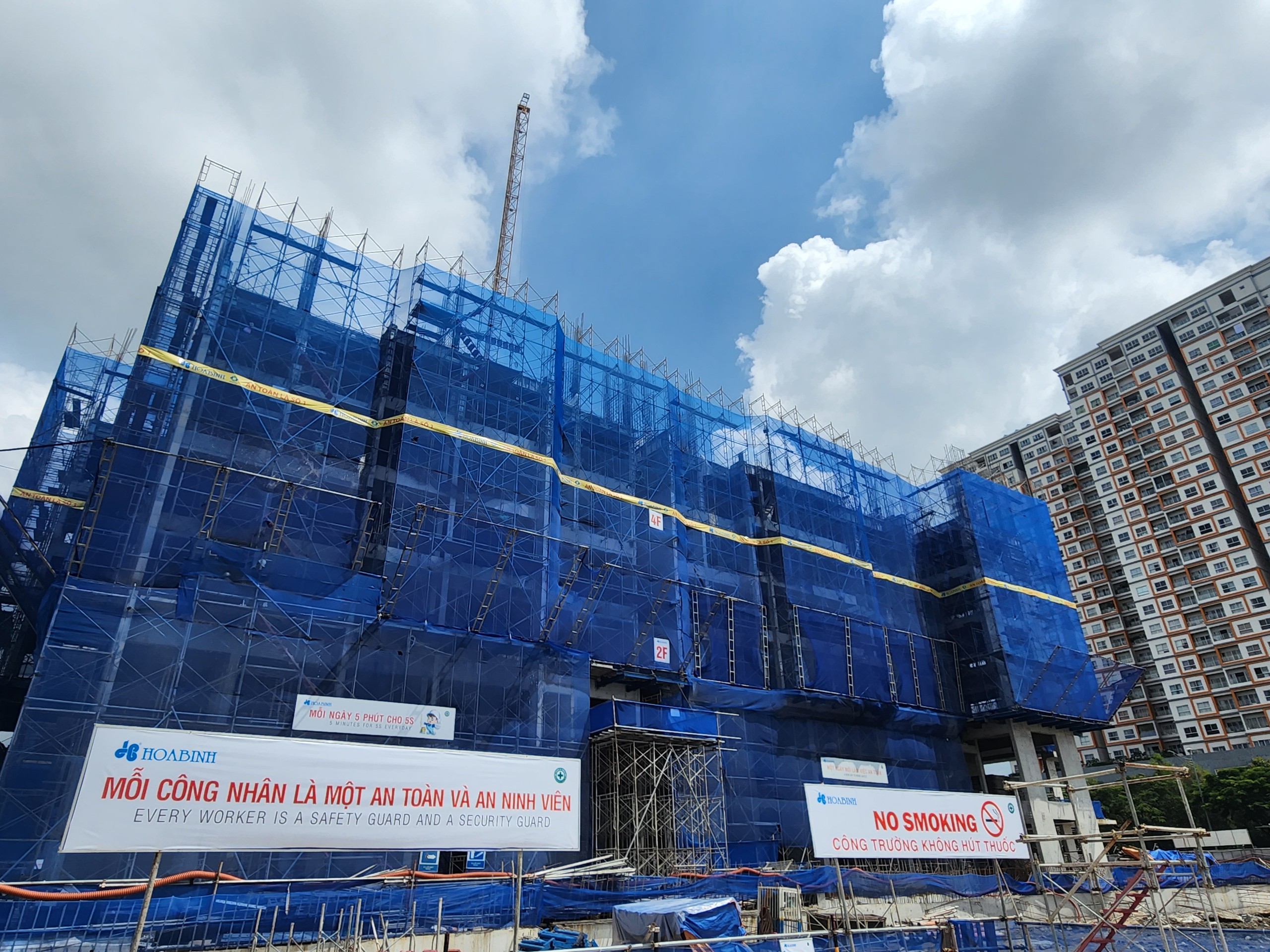

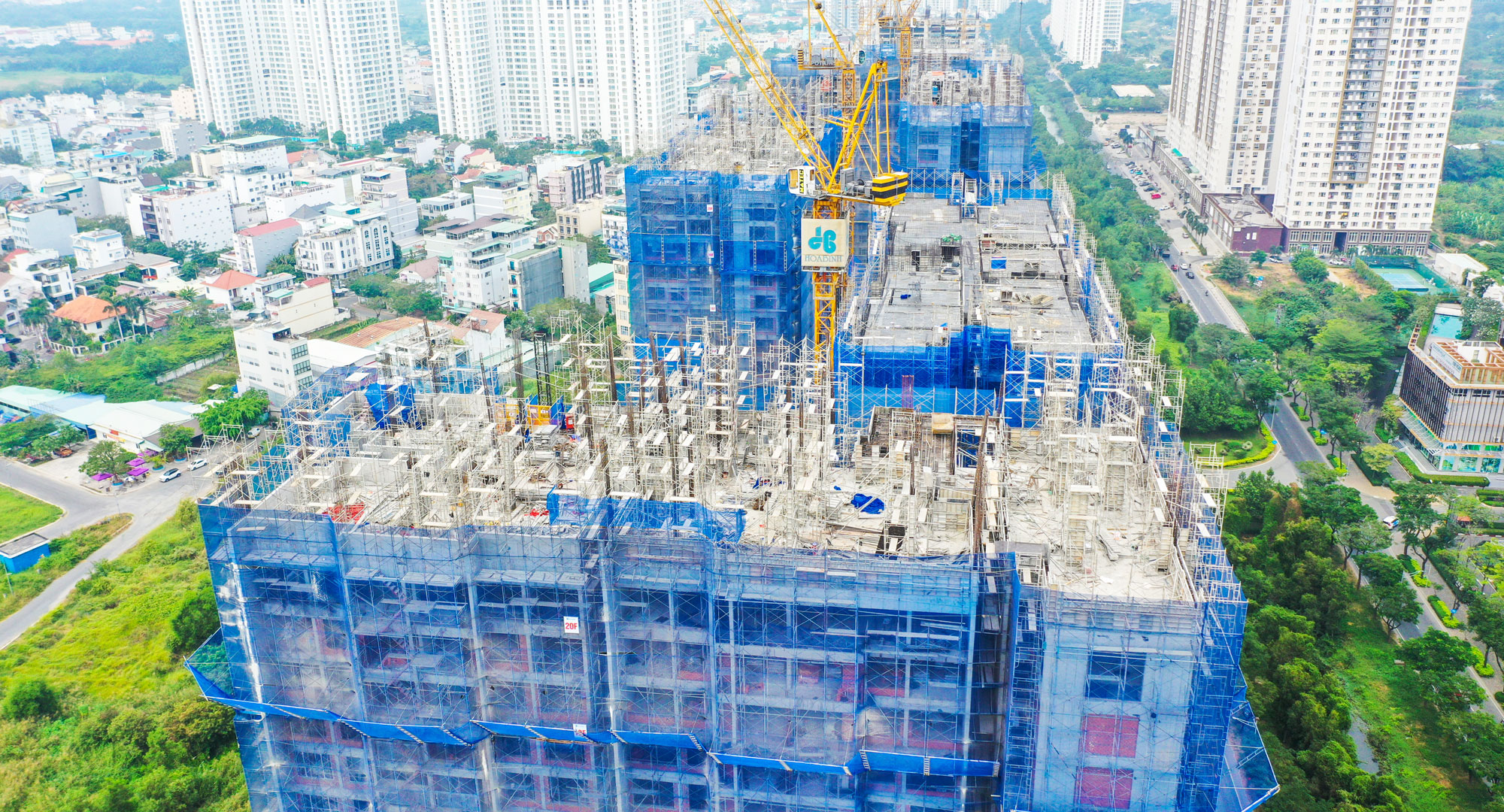

T5 - Casting was completed on Floor 6.

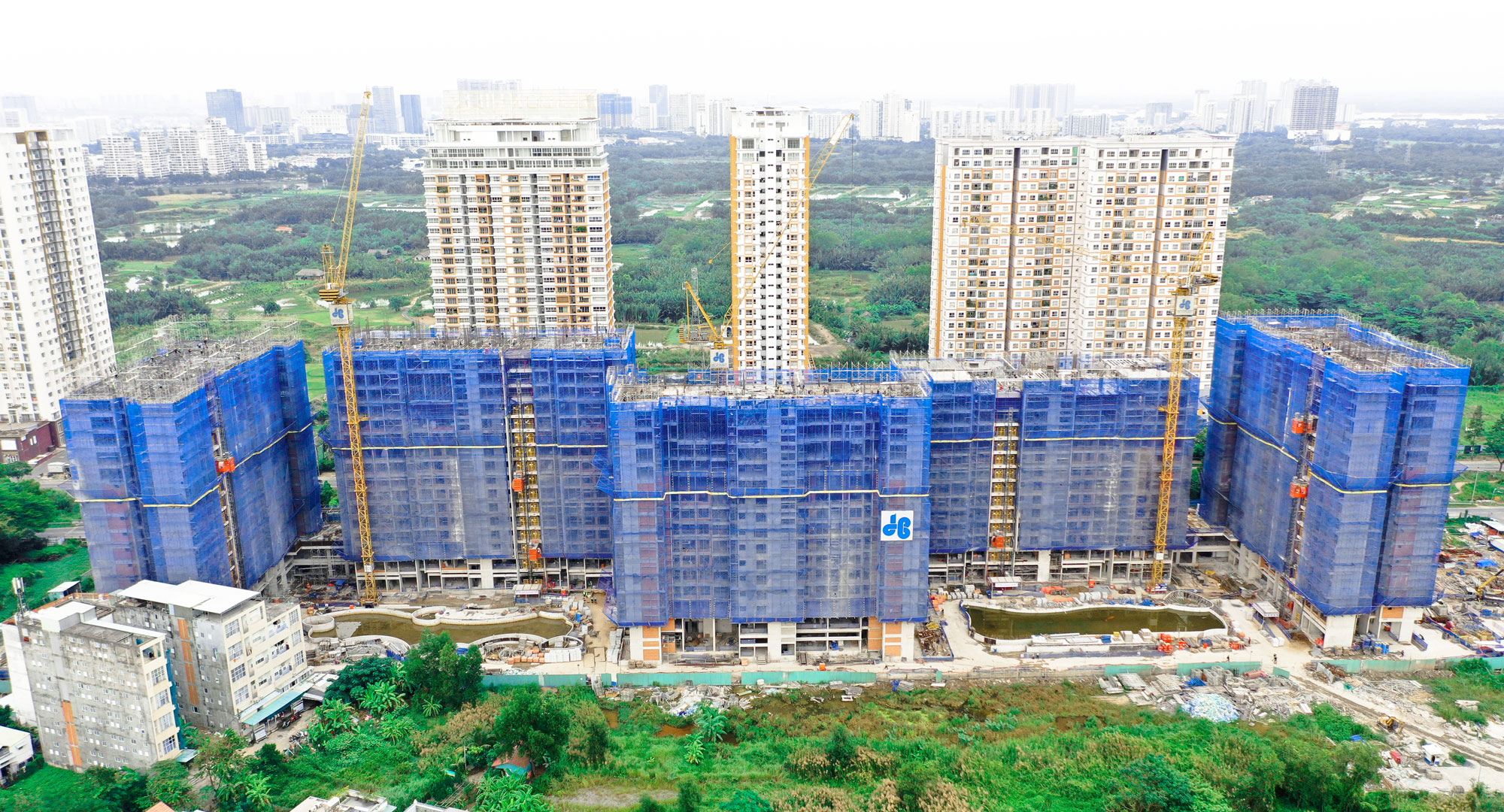

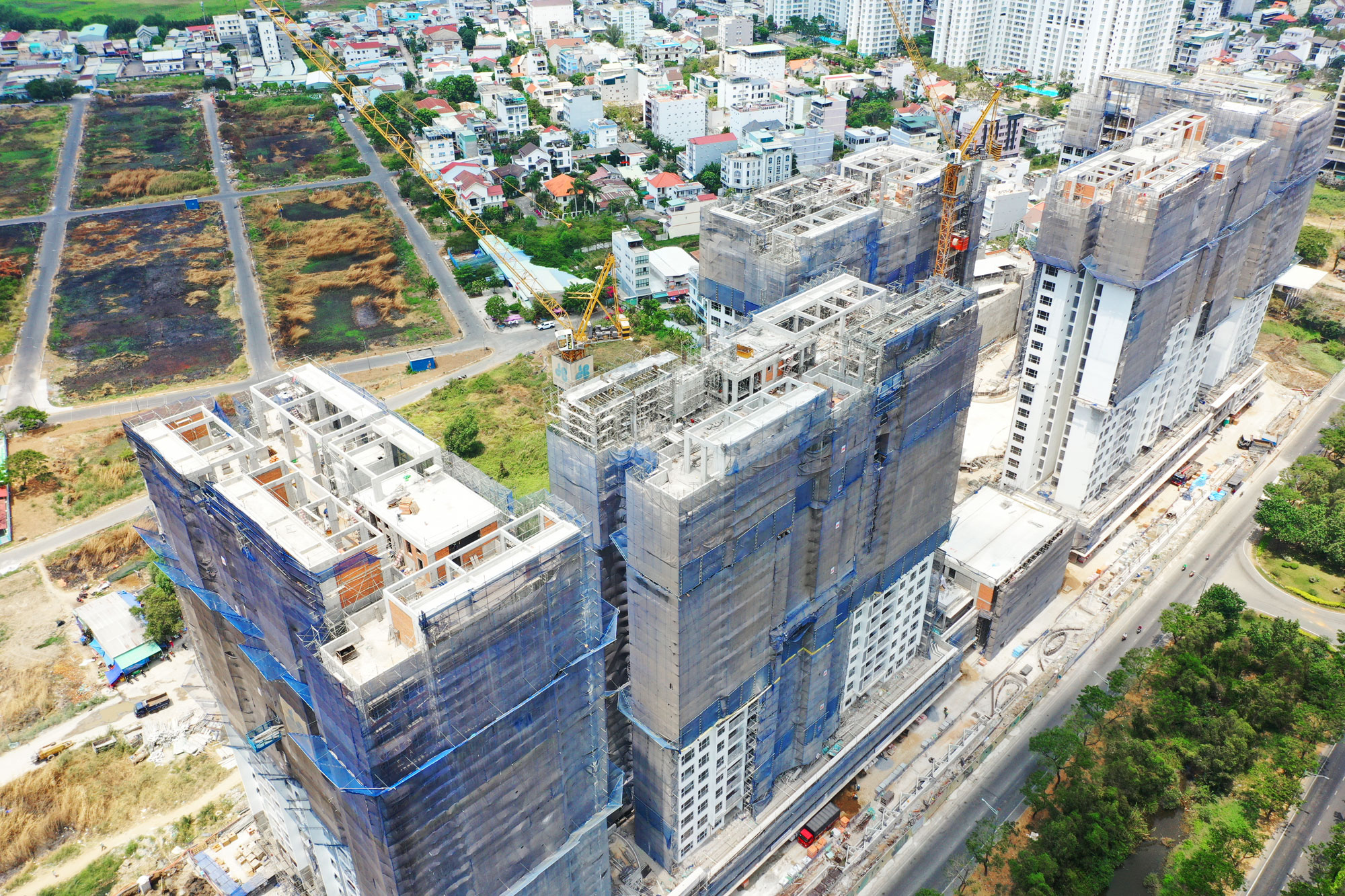

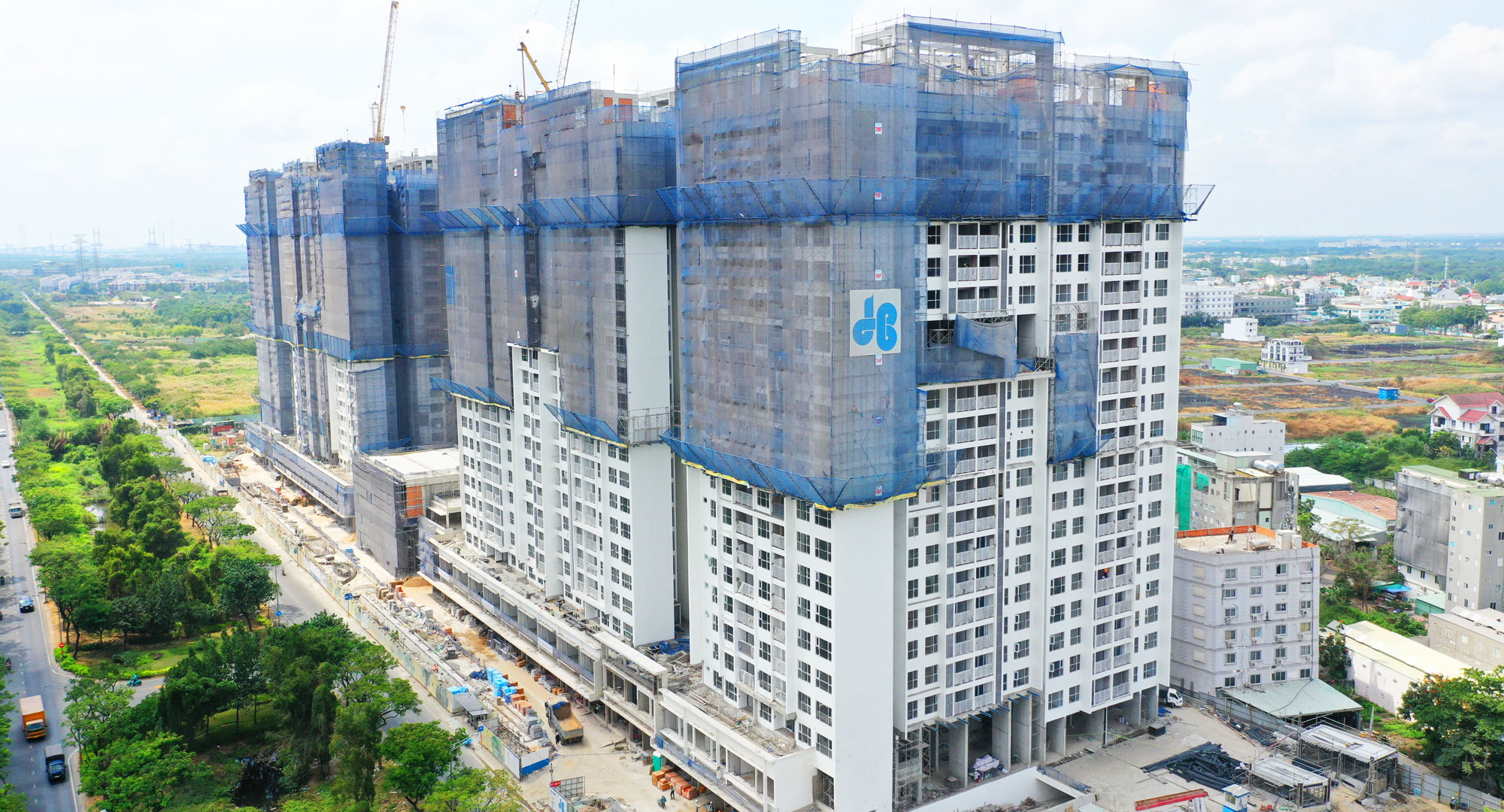

Overall view of towers 1-2-3-4

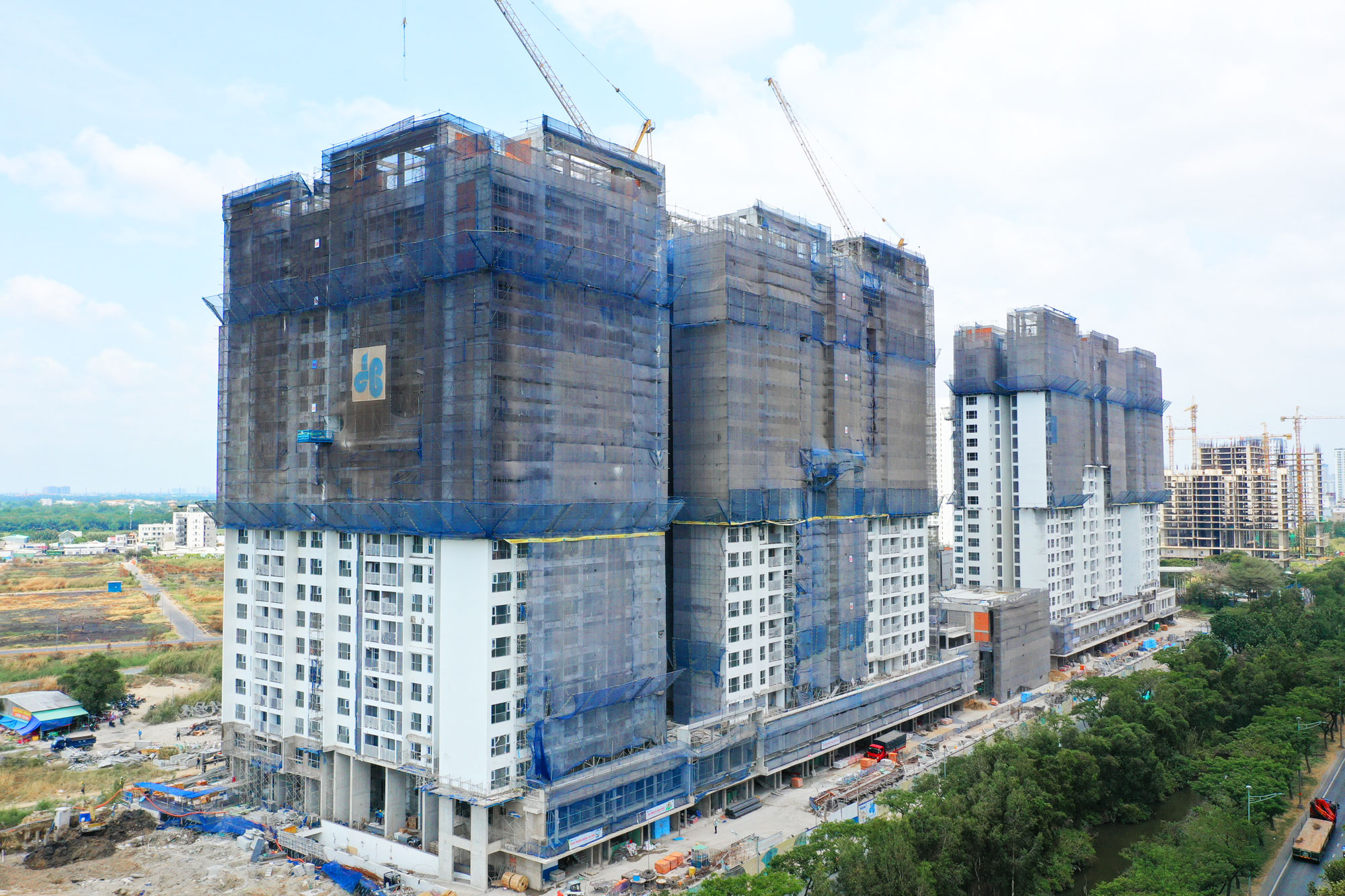

Overall view of towers 2-3-4-5

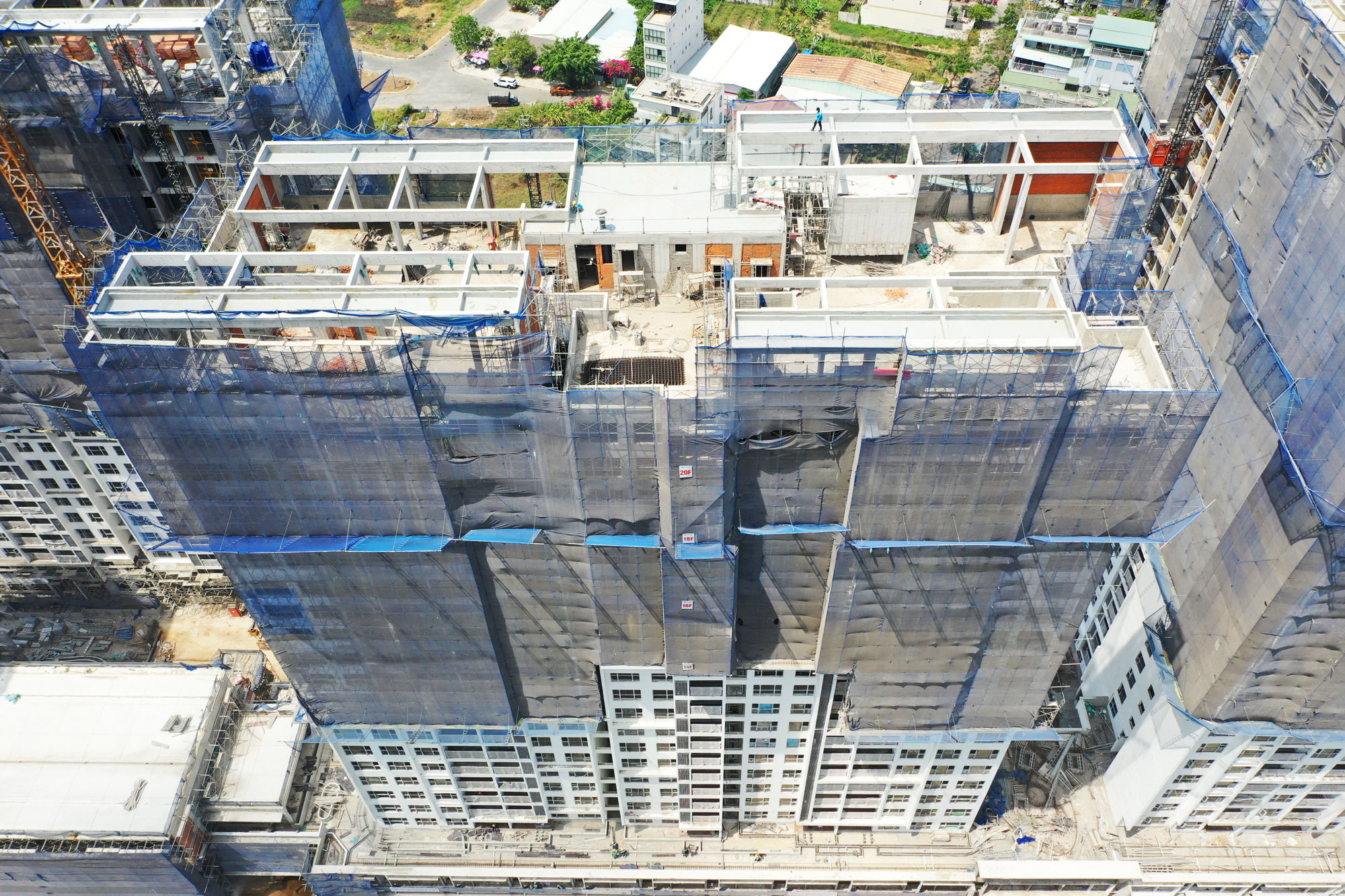

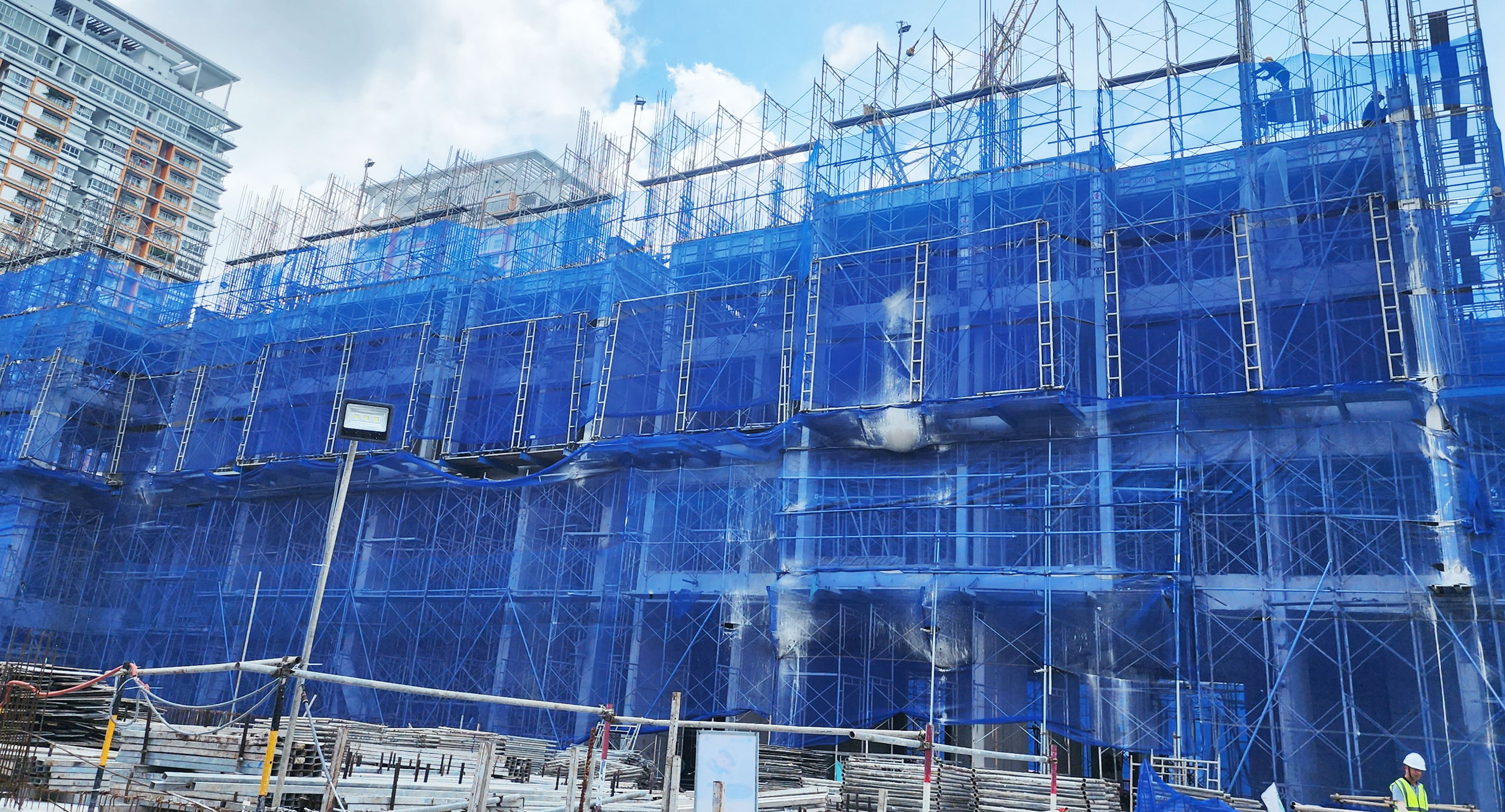

Tower 1: Casting works for floor L4 is completed

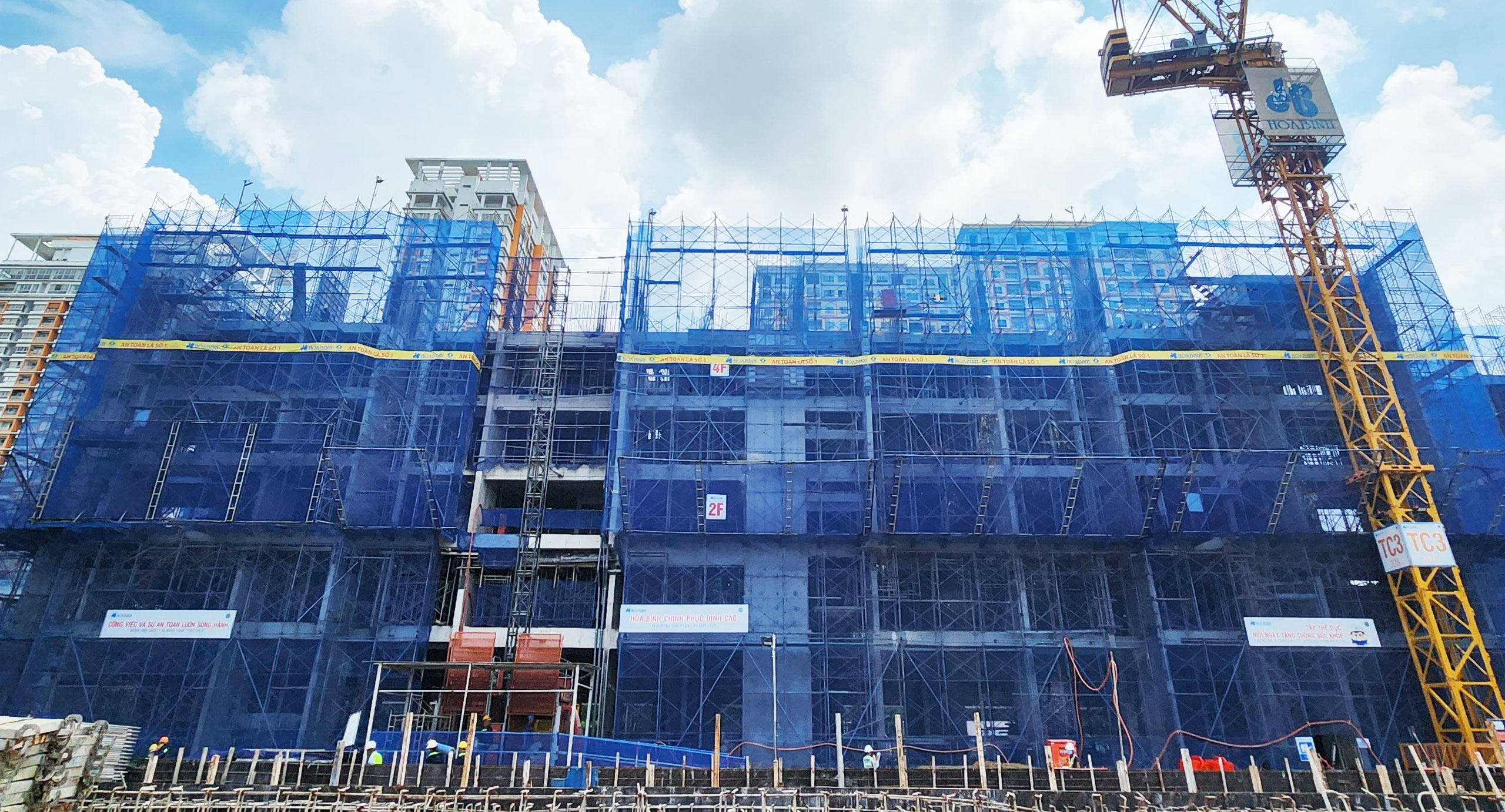

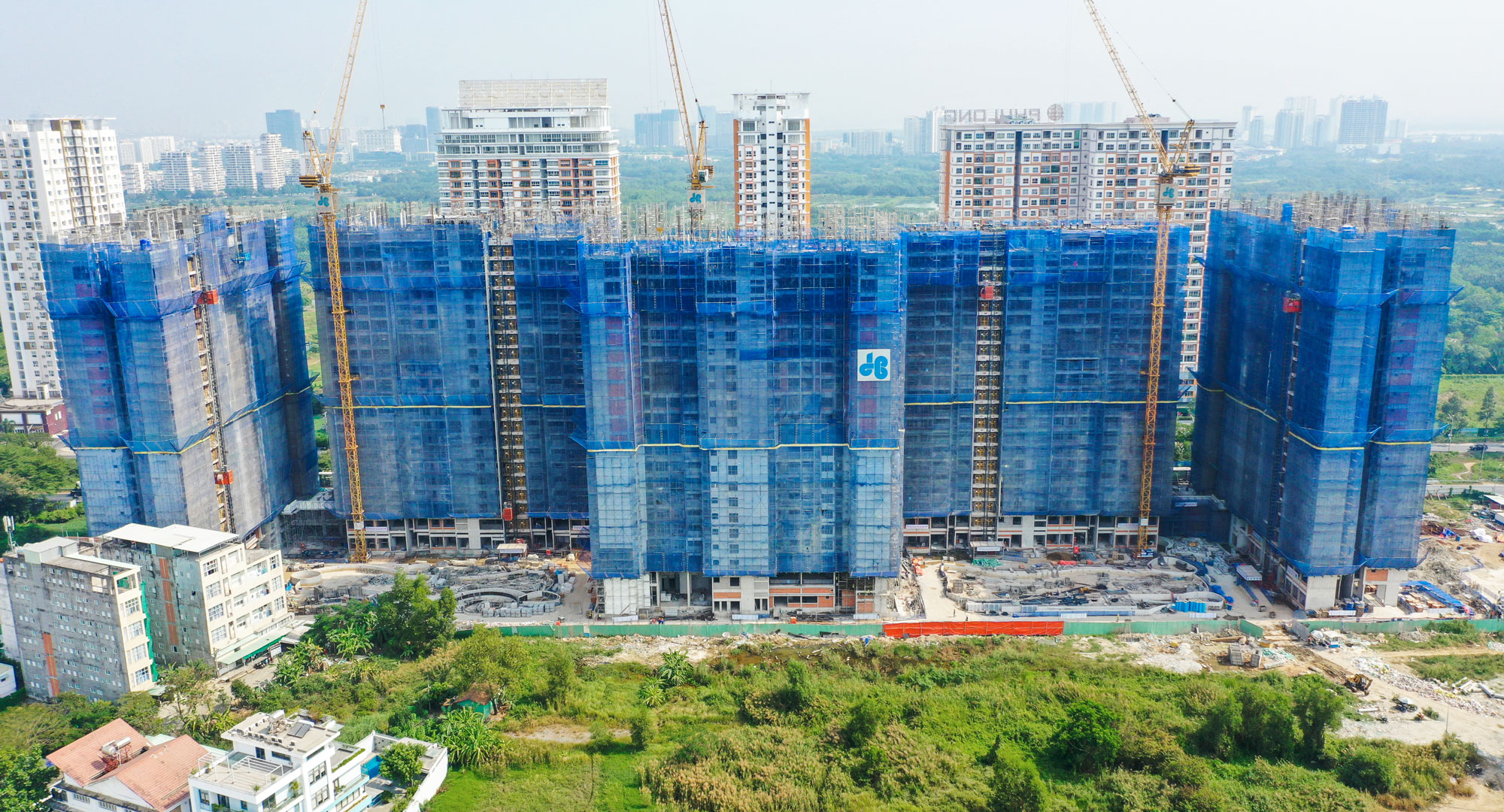

Tower 2: Casting works for floor L5 is completed. Formwork and rebar installation for floor L6 are in progress.
Tower 3: Casting works for floor L5 is completed. Formwork and wall's rebar installation from floor L5 to L6 are in progress.
Tower 4: Casting works for floor L5 is completed. Formwork and rebar installation for floor L6 are in progress.

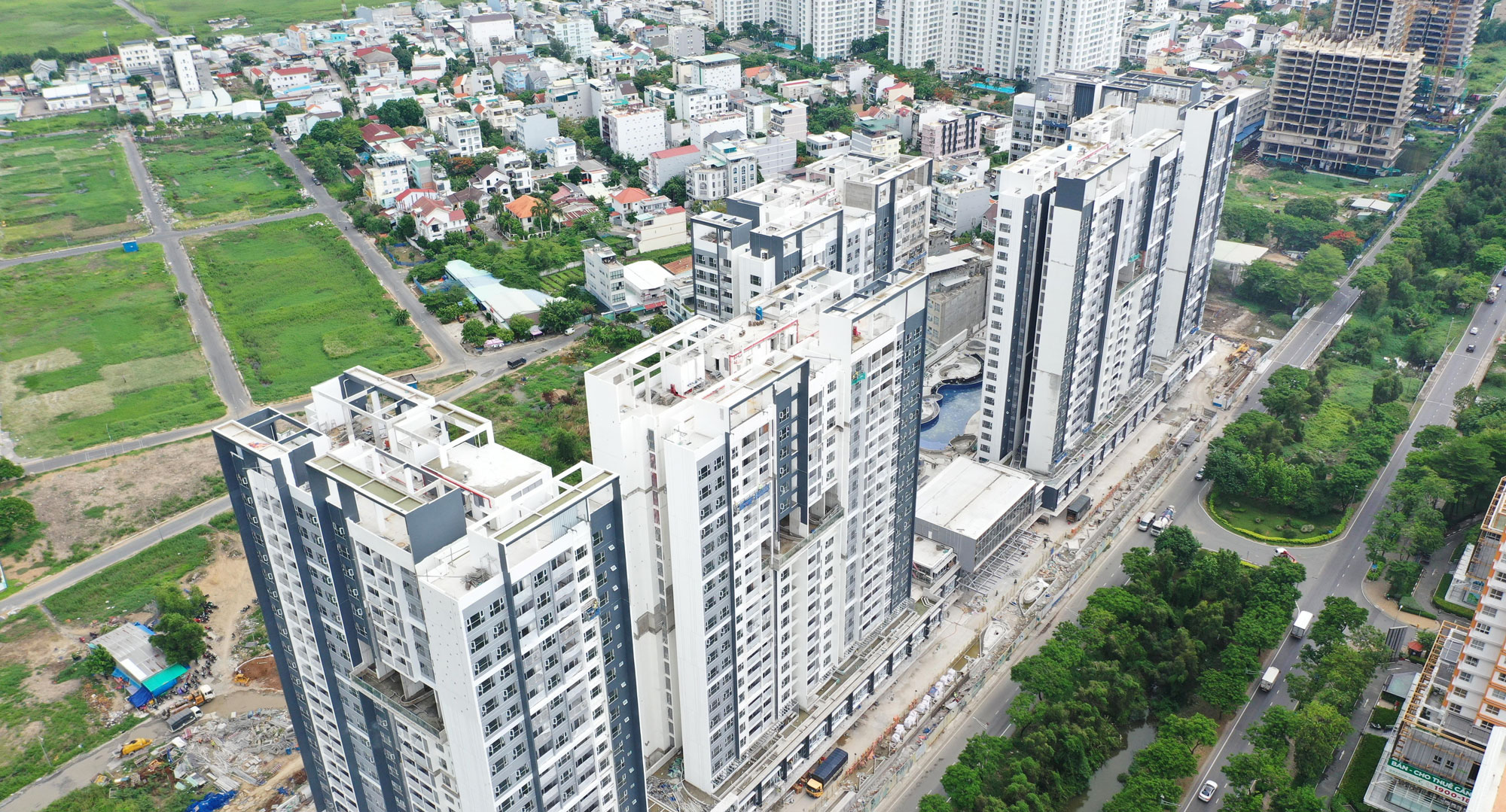

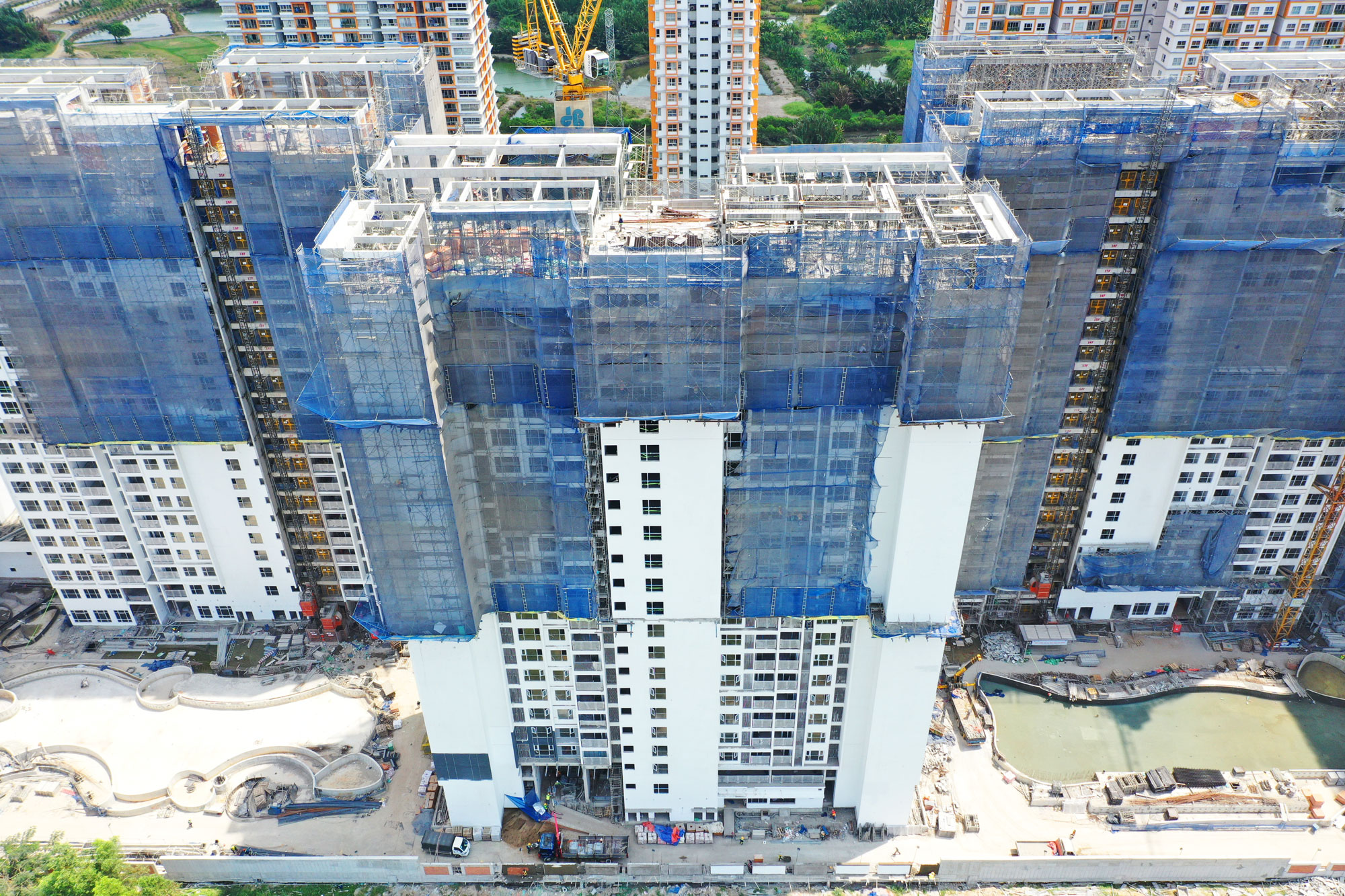

Tower 5: Casting works for floor L6 is completed
